The Sanctuary House

The Sanctuary House · Build Story

From Bare Desert to a Healthy Home

The Sanctuary House in Catalina, Arizona, phase by phase: the site and foundation, insulated concrete form walls, the roof, shielding and insulation, the health systems, and the testing that verified it all before move-in.

Phase 01

Site and Groundwork

The lot on its hill below the Santa Catalina Mountains, cleared, graded, and trenched for footings.

The lot before work began, with the Catalinas behind.

The building pad cleared.

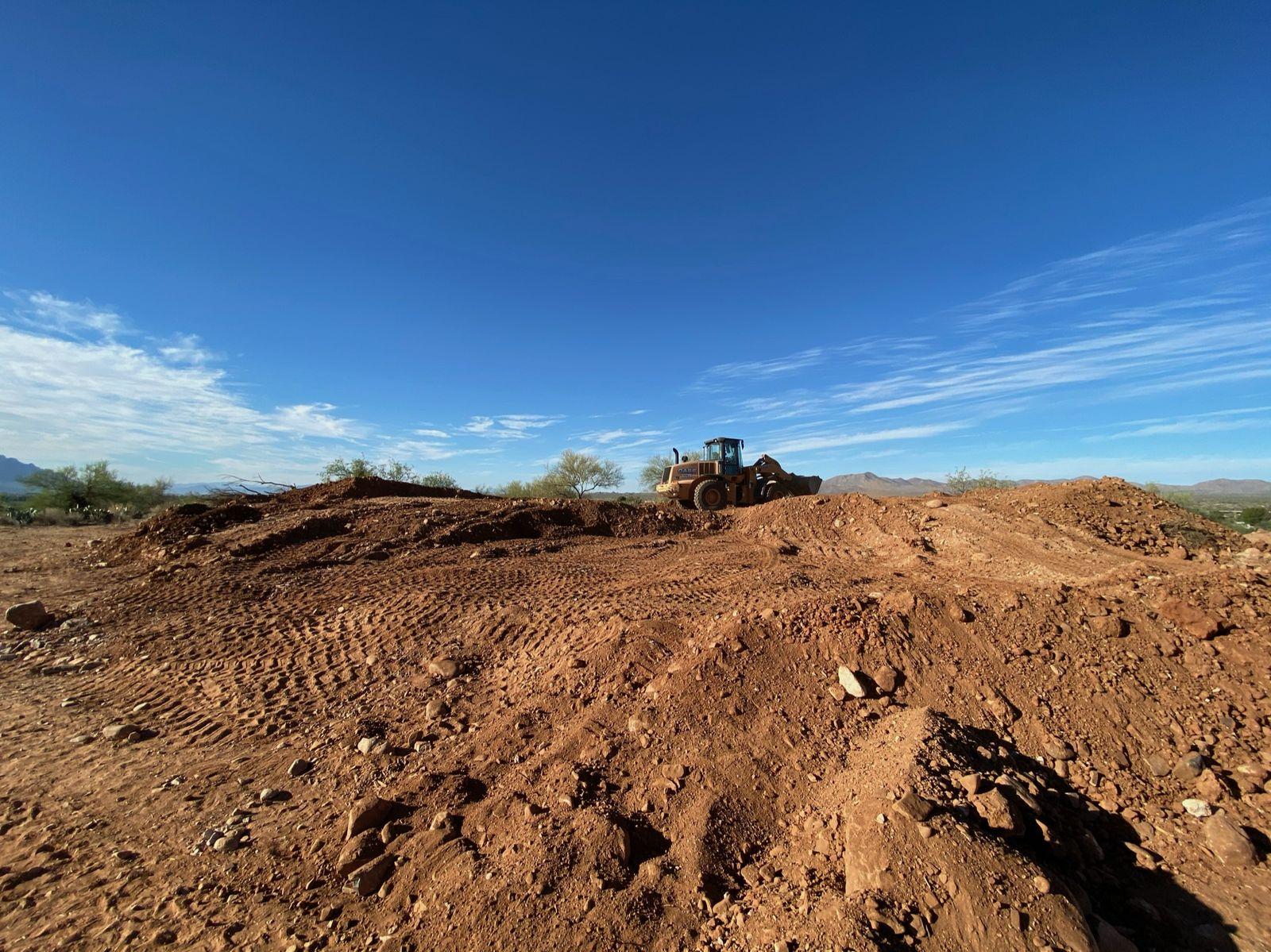

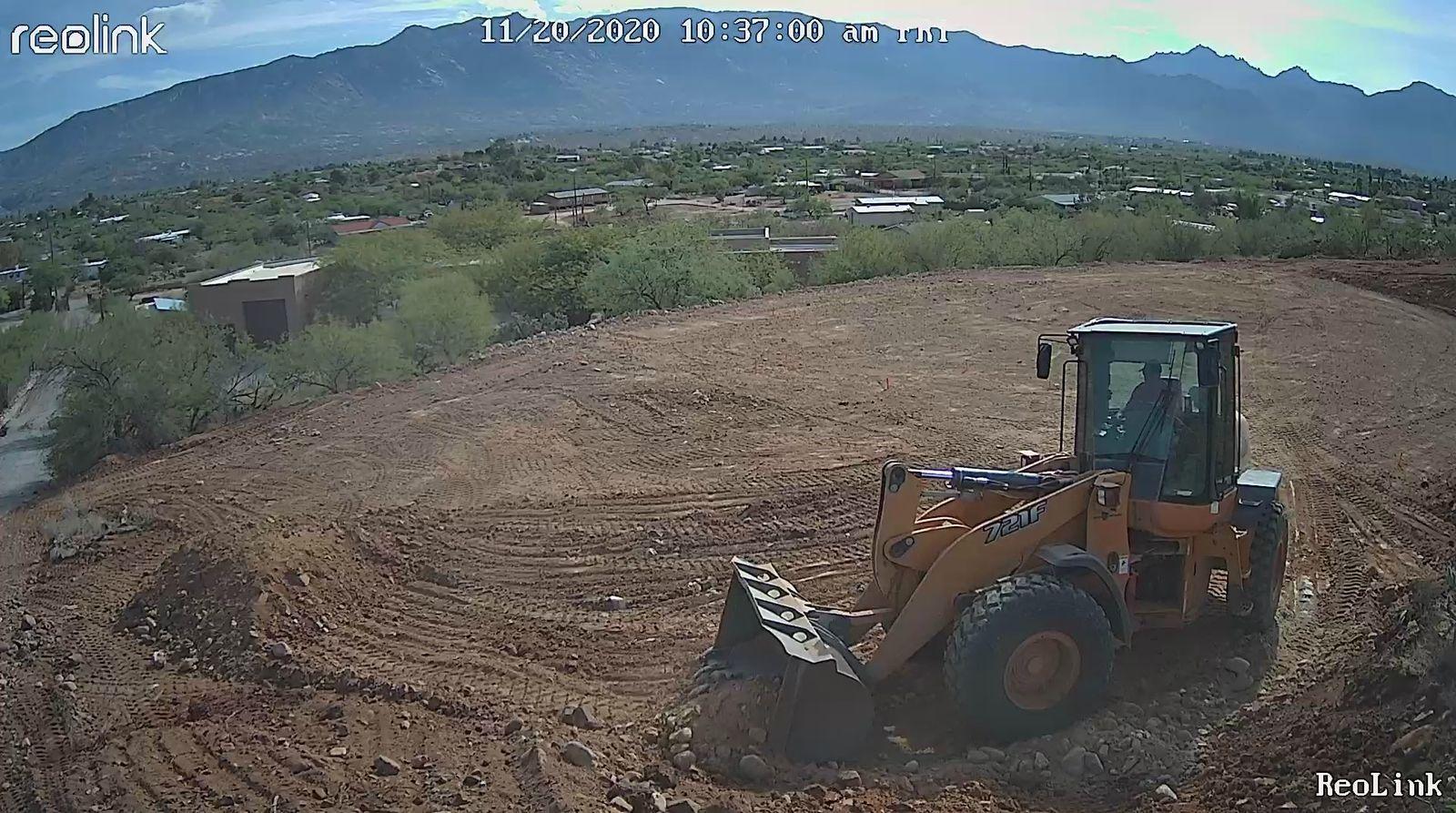

Grading the pad.
The finished pad, ready for layout.

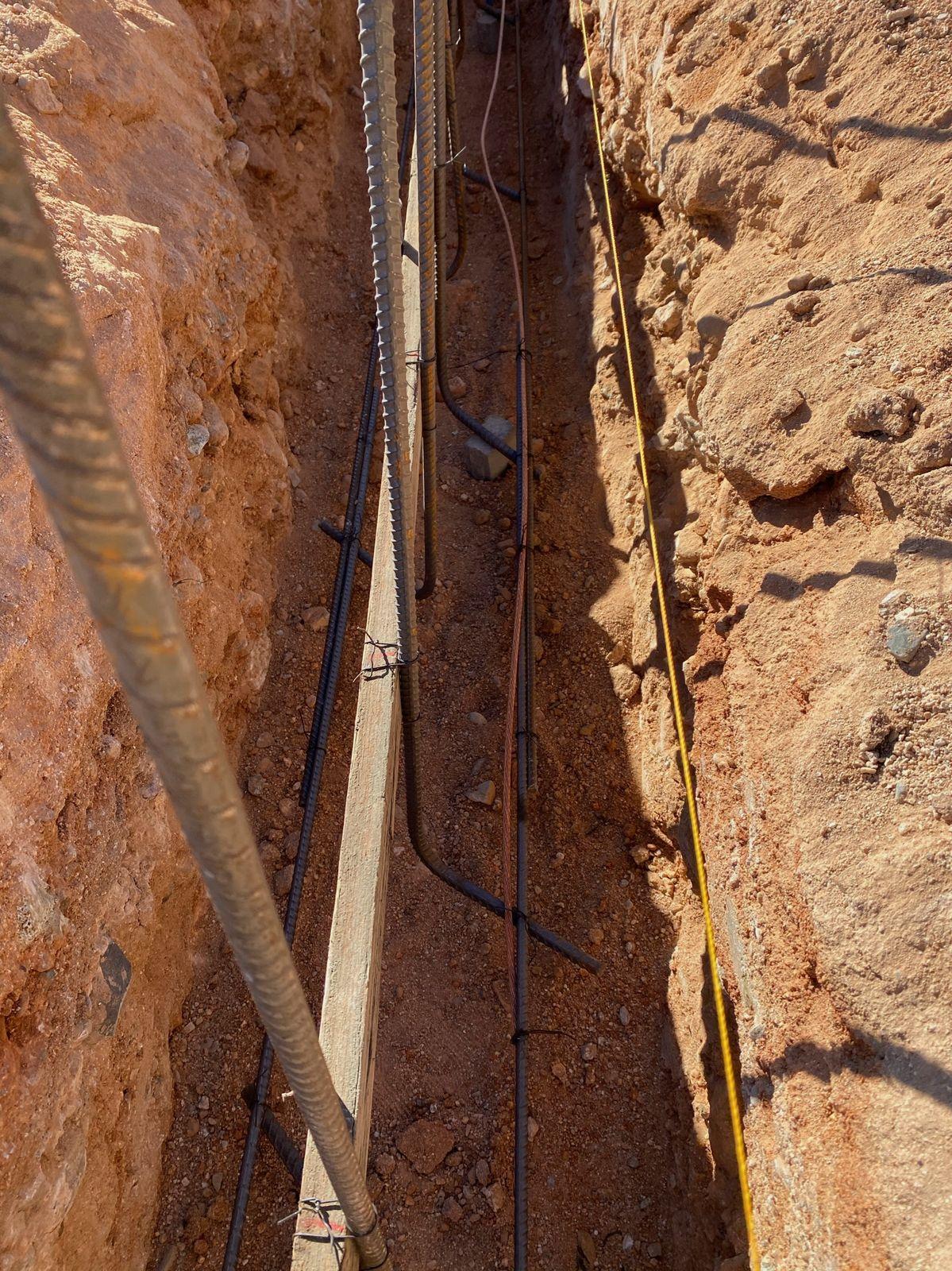

Footing trenches with the rebar set.

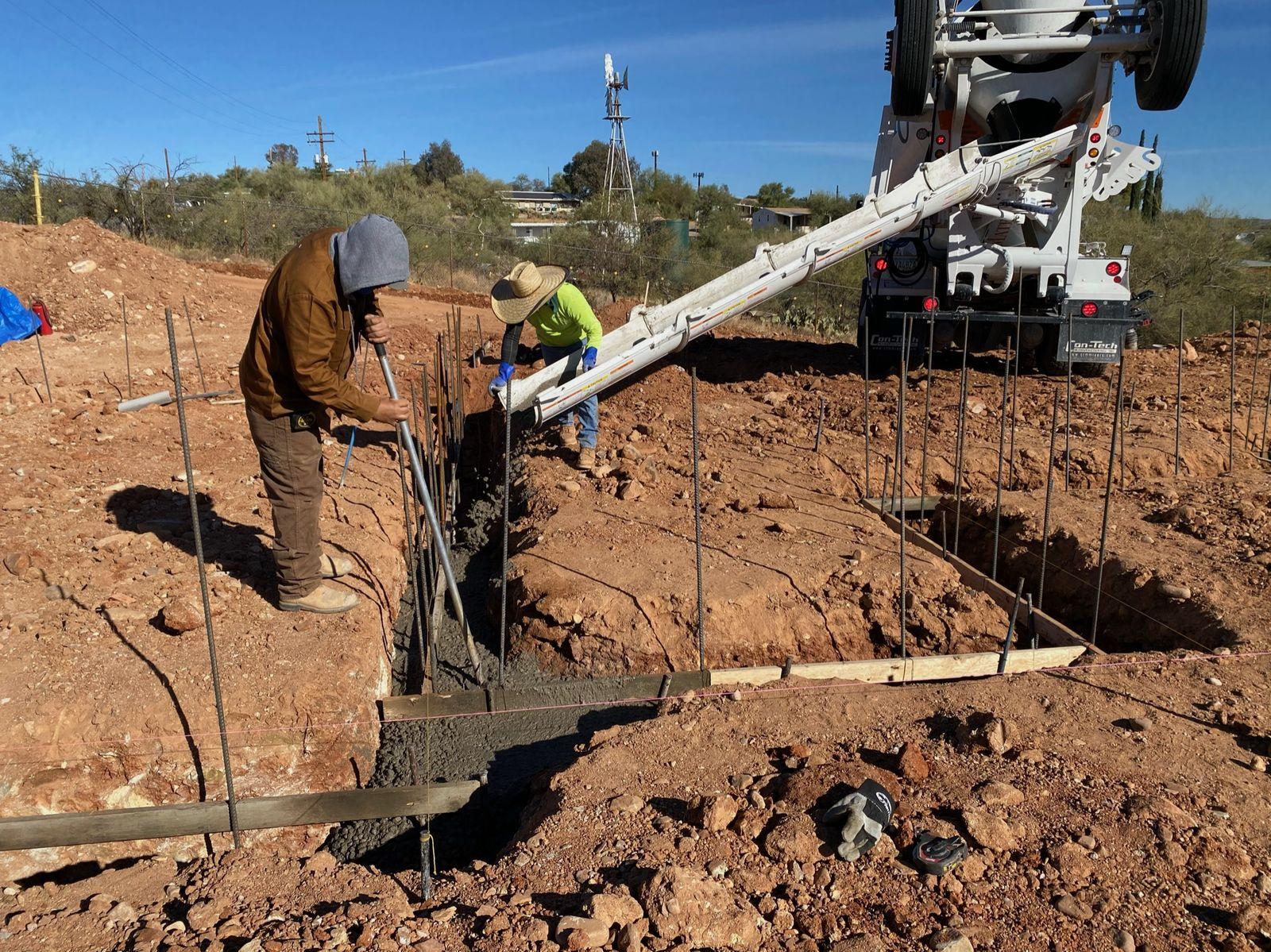

Pouring the footings.

Phase 02

Foundation

The slab is formed, reinforced, and poured in one long day.

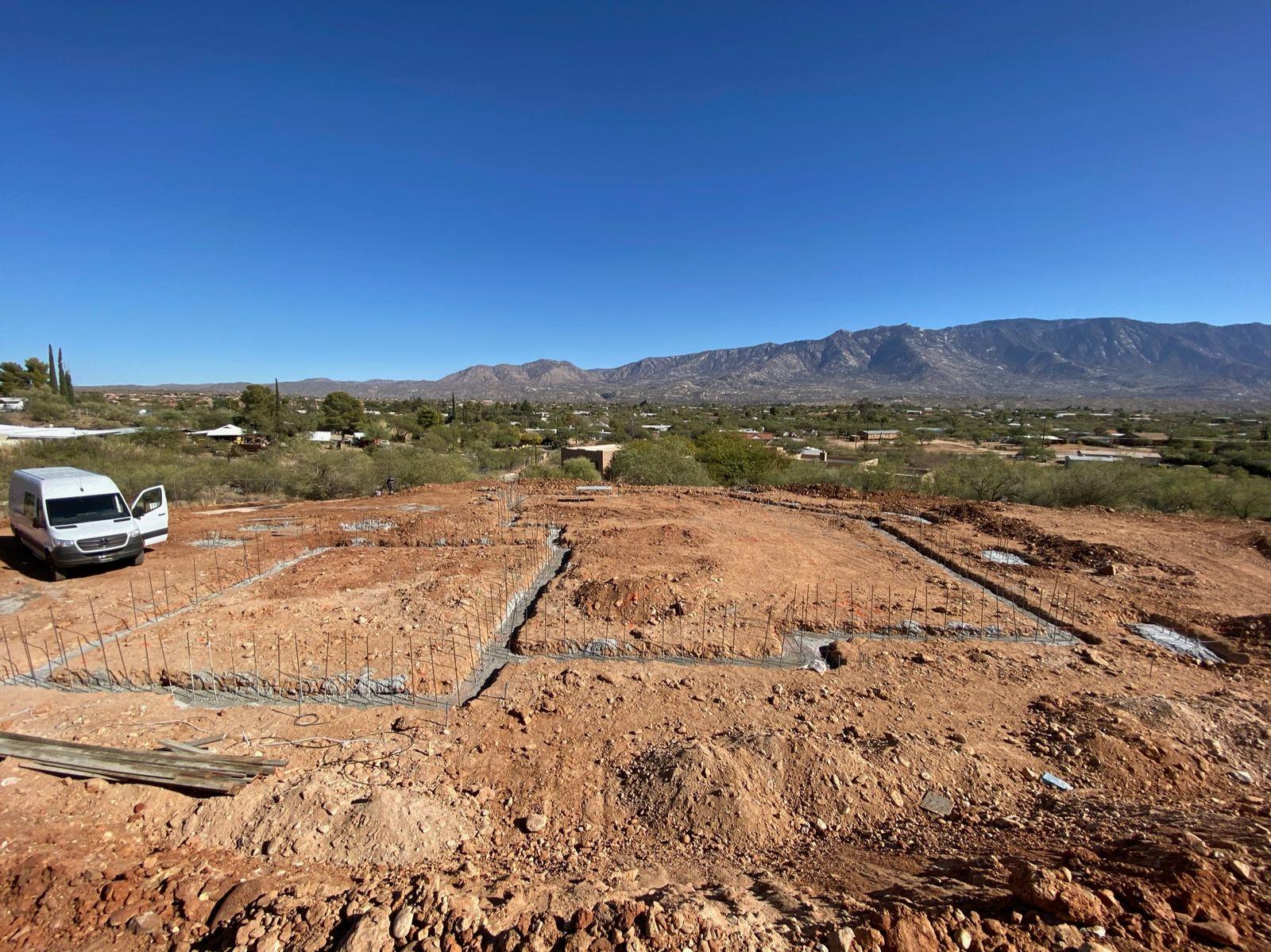

Slab forms laid out on the pad.

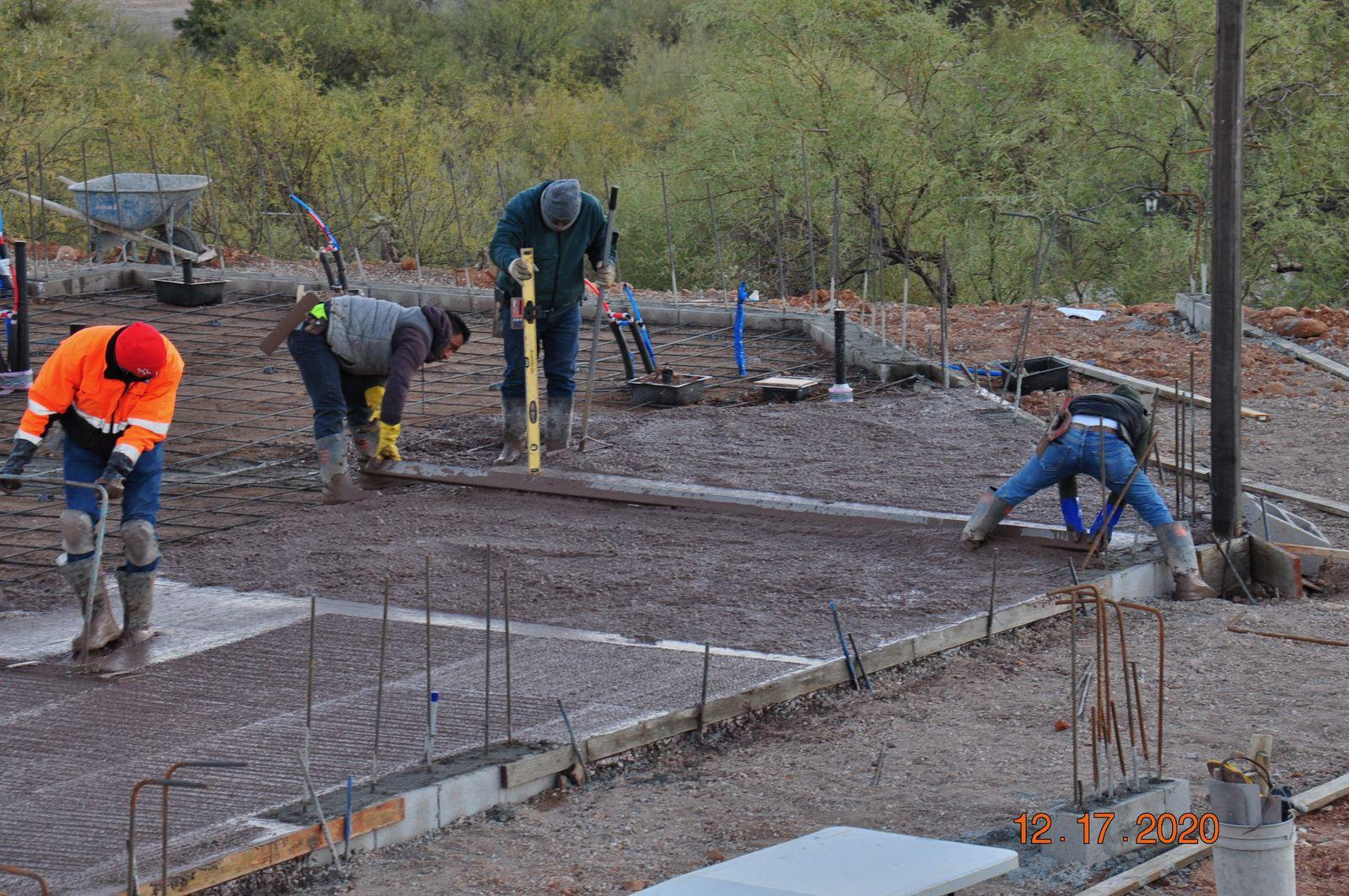

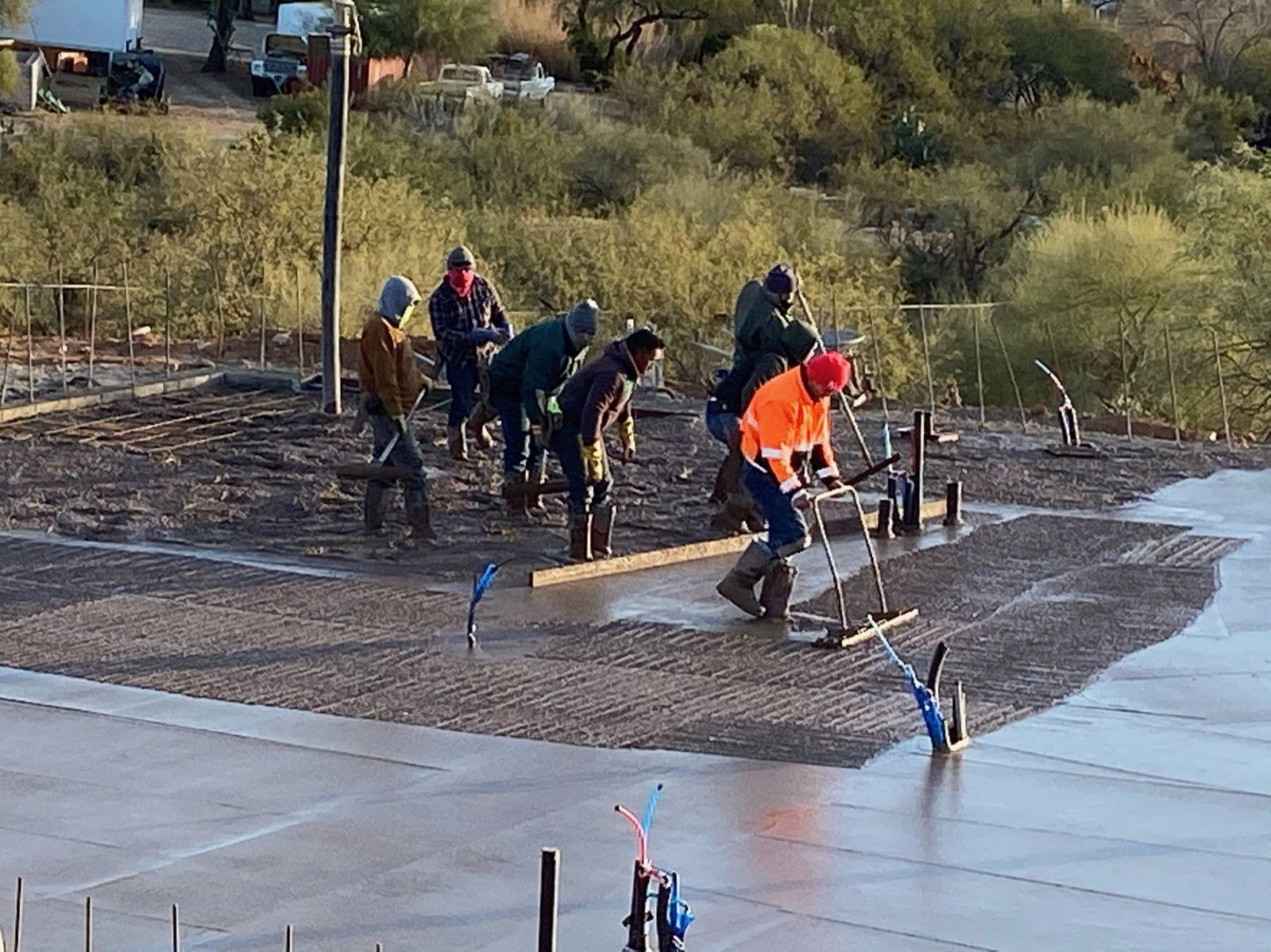

The crew working the pour.

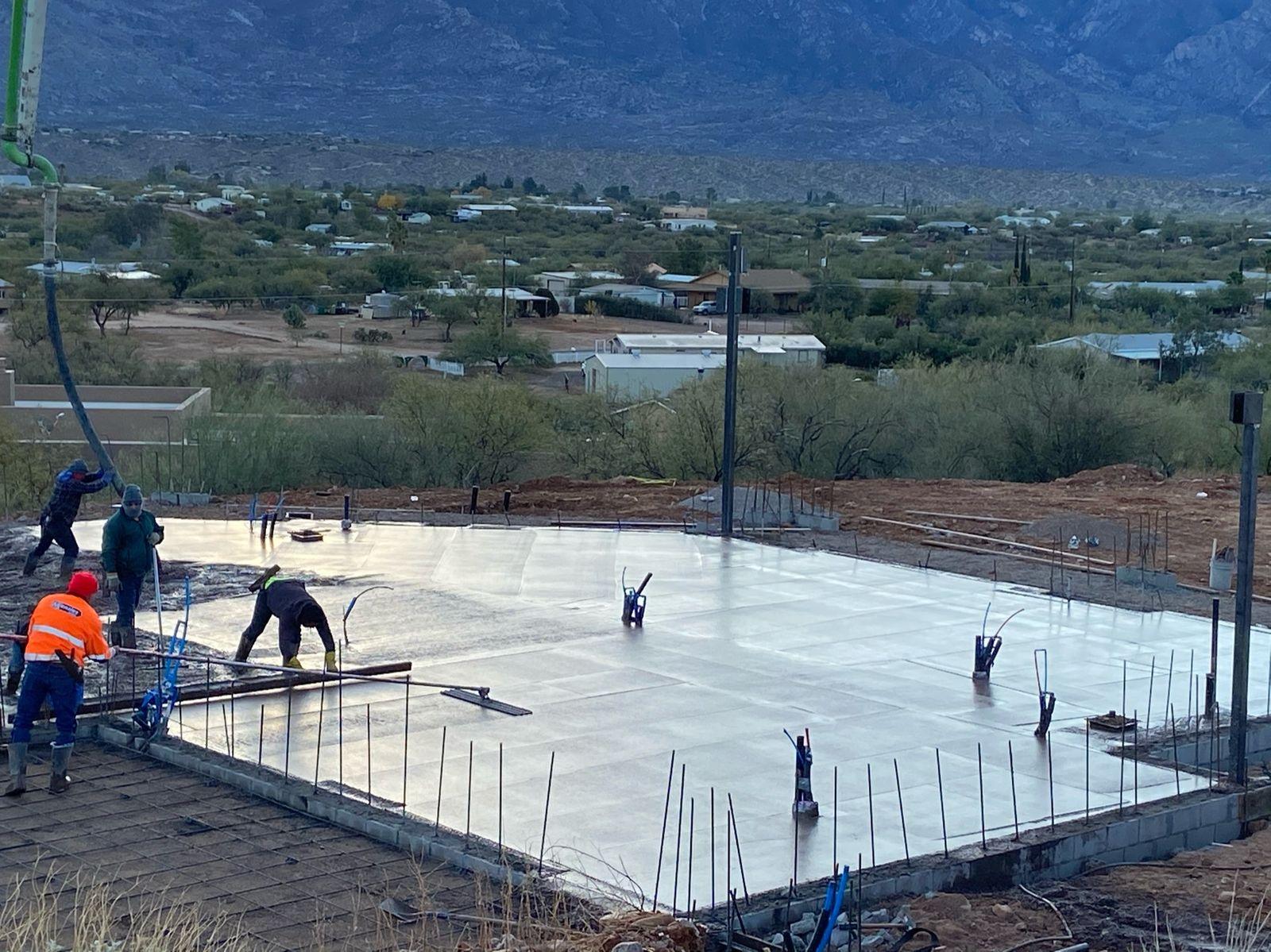

Concrete placed across the slab.

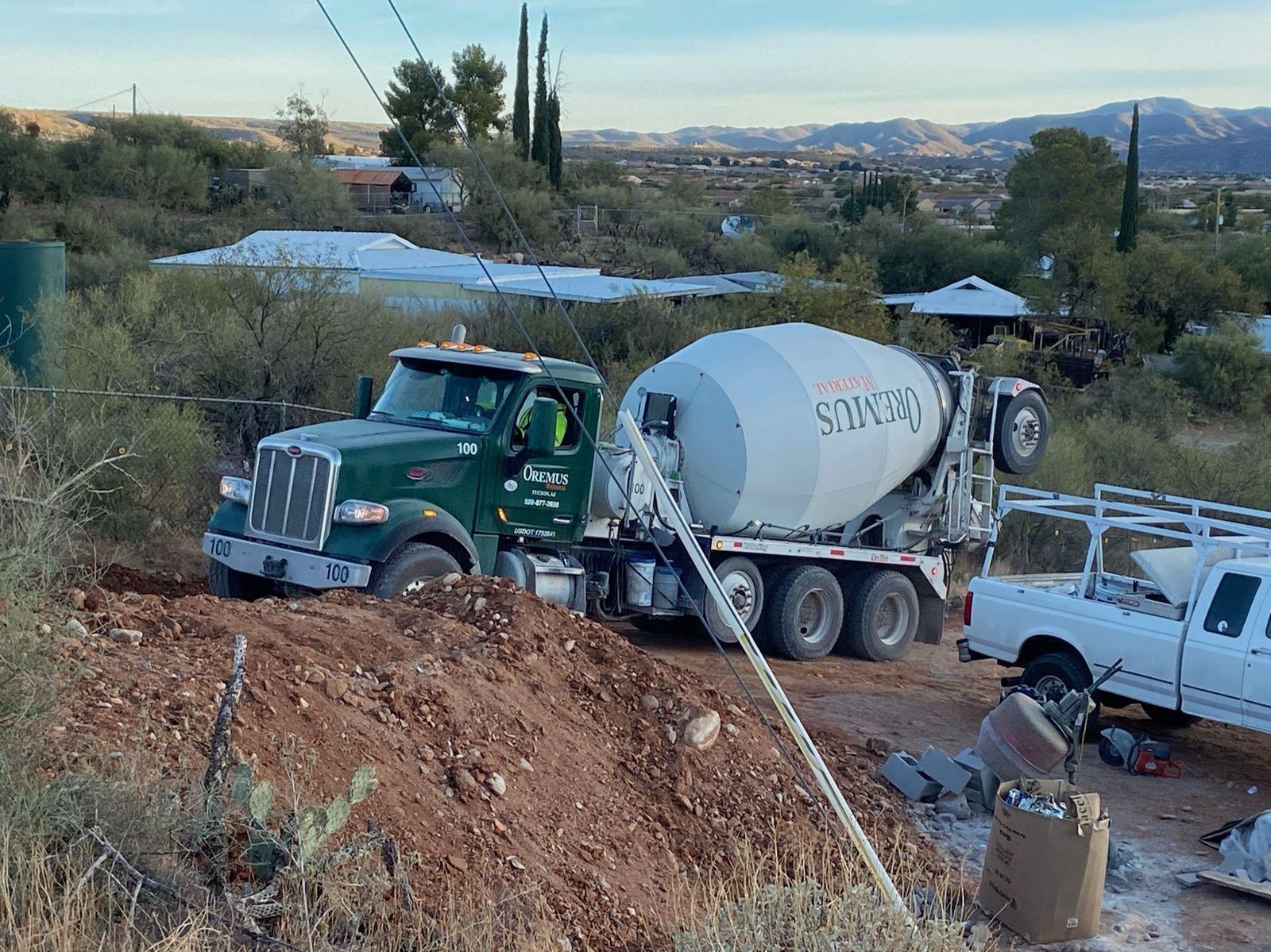

A concrete truck at the site.
Screeding the slab.

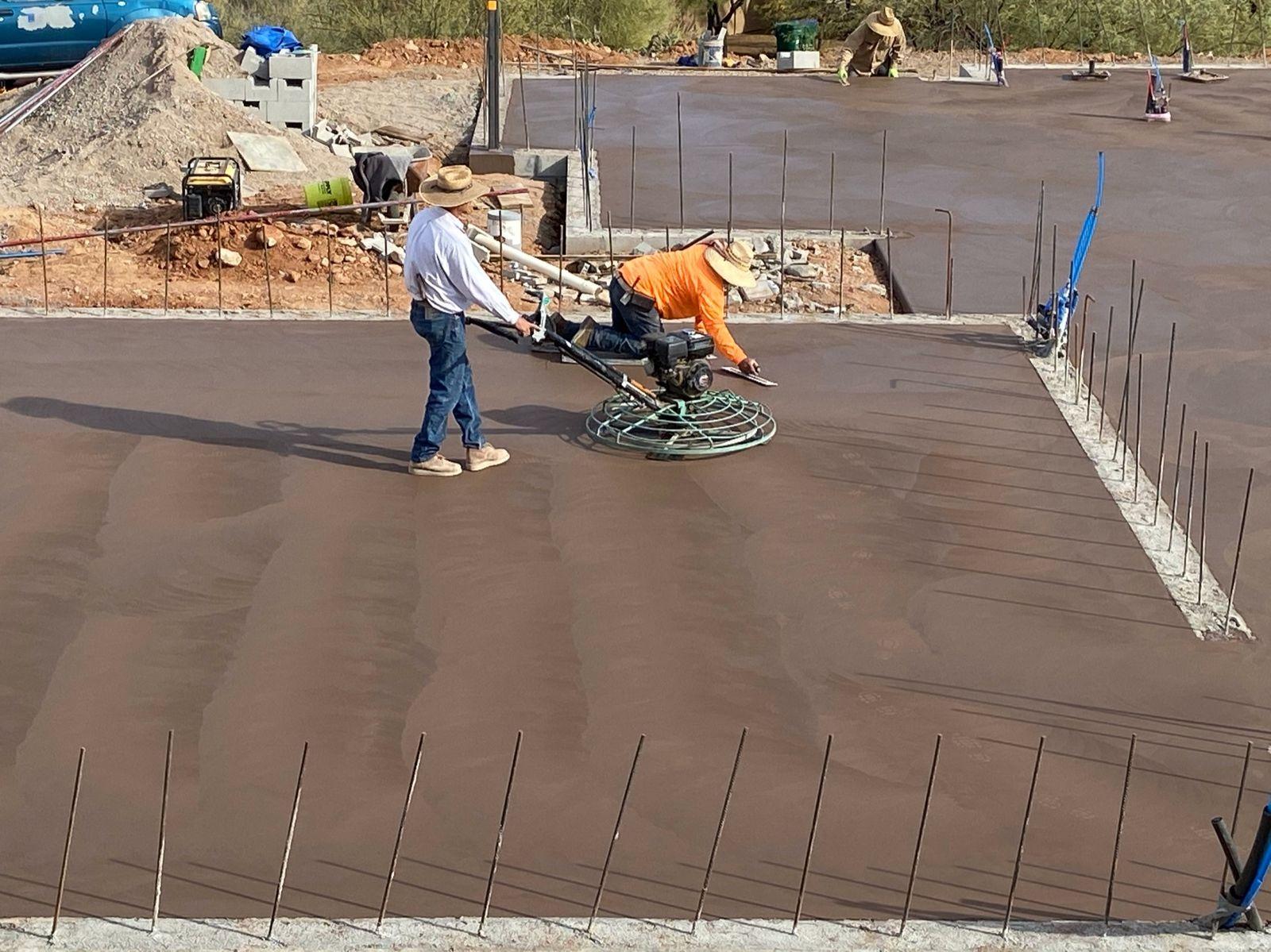

Power troweling the finish.

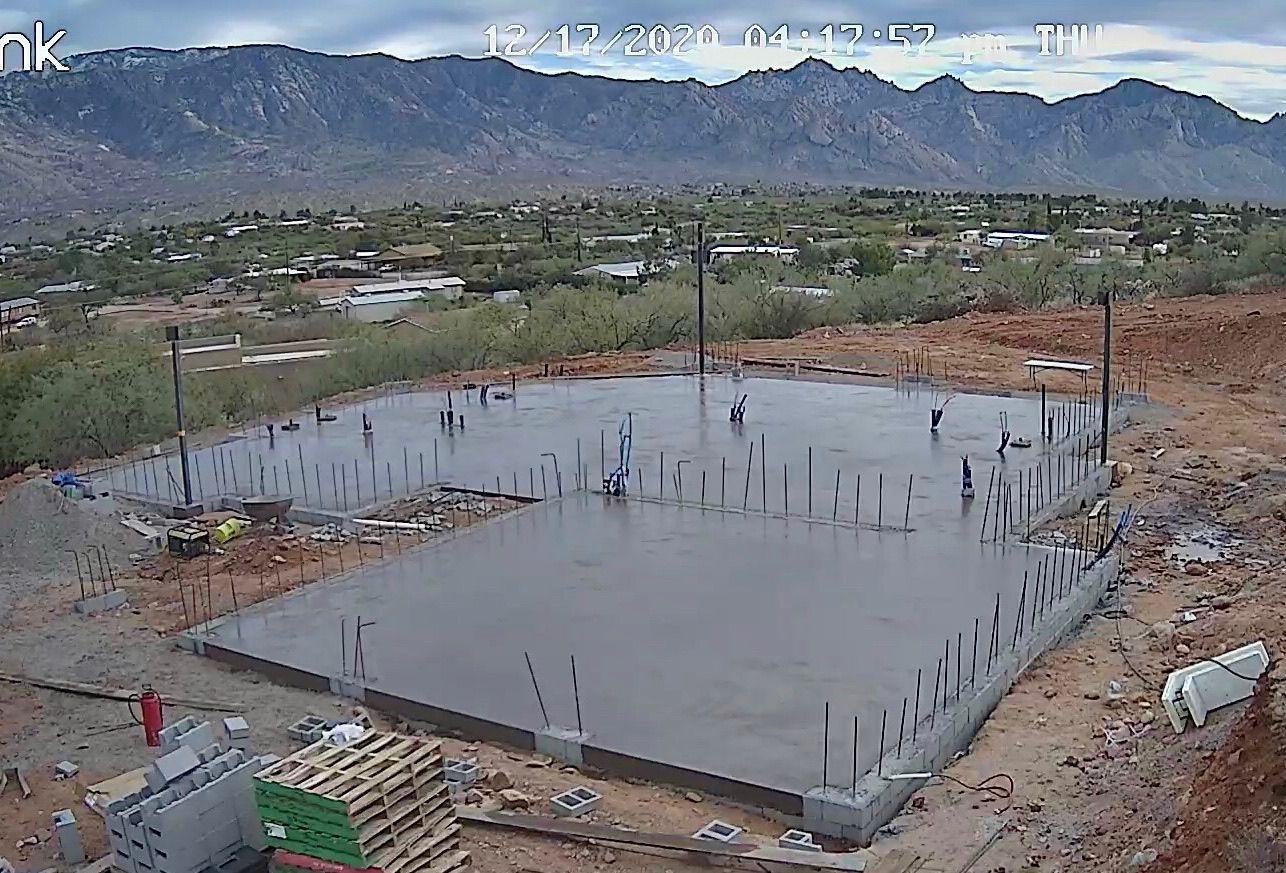

The finished slab, with wall rebar standing.

Phase 03

Insulated Concrete Form Walls

The walls are insulated concrete forms (ICF): foam blocks stacked, braced, reinforced, and filled with concrete, for a quiet, thermally stable mass wall.

The first courses of ICF block.

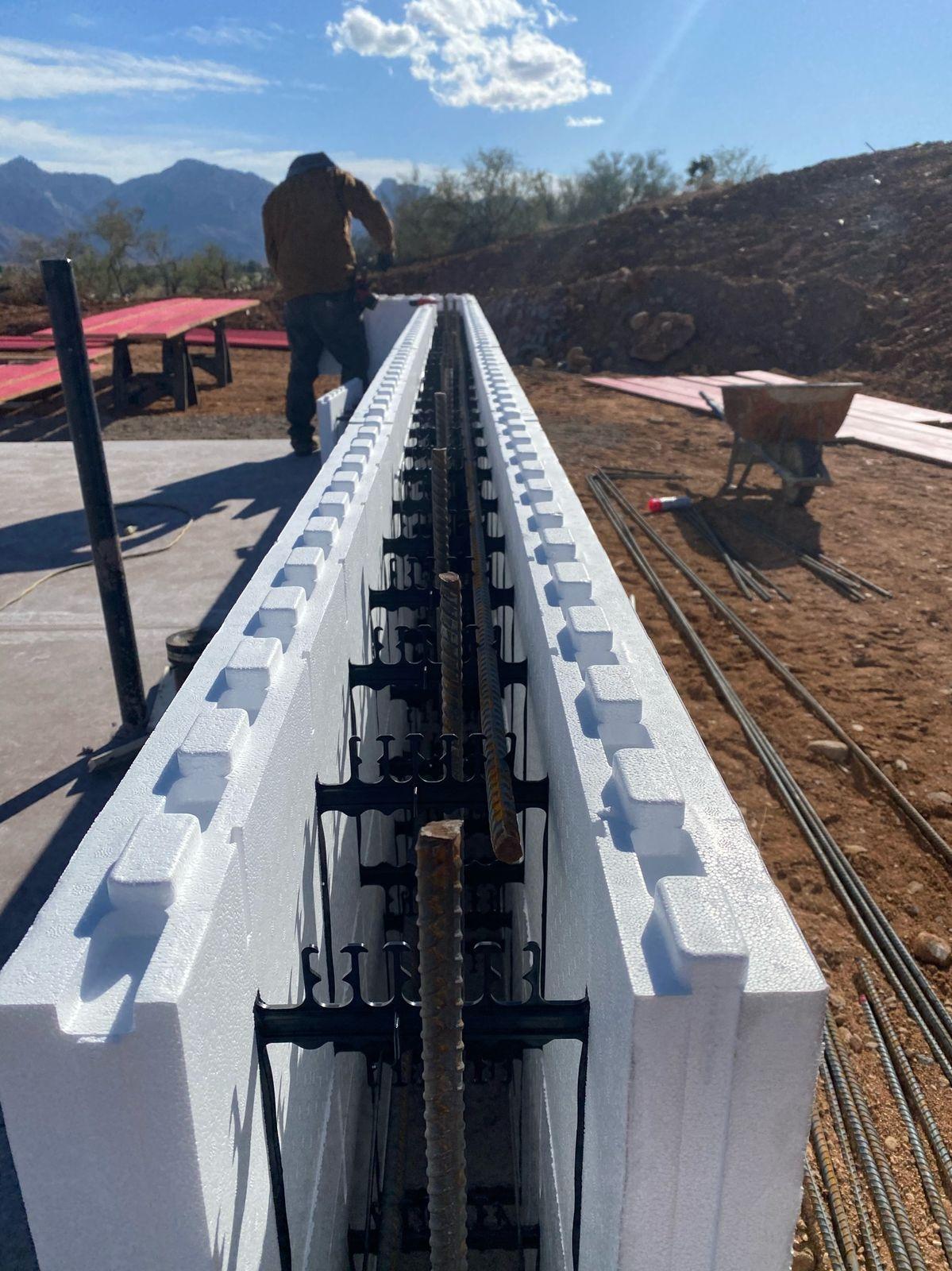

Rebar inside the forms.

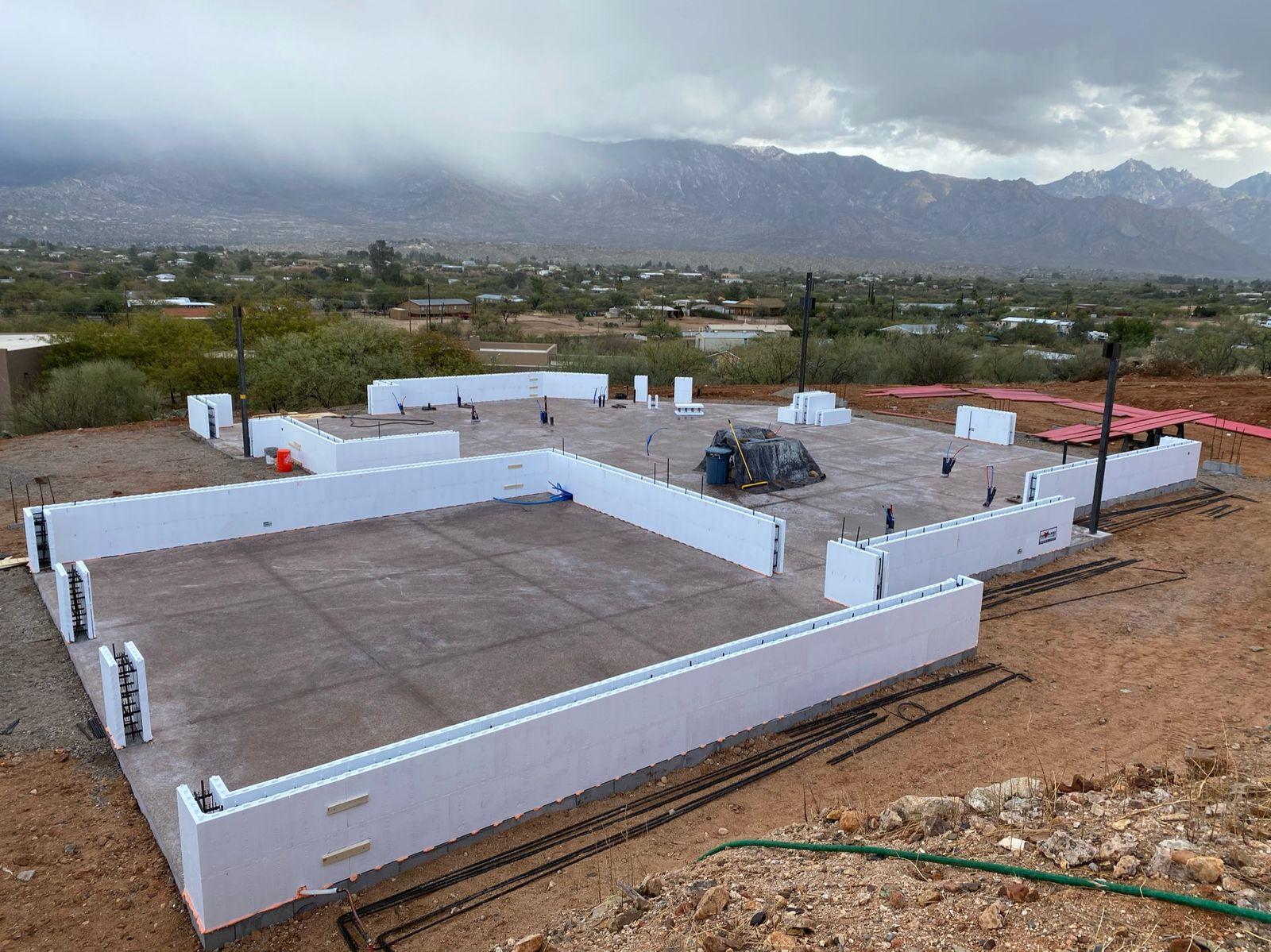

Walls rising around the slab.

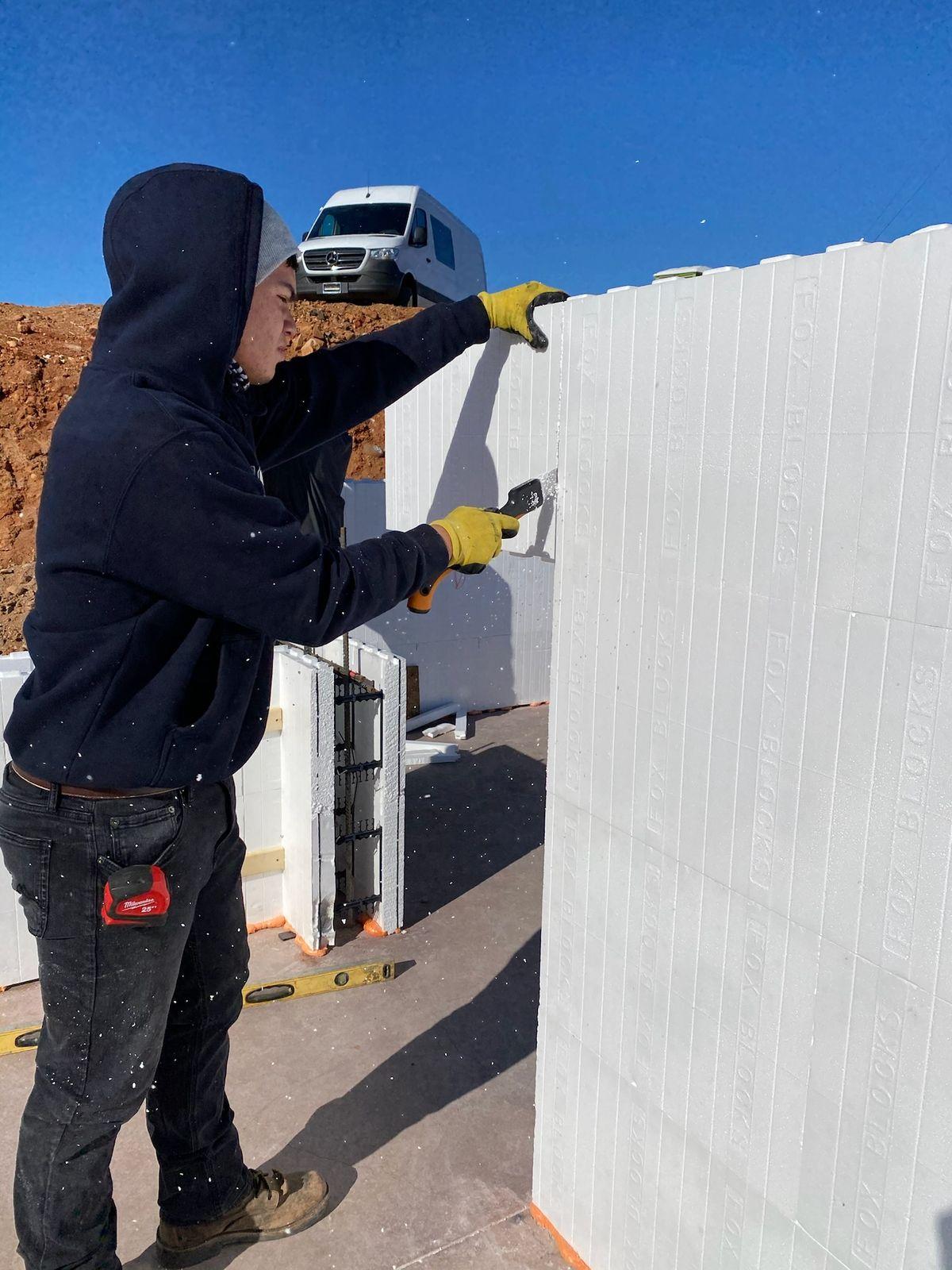

Stacking block.

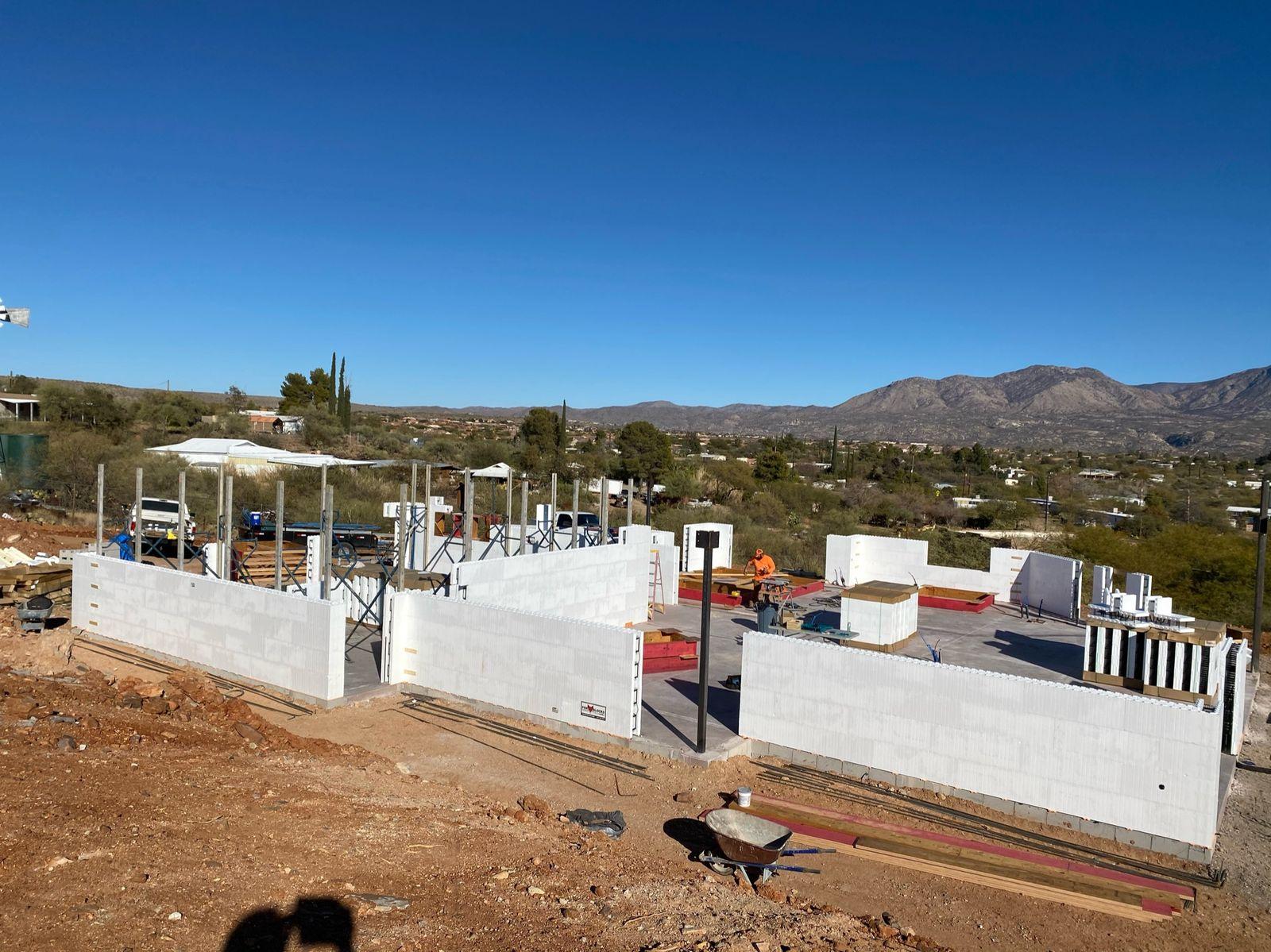

Walls braced for the pour.

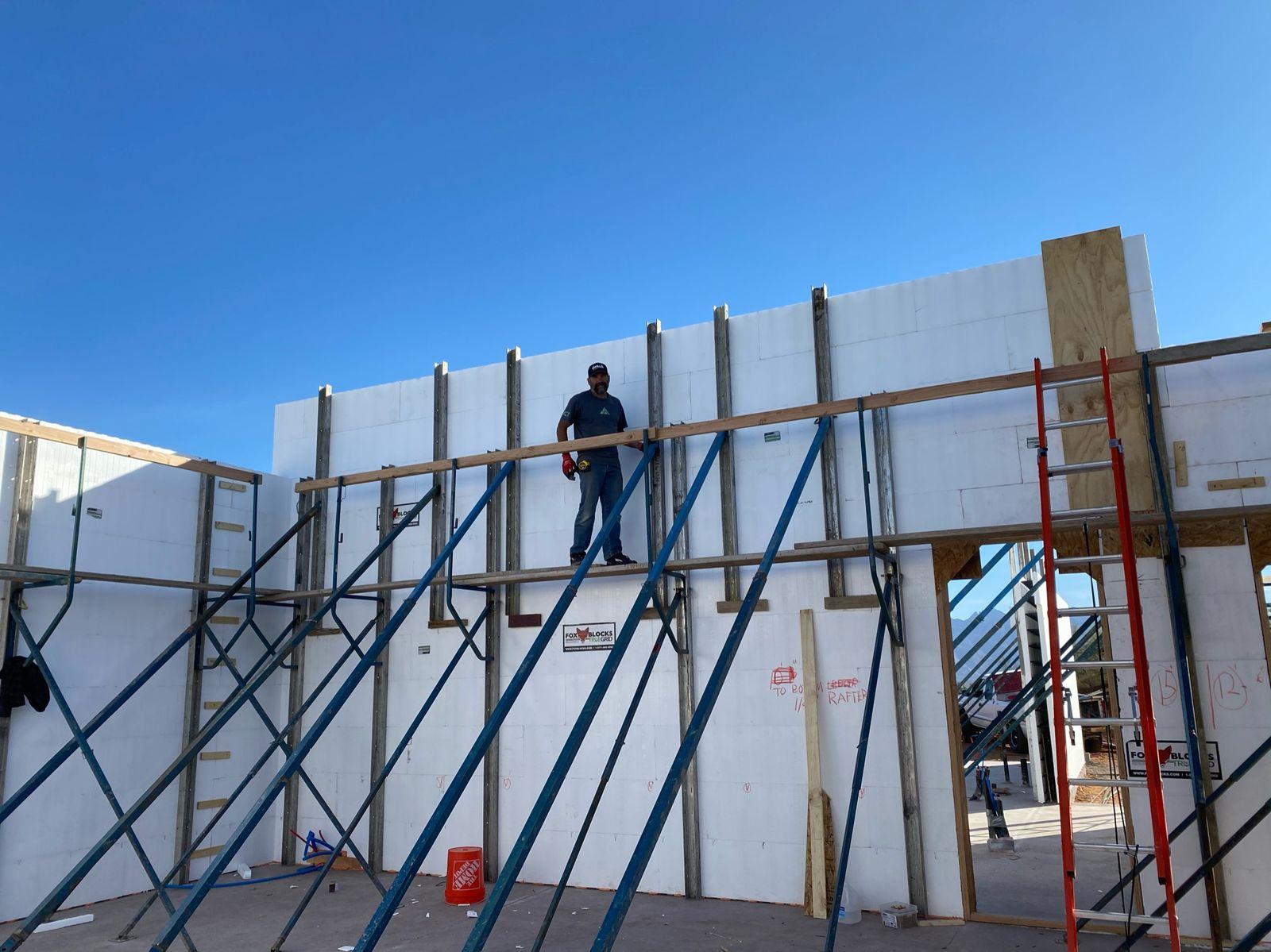

A tall wall, braced and plumbed.

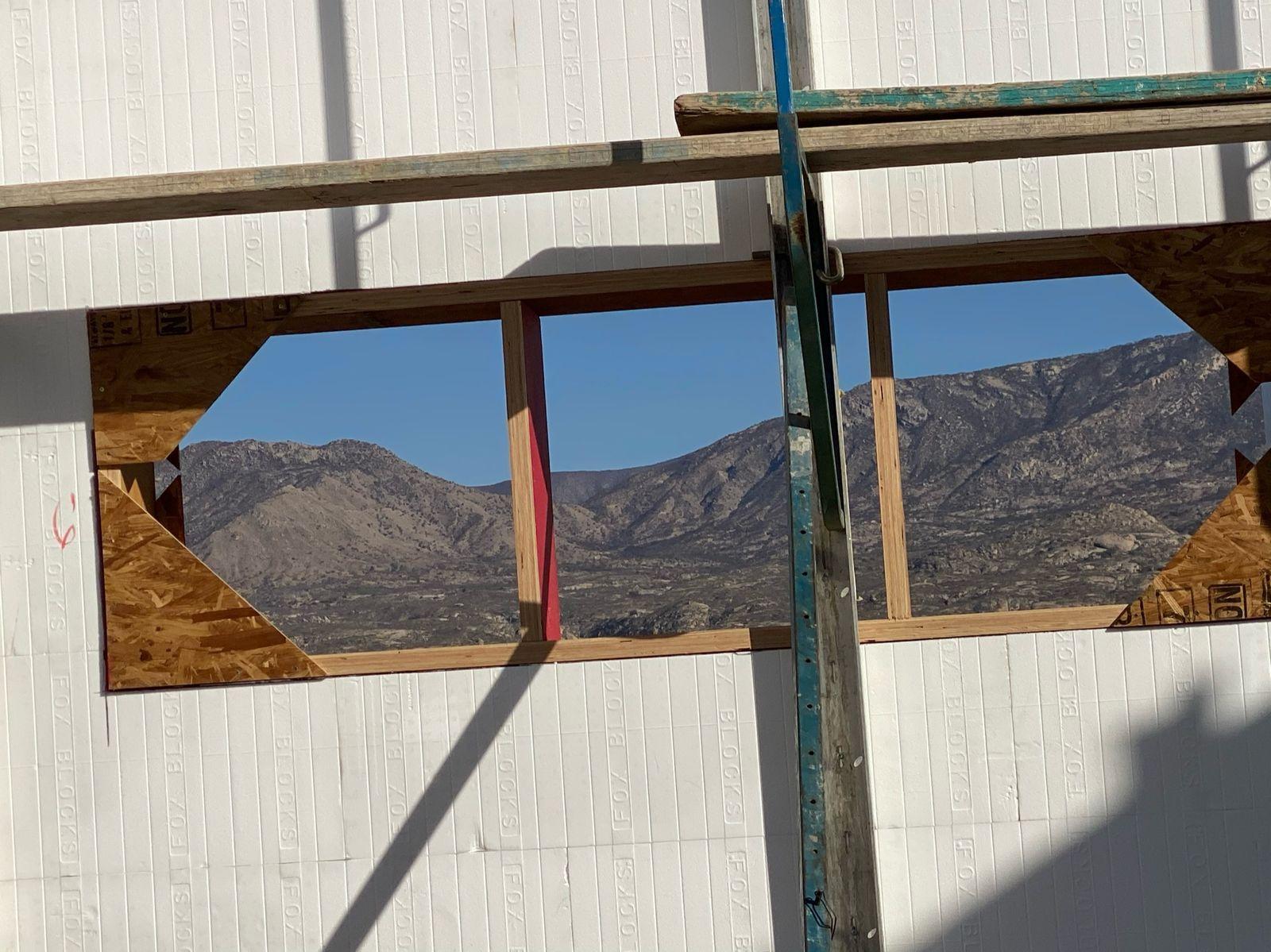

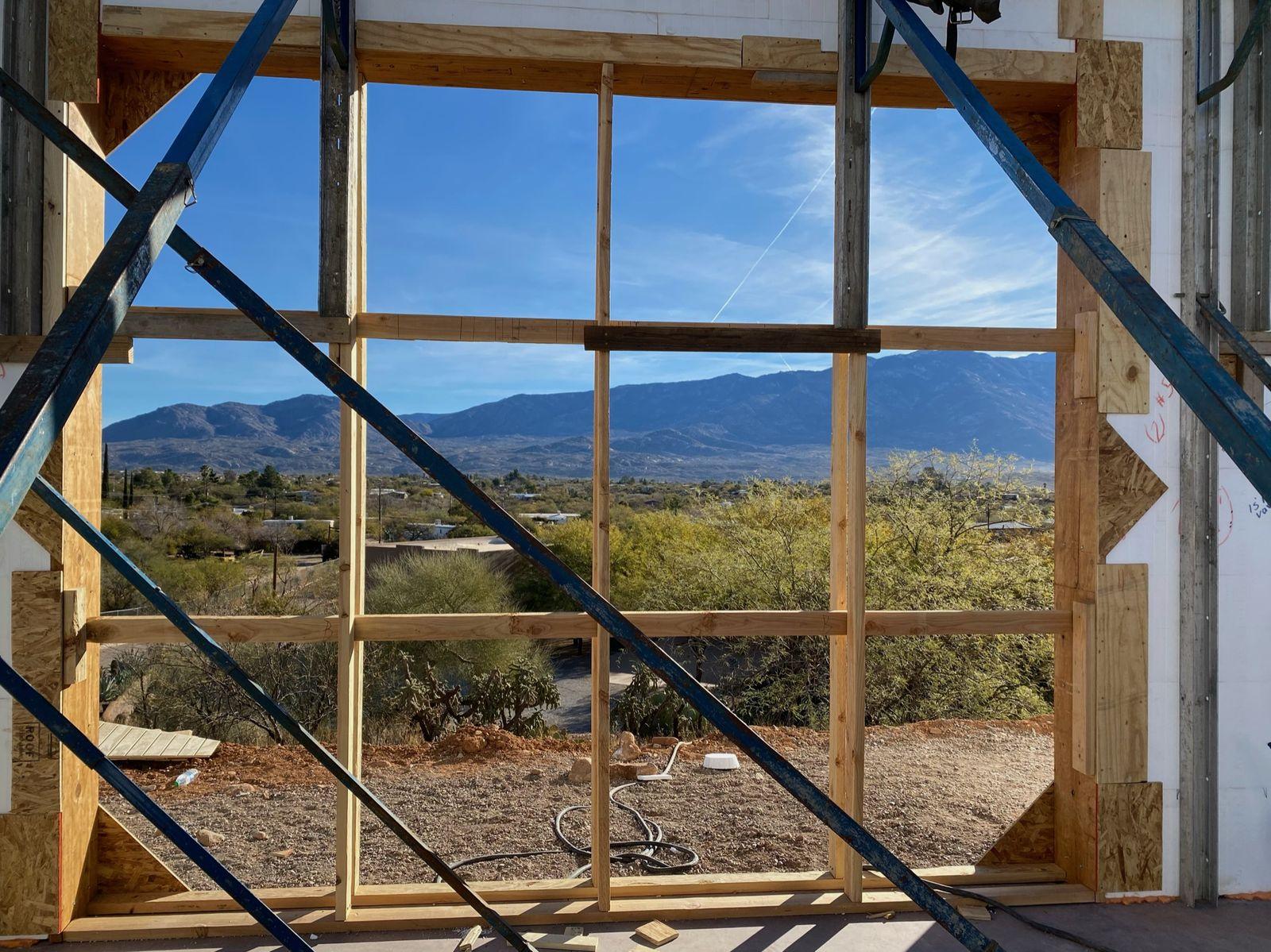

A window opening framing the mountains.

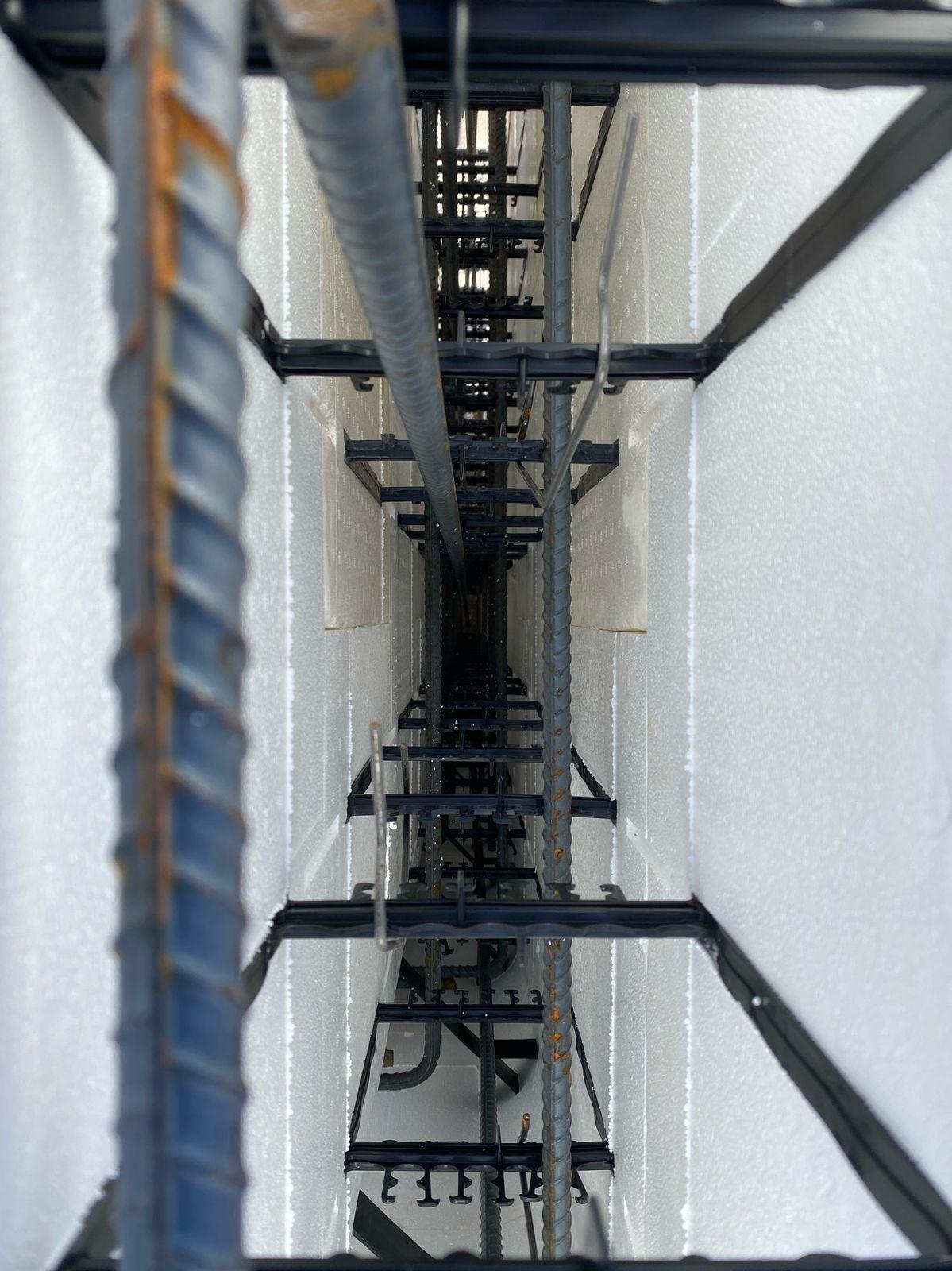

Down the core of a wall before the pour.
Window bucks set in the walls.

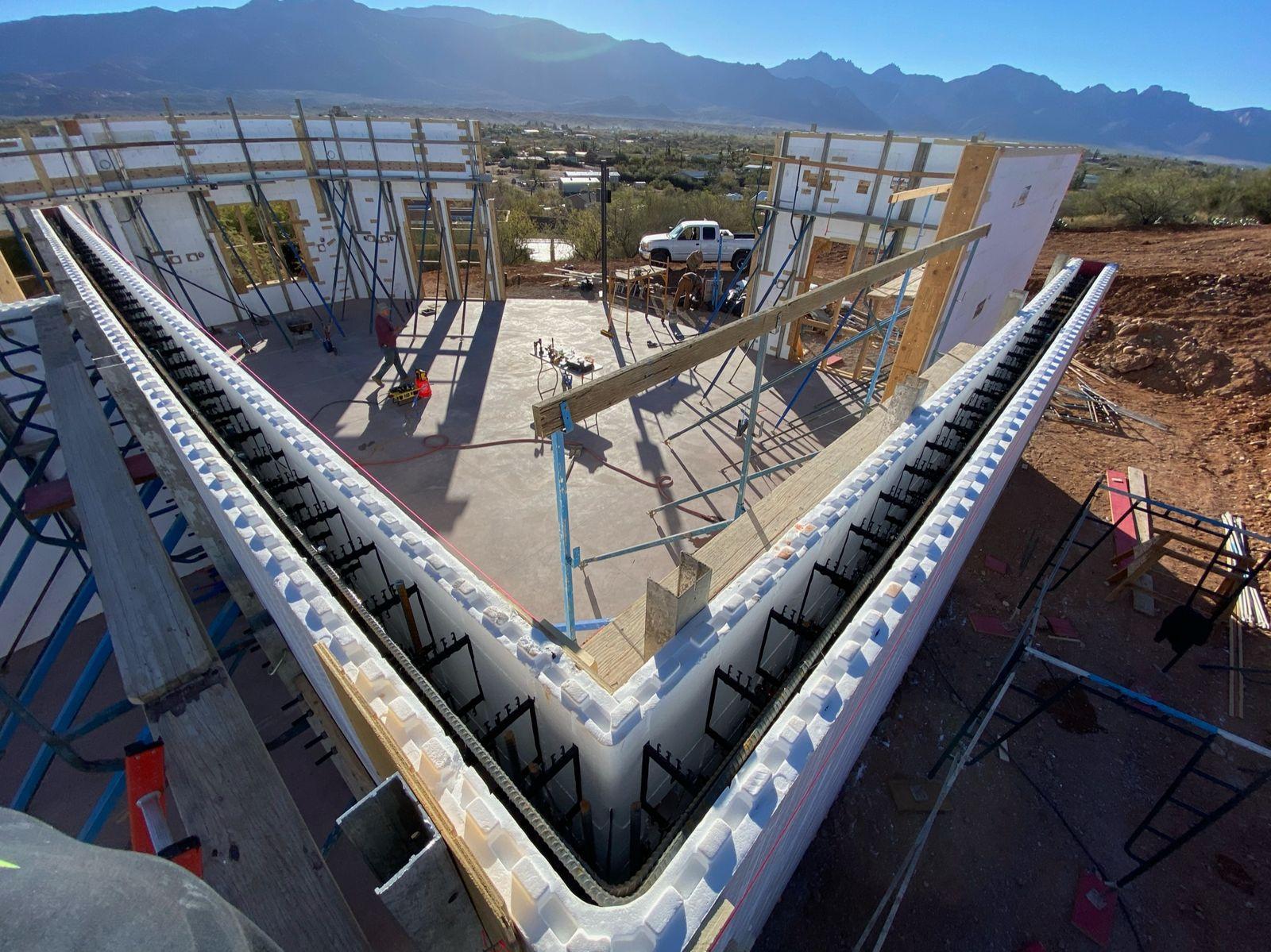

A corner ready for concrete.

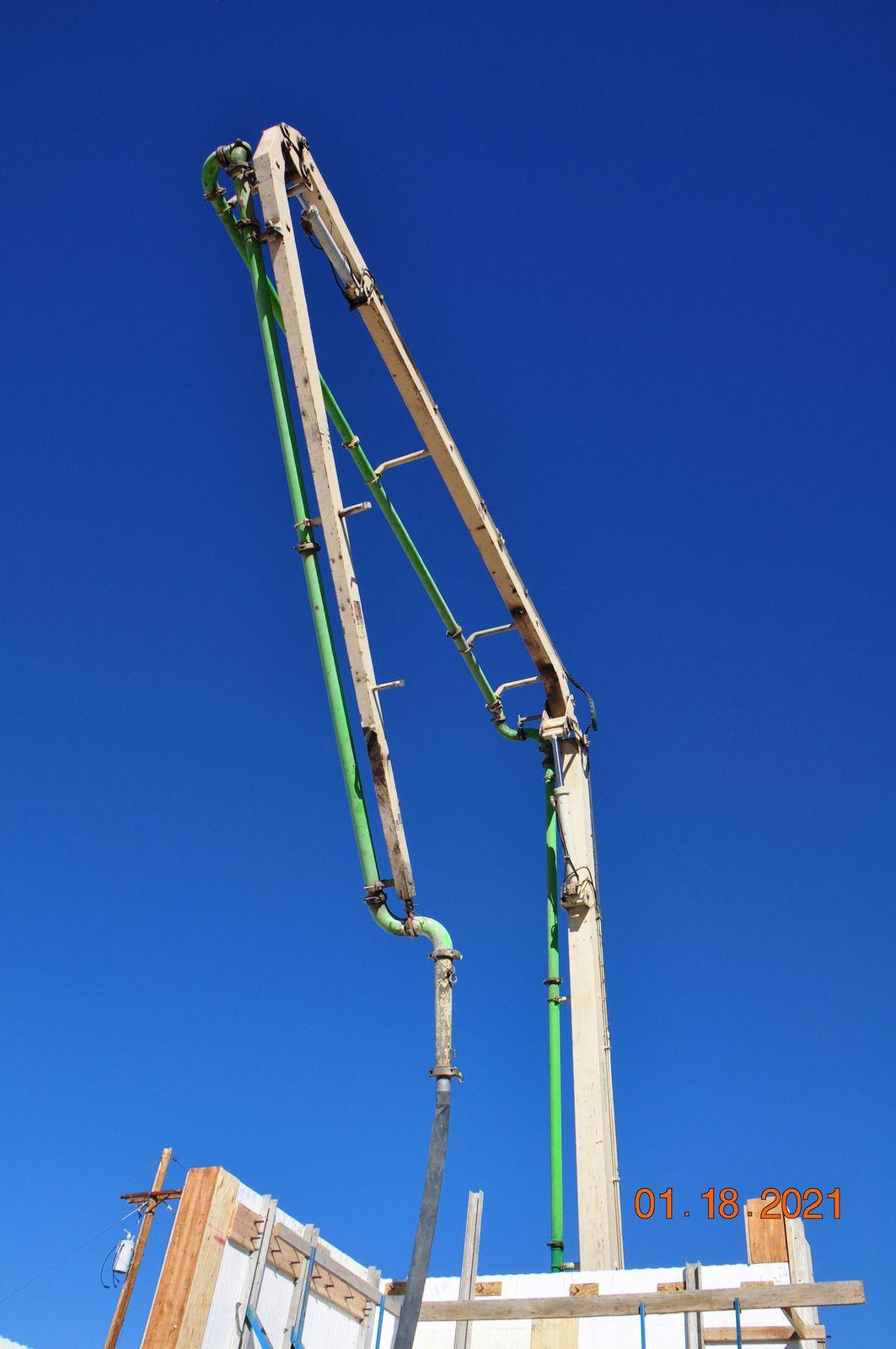

The pump boom placing concrete.

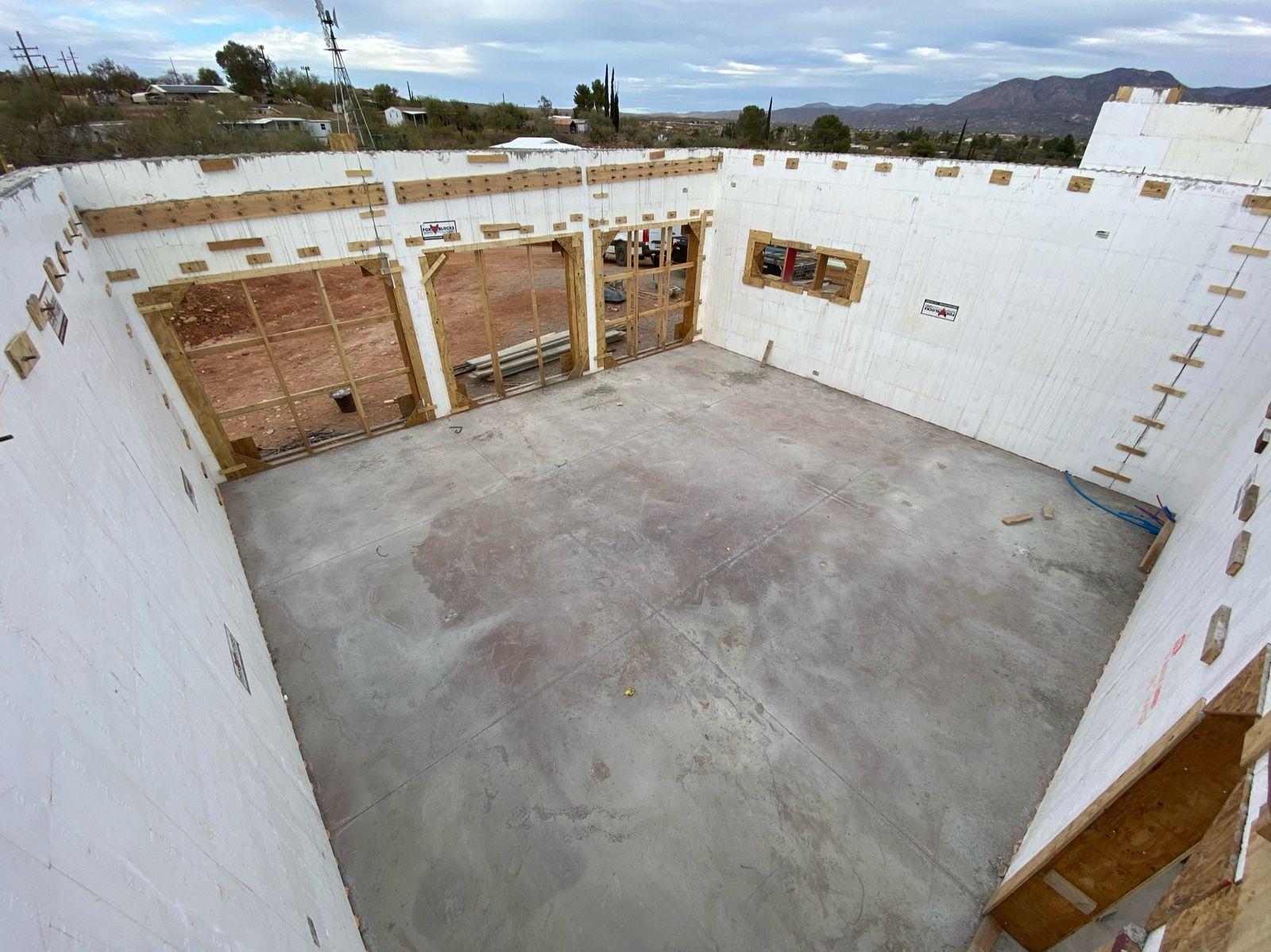

Inside the finished walls.

Phase 04

Framing and Roof

Interior framing, the roof structure, and the roof membrane go on over the mass walls.

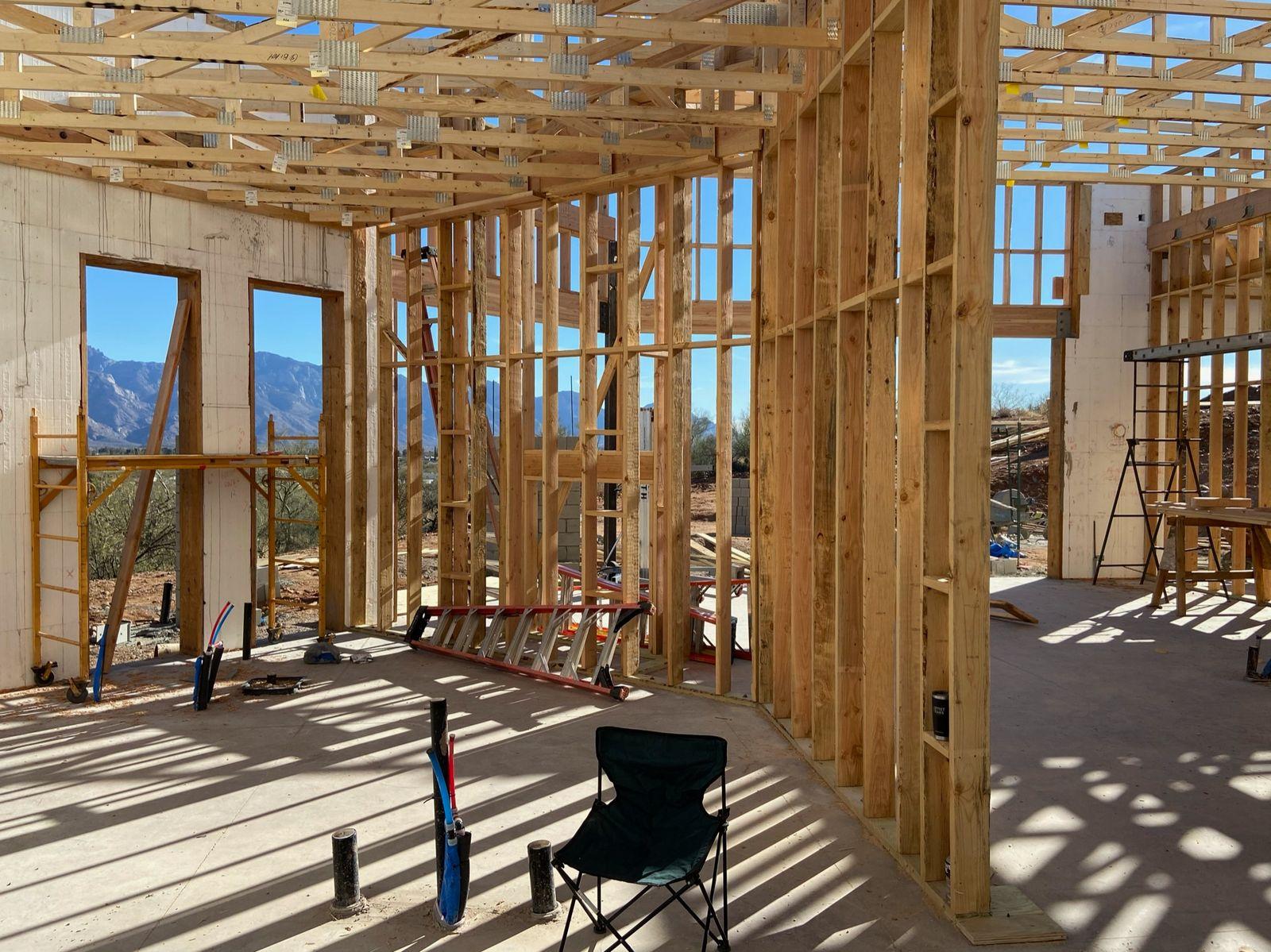

Interior framing inside the concrete shell.

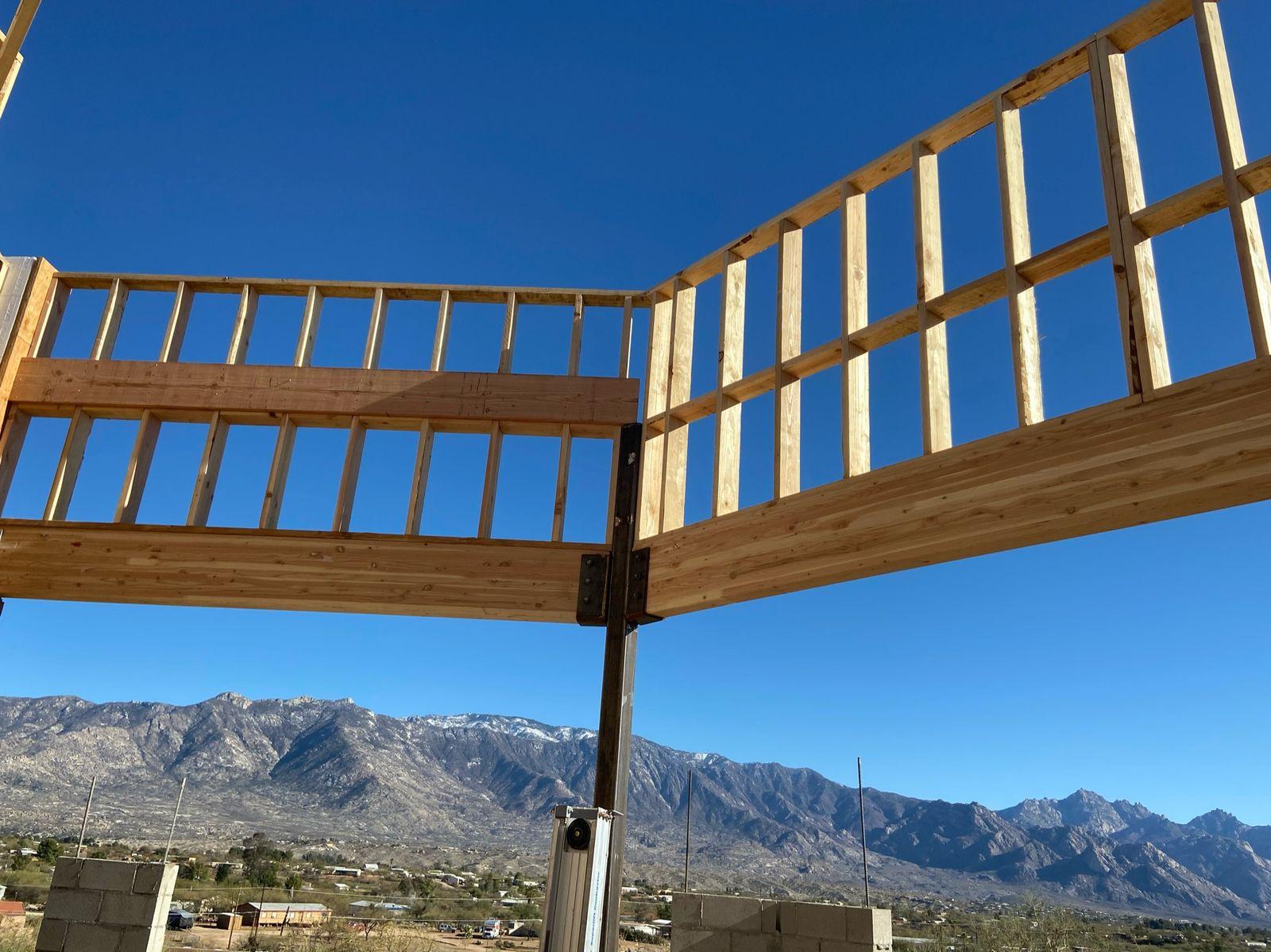

Roof framing, open to the mountains.

An entry column going up.

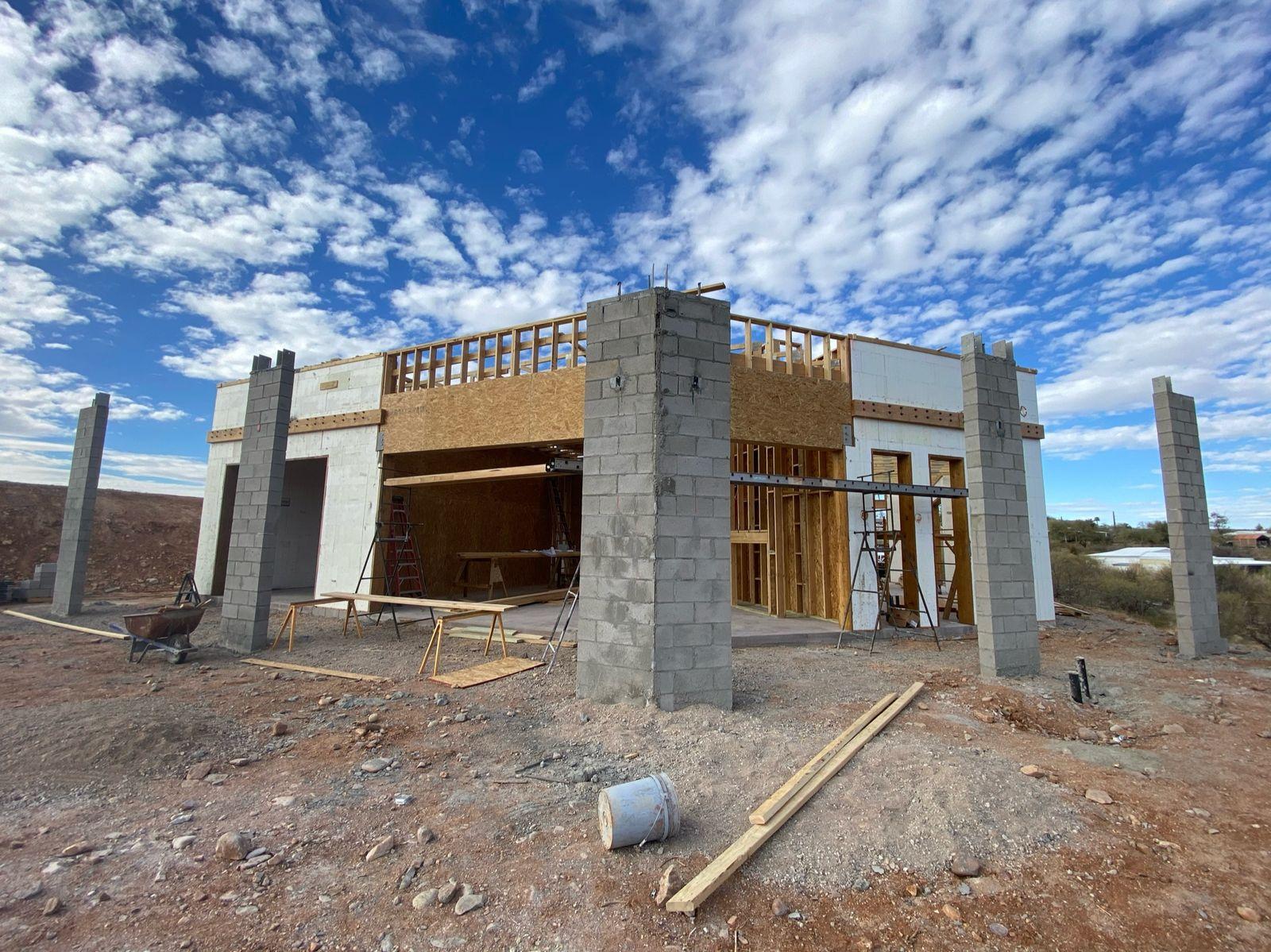

The entry columns and roofline taking shape.

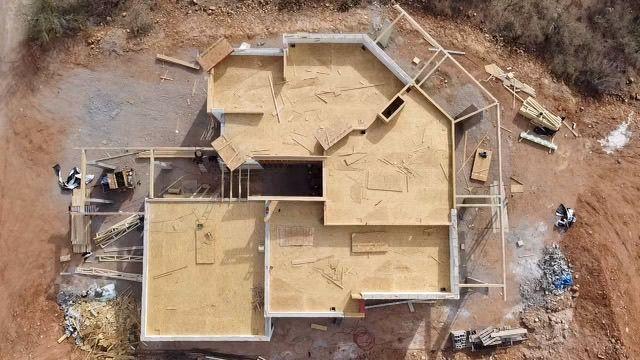

The sheathed roof from above.

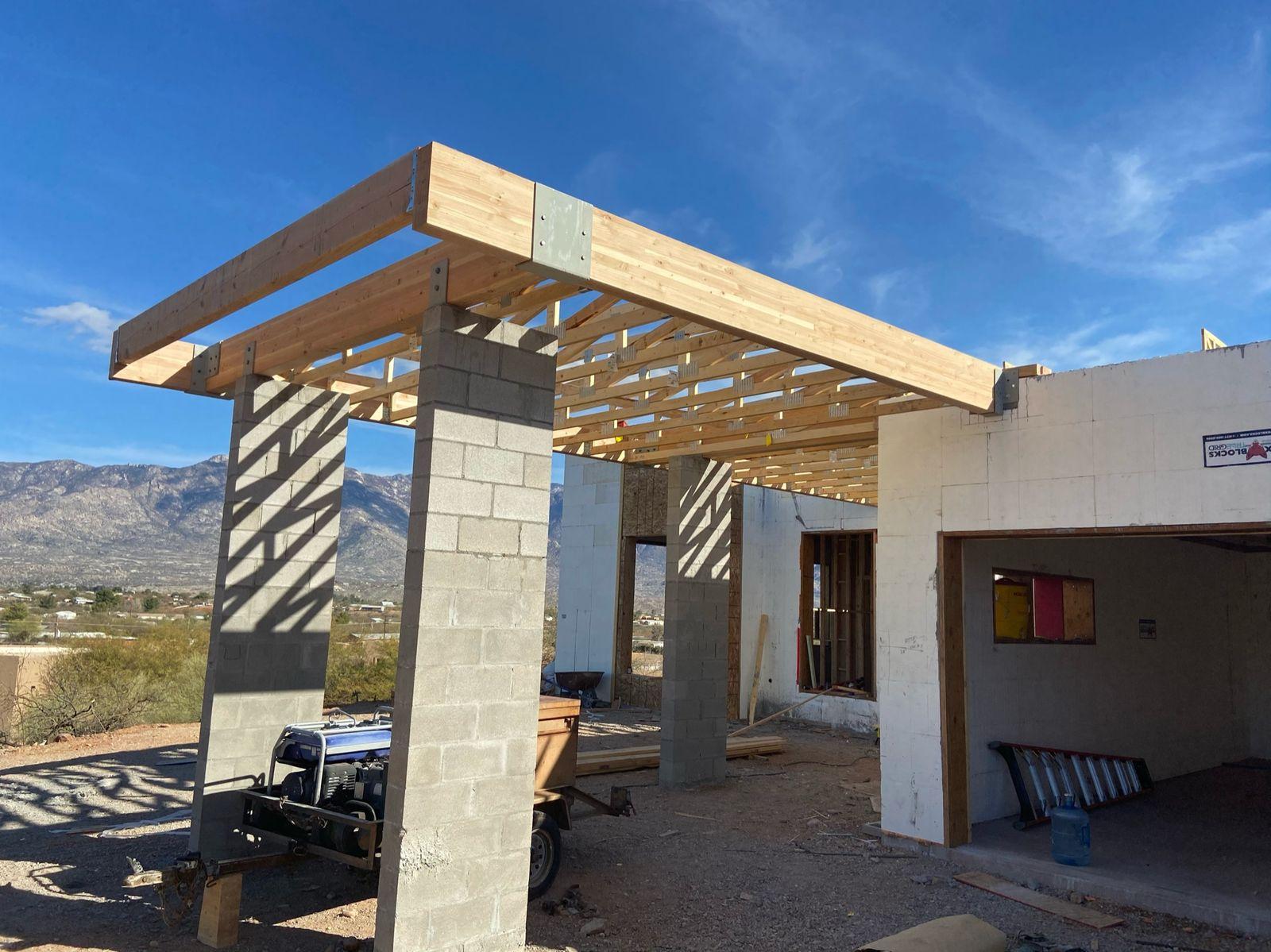

Framing the entry canopy.

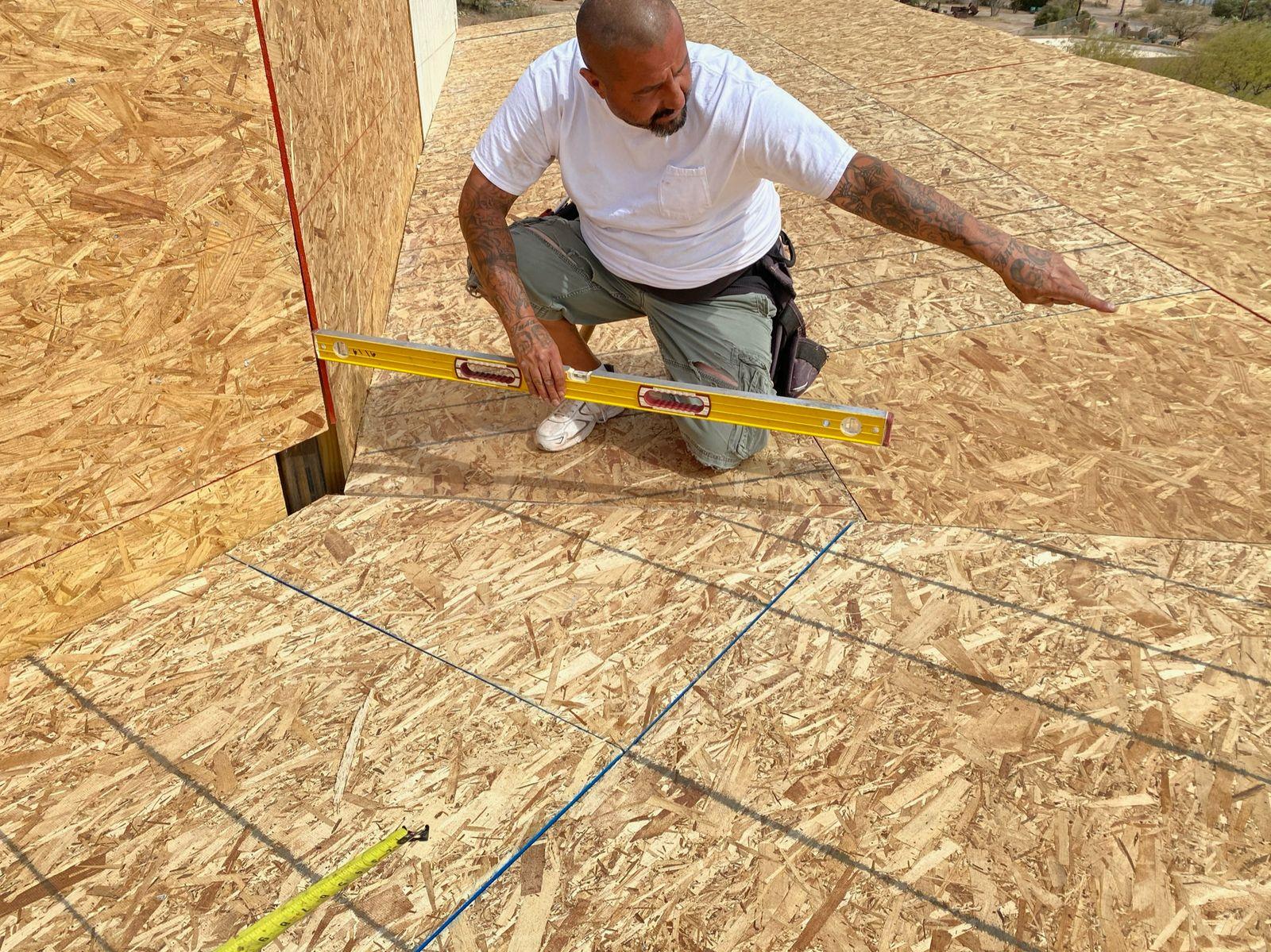

Roof sheathing going down.

The great room shell.

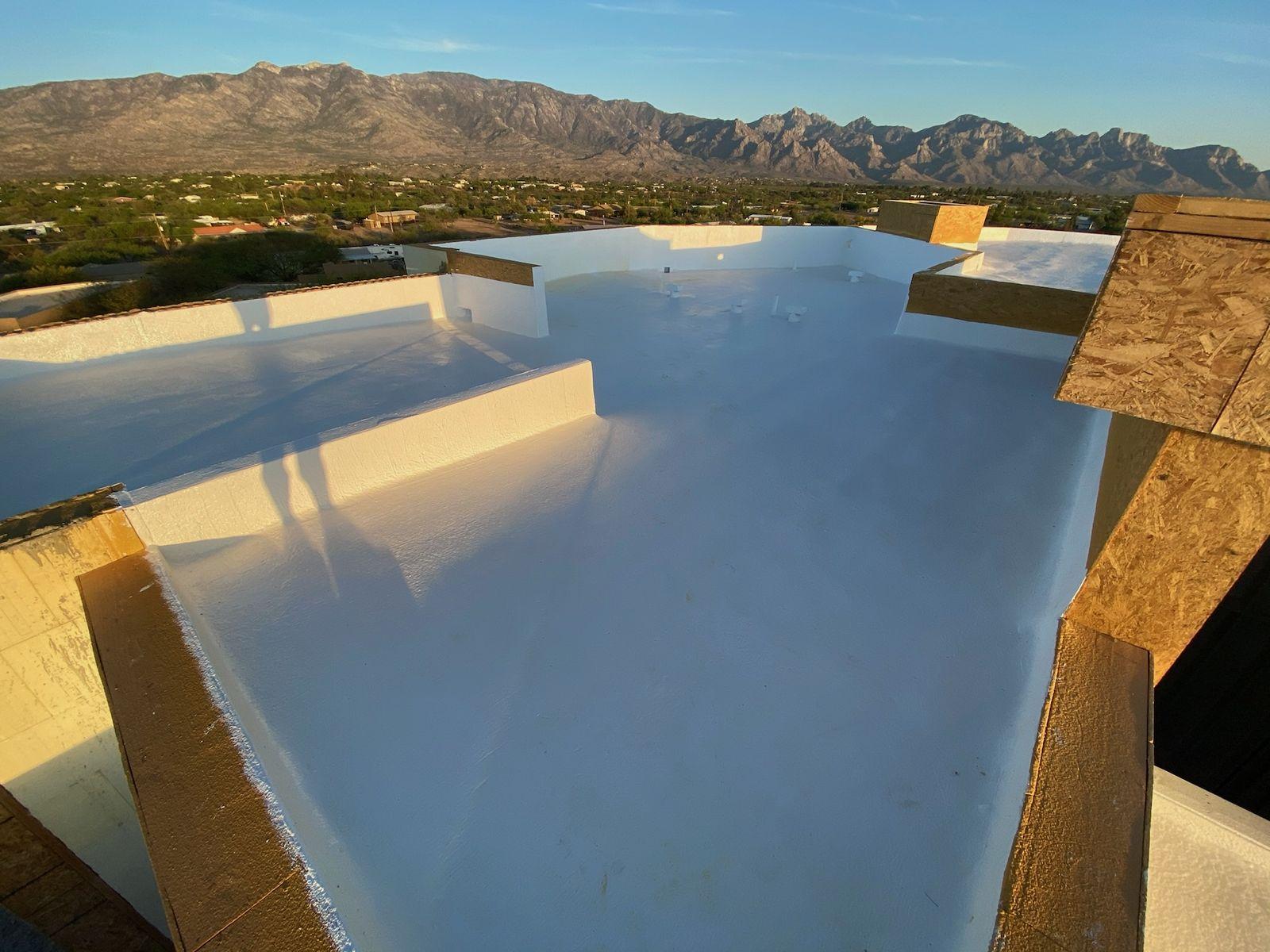

The roof membrane at sunrise.

Phase 05

Rough-In and Insulation

Wiring, plumbing, and ductwork are routed, then the roof deck and walls are insulated.

Refrigerant lines and ductwork roughed in.

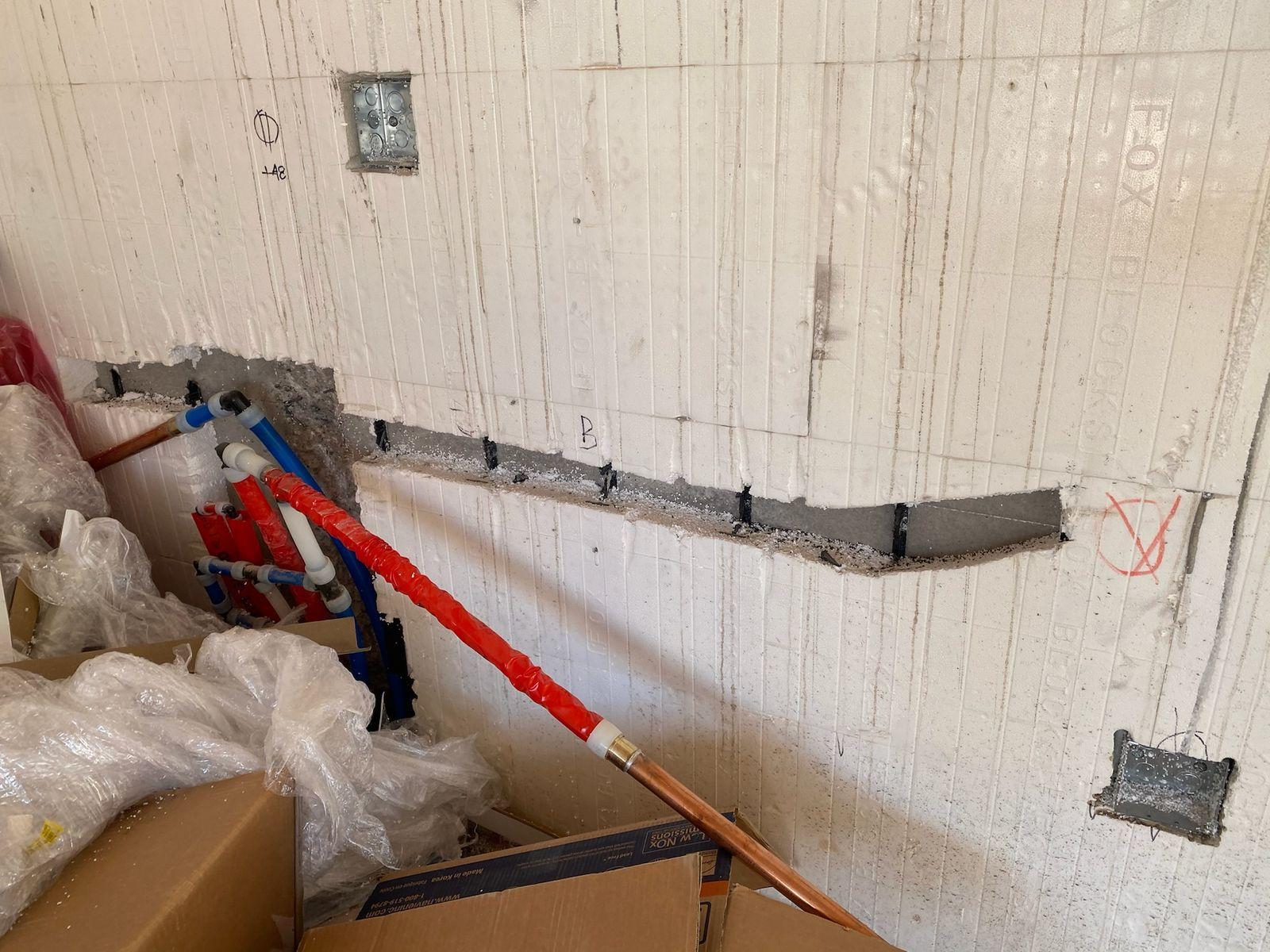

Plumbing and wiring chased into the foam.

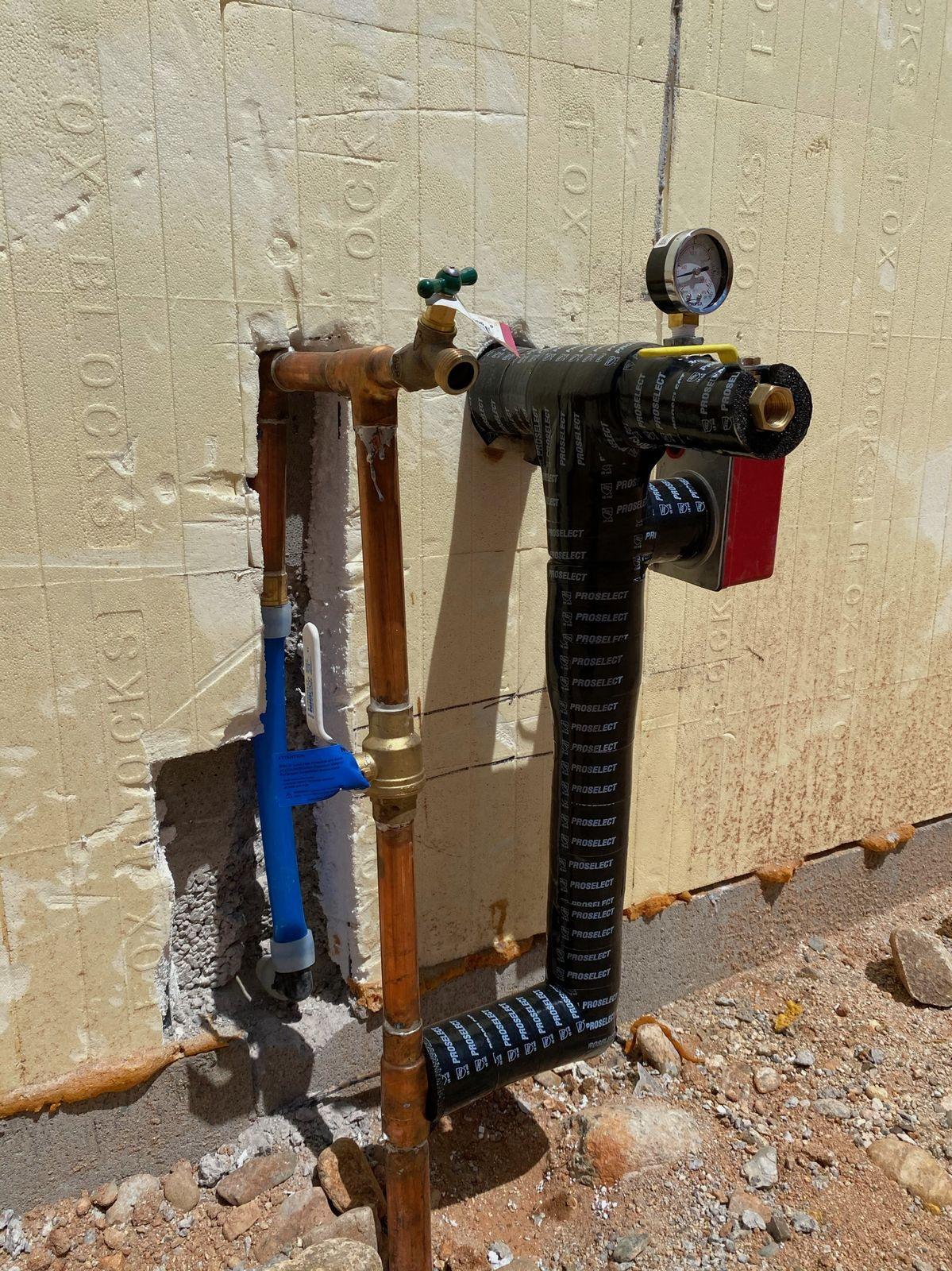

The water supply rough-in.
A view window before trim.

Insulation going in.

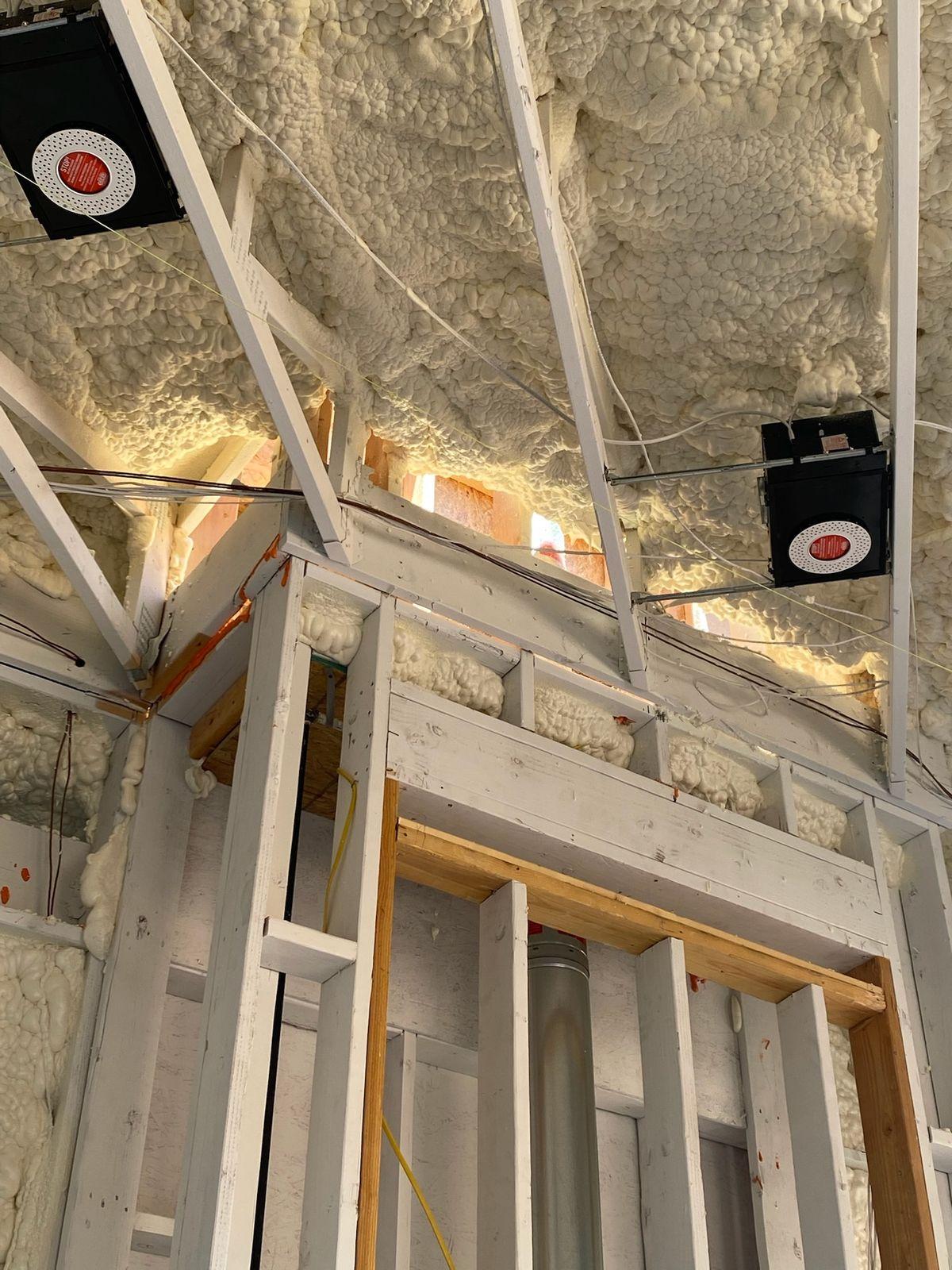

The insulated ceiling.

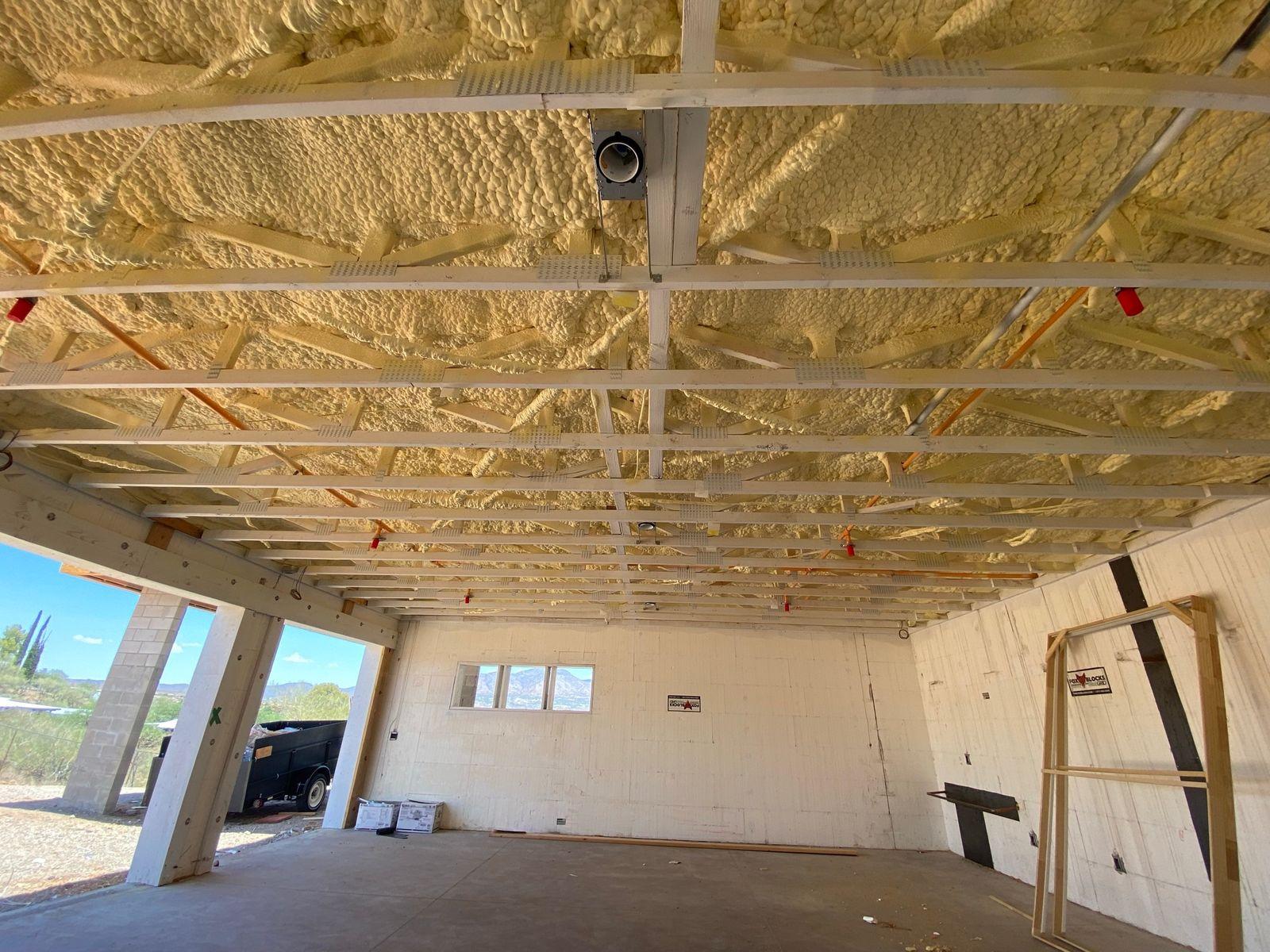

Spray foam sealing the roof deck.

The wood soffit under the overhang.

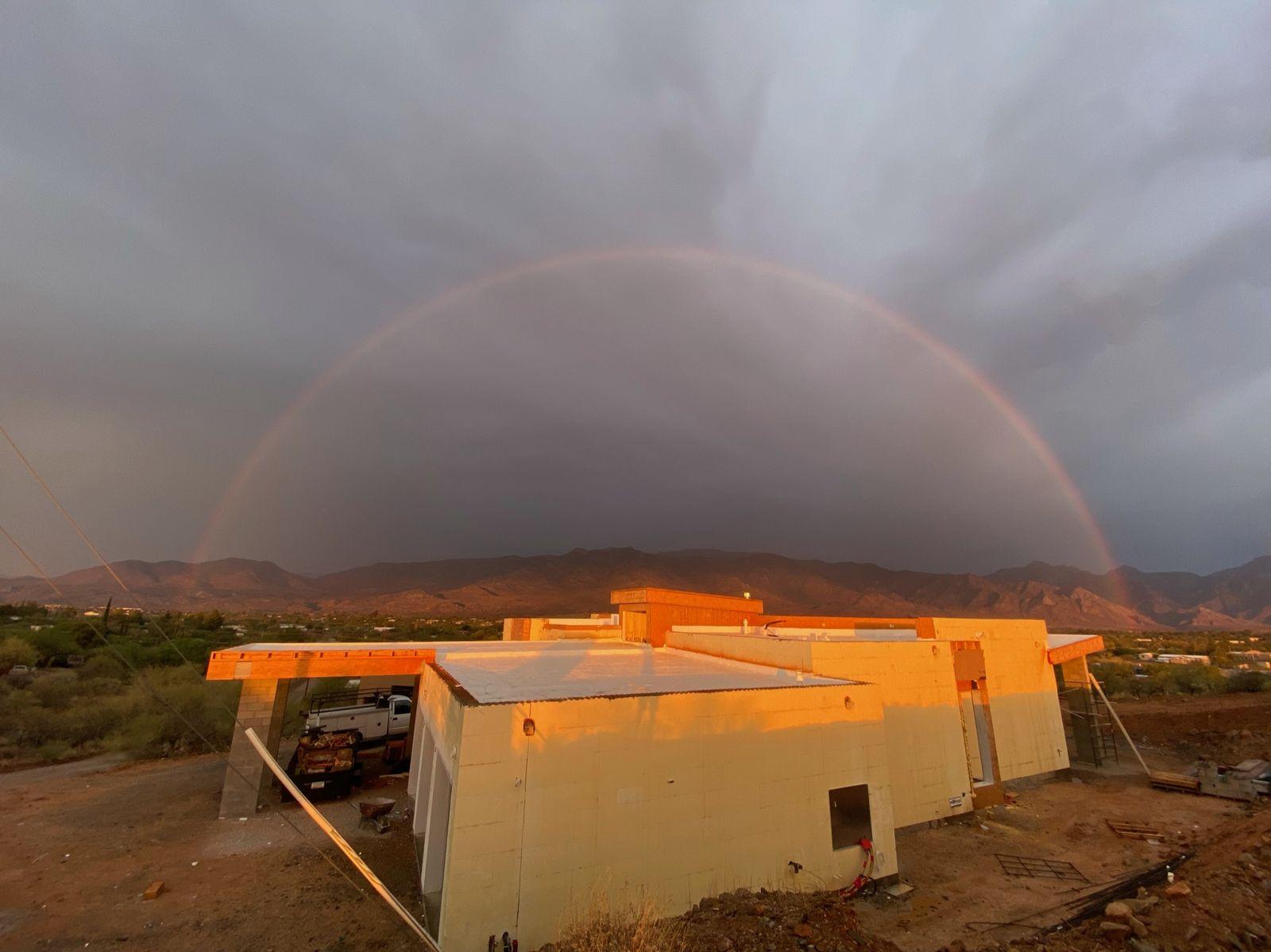

A rainbow over the build.

Phase 06

Drywall and Shielding

After drywall, the walls and ceilings get a carbon-based shielding coat, grounded at the boxes, before the finish paint.

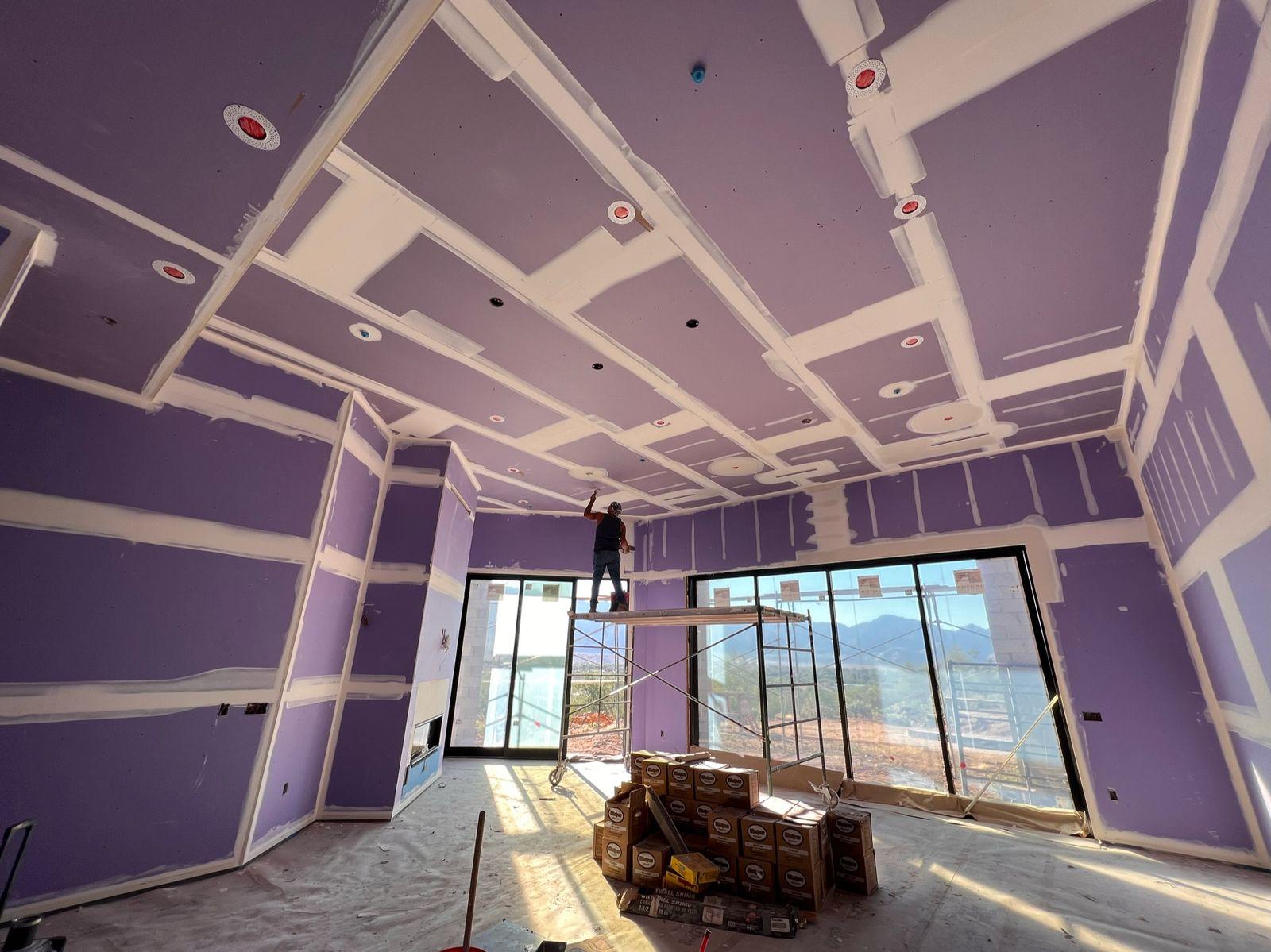

Drywall hung in the great room.

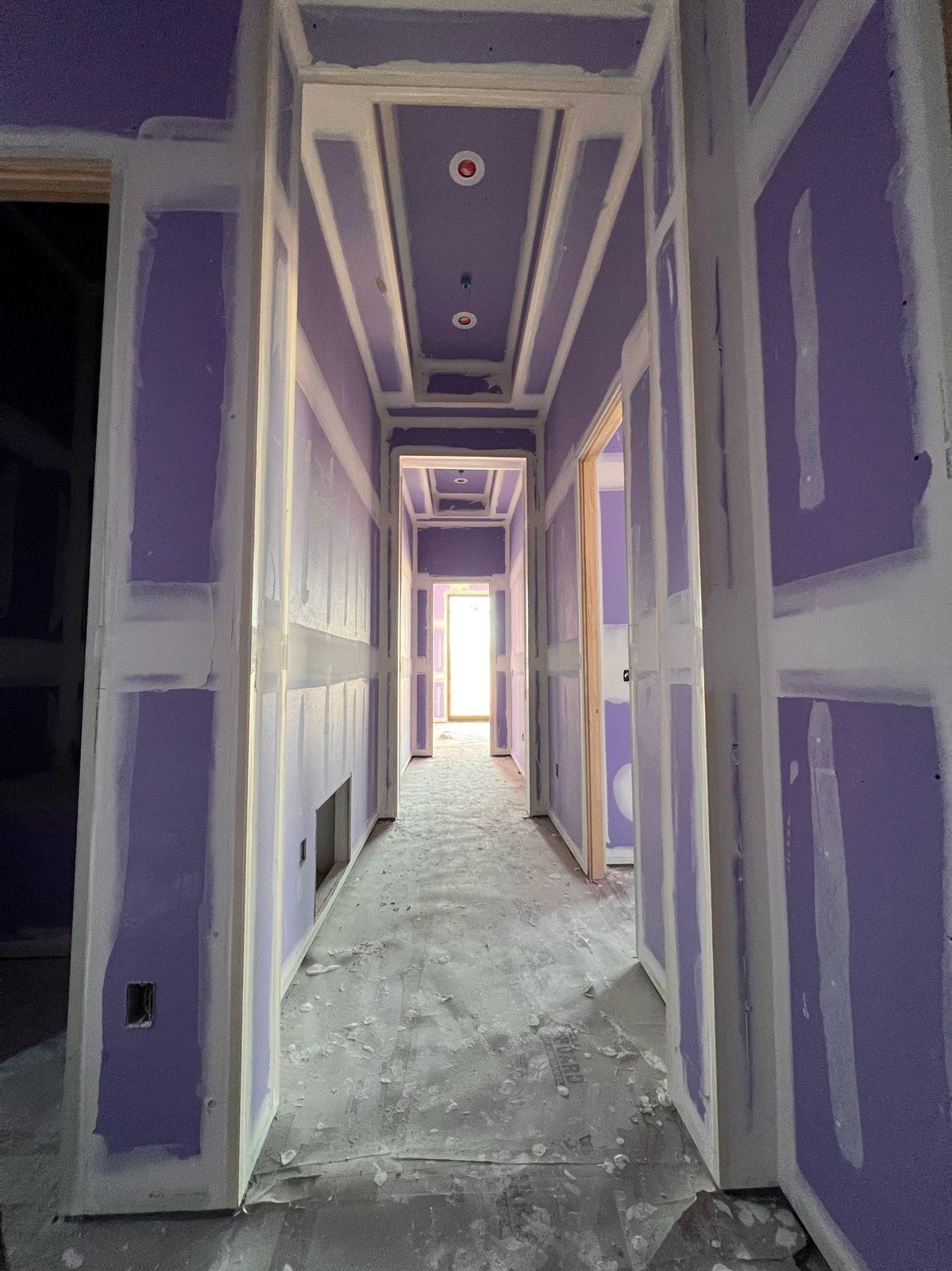

The hallway in drywall.

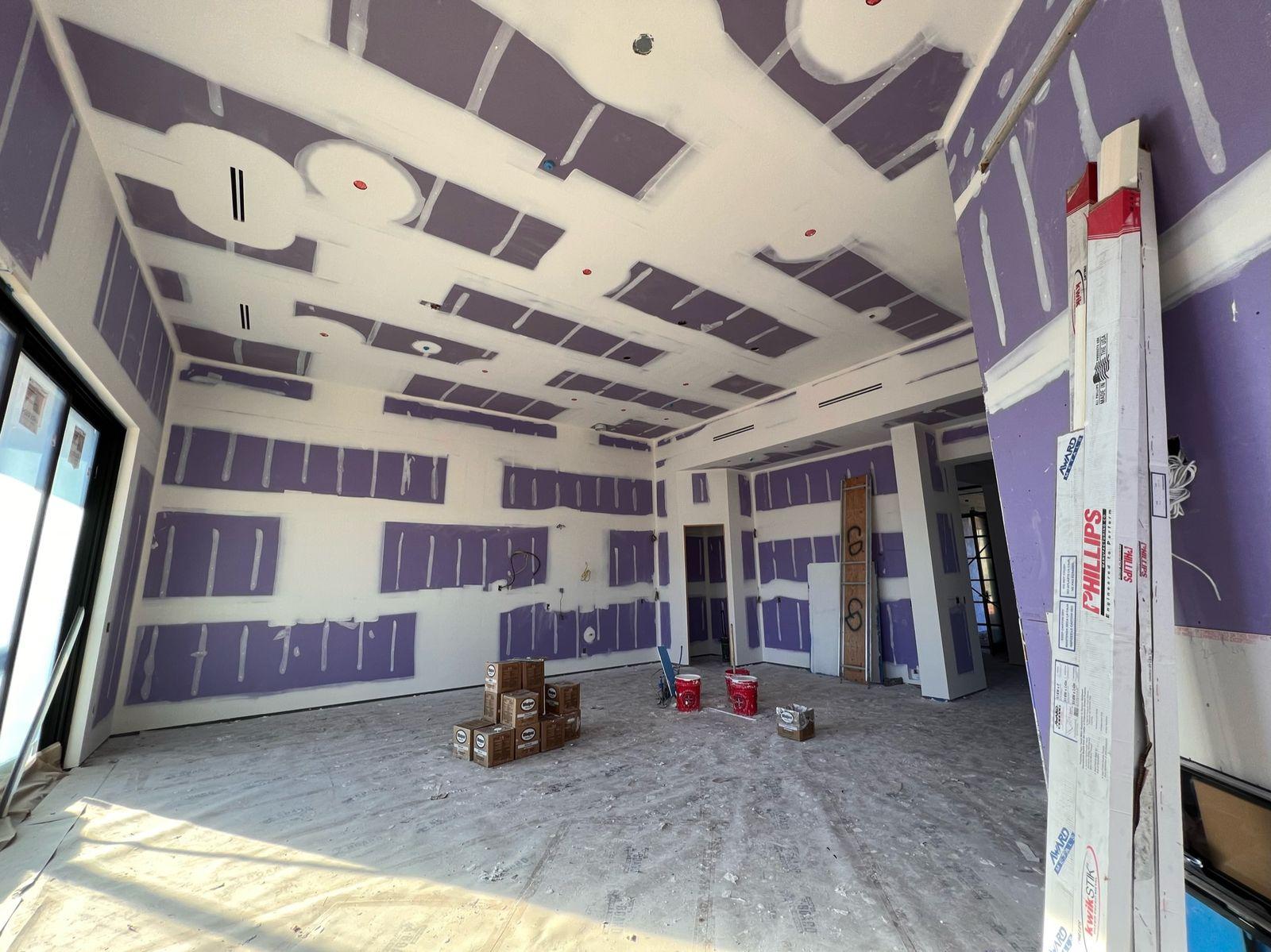

Taped and finished drywall.
YSHIELD GK5 shielding paint on site.

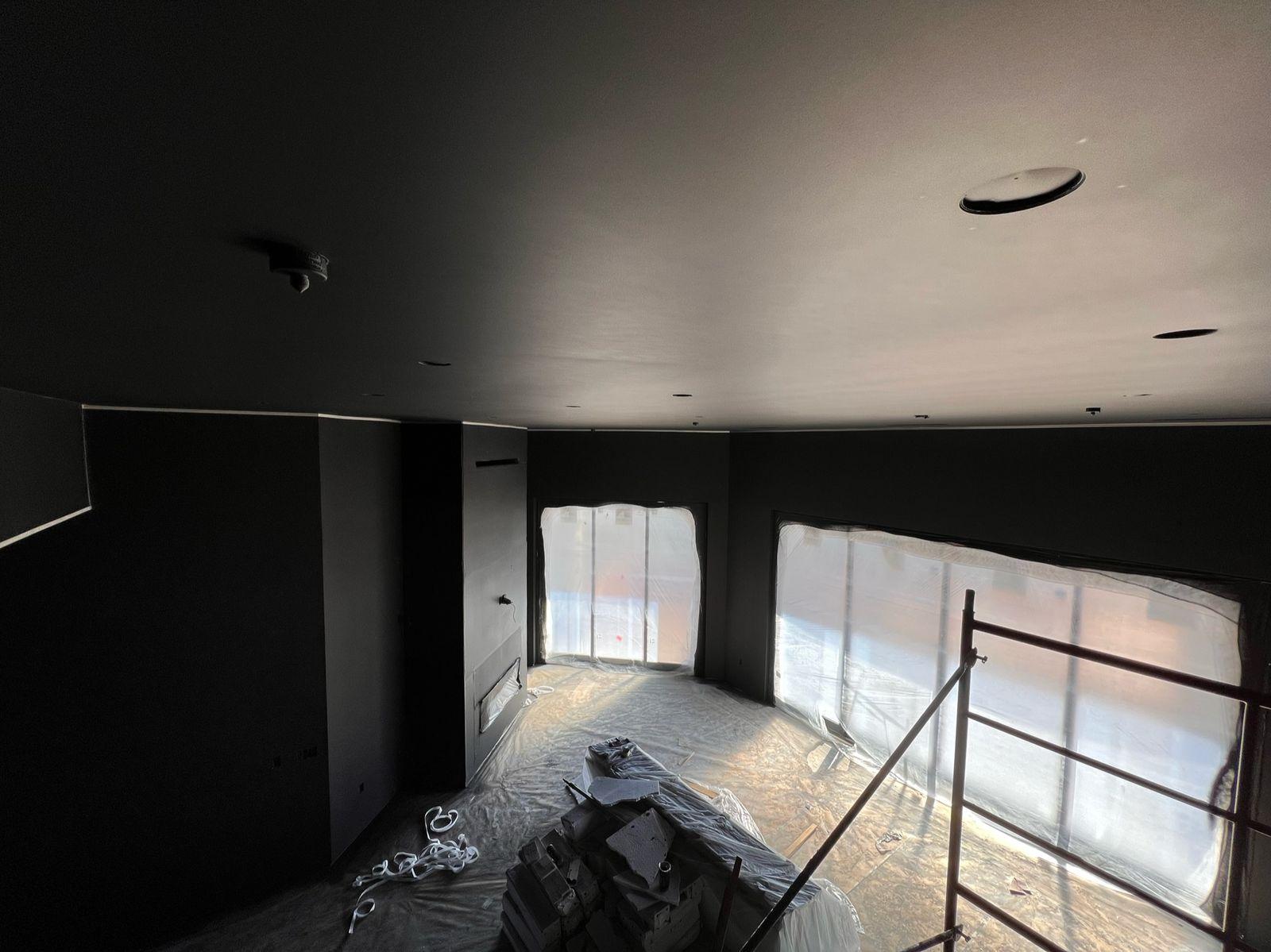

A room in its black shielding coat.

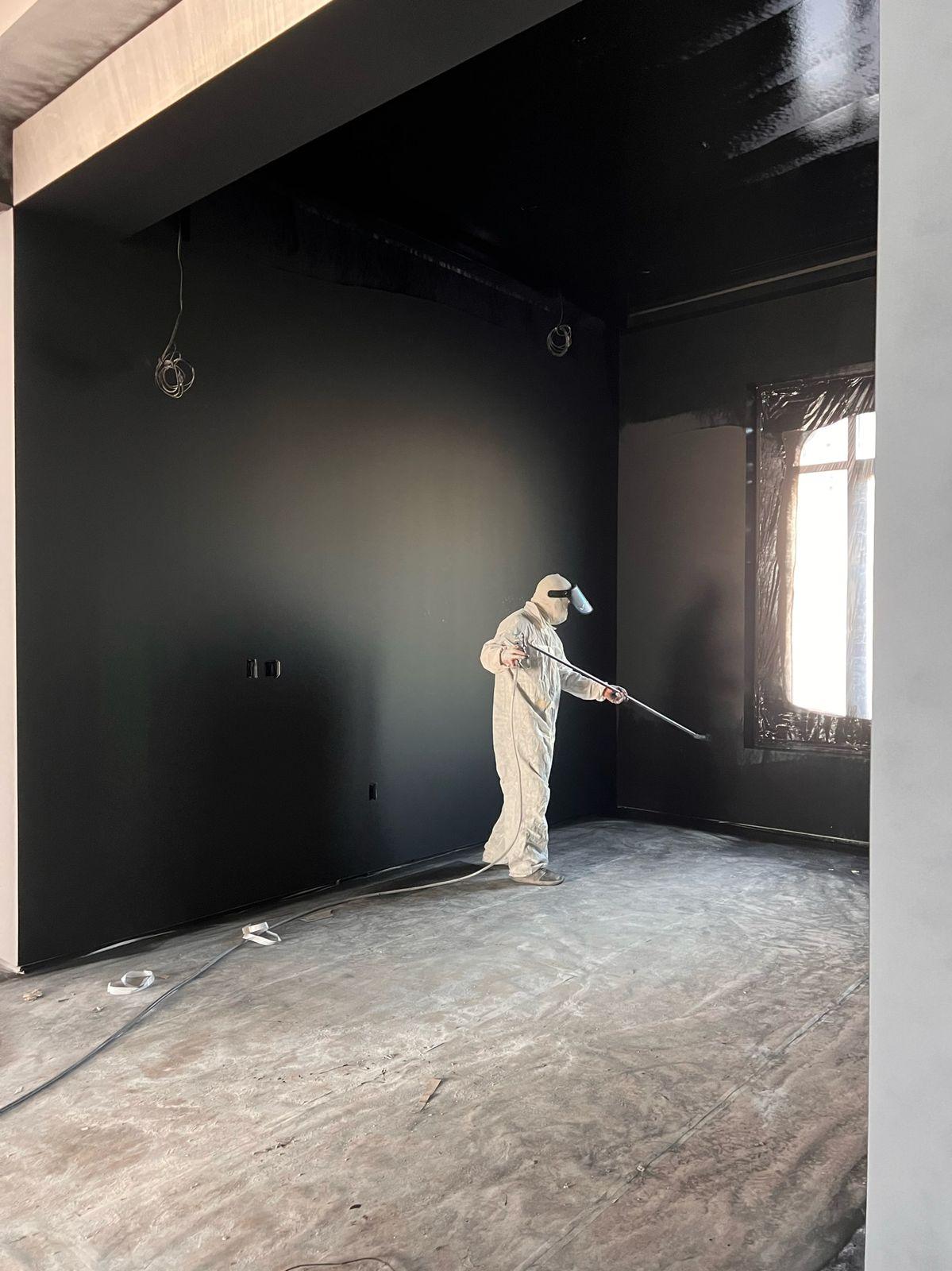

Spraying the shielding coat.

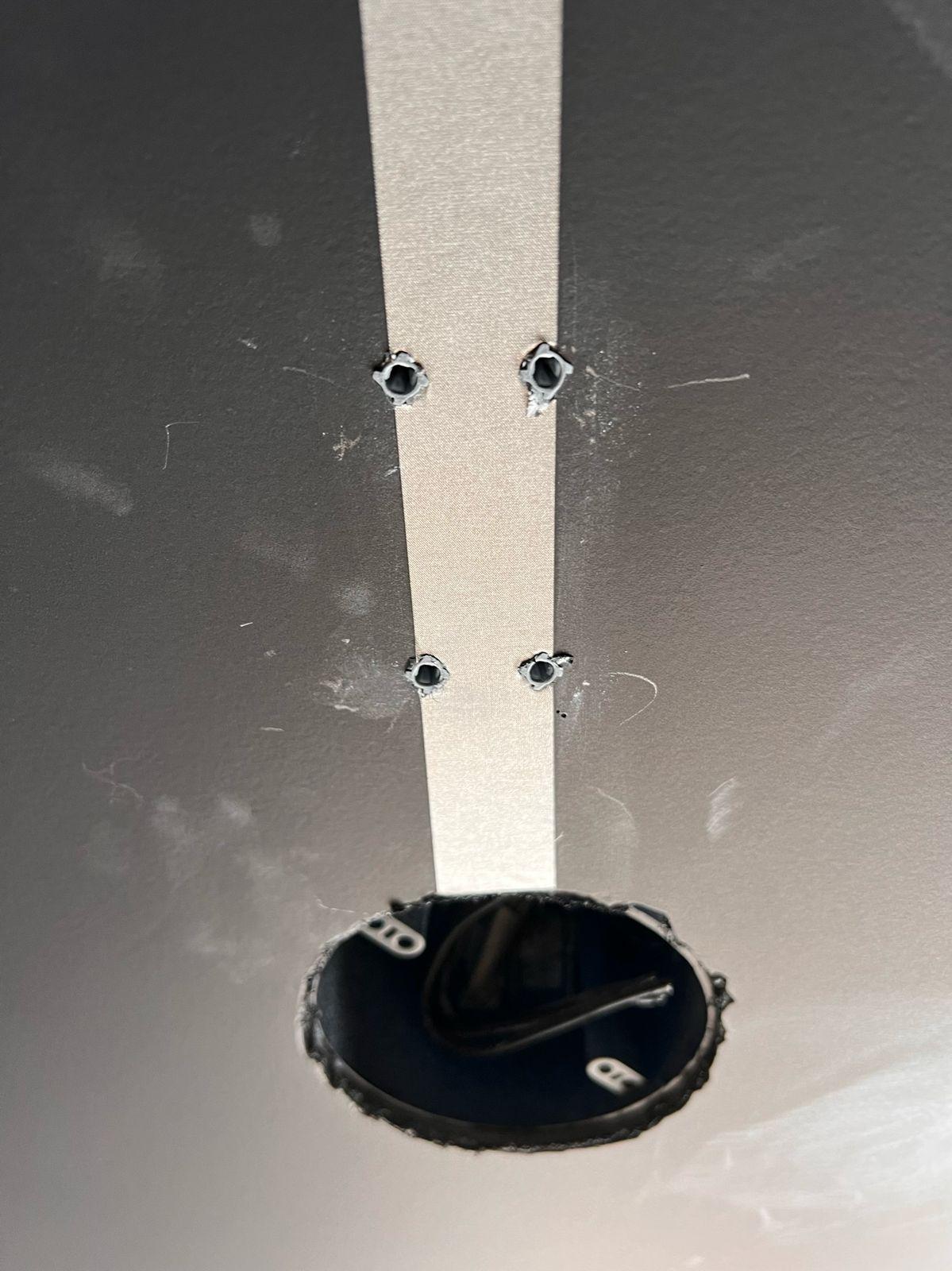

Grounding tape tying the coat to ground at a fixture box.

Phase 07

Site Work and Utilities

Retaining walls, utility trenches, and service lines go in around the house.

Site work around the shell.

Moving rock for the site work.

Conduit laid in the utility trench.

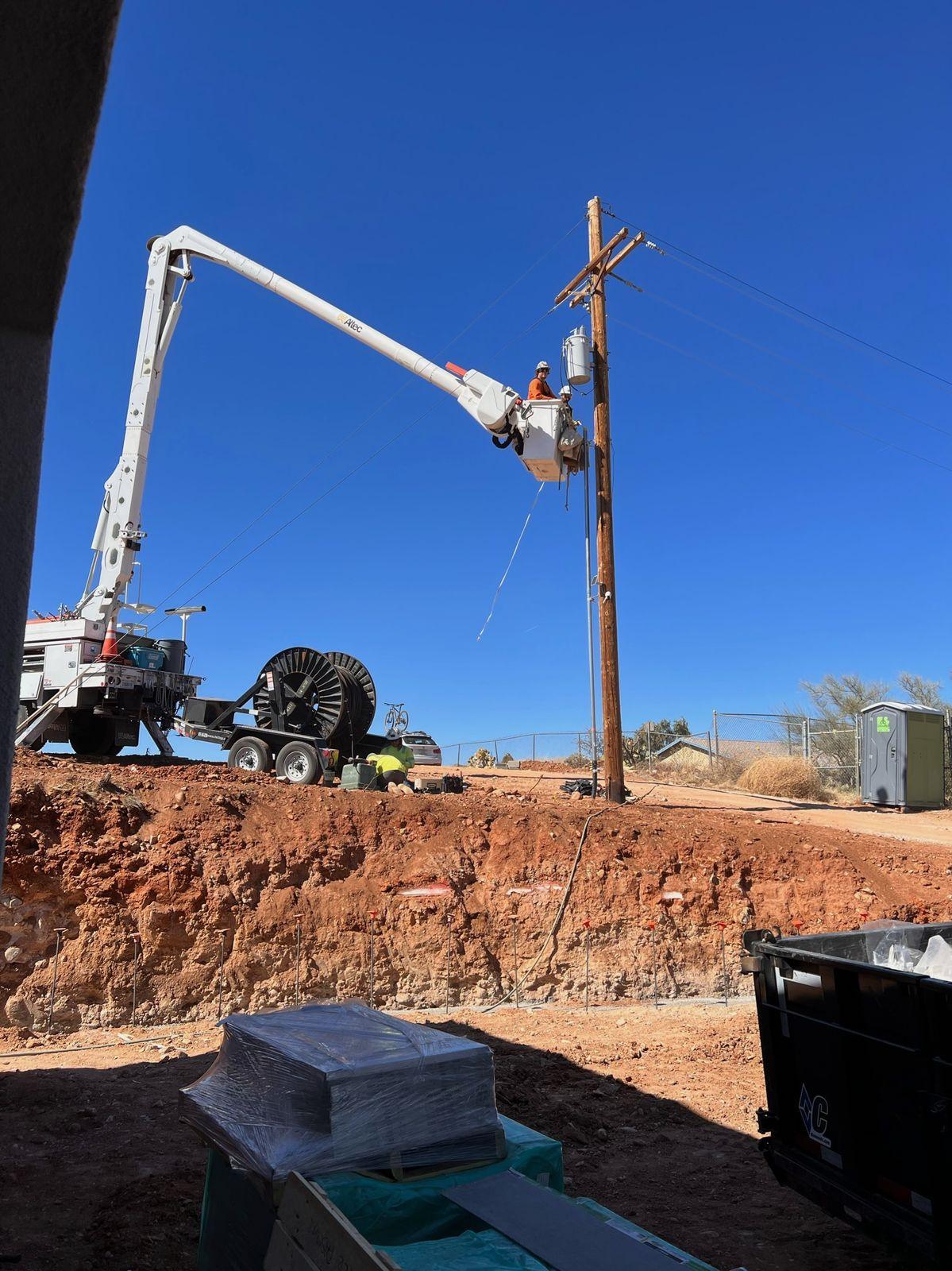

Service work at the pole.

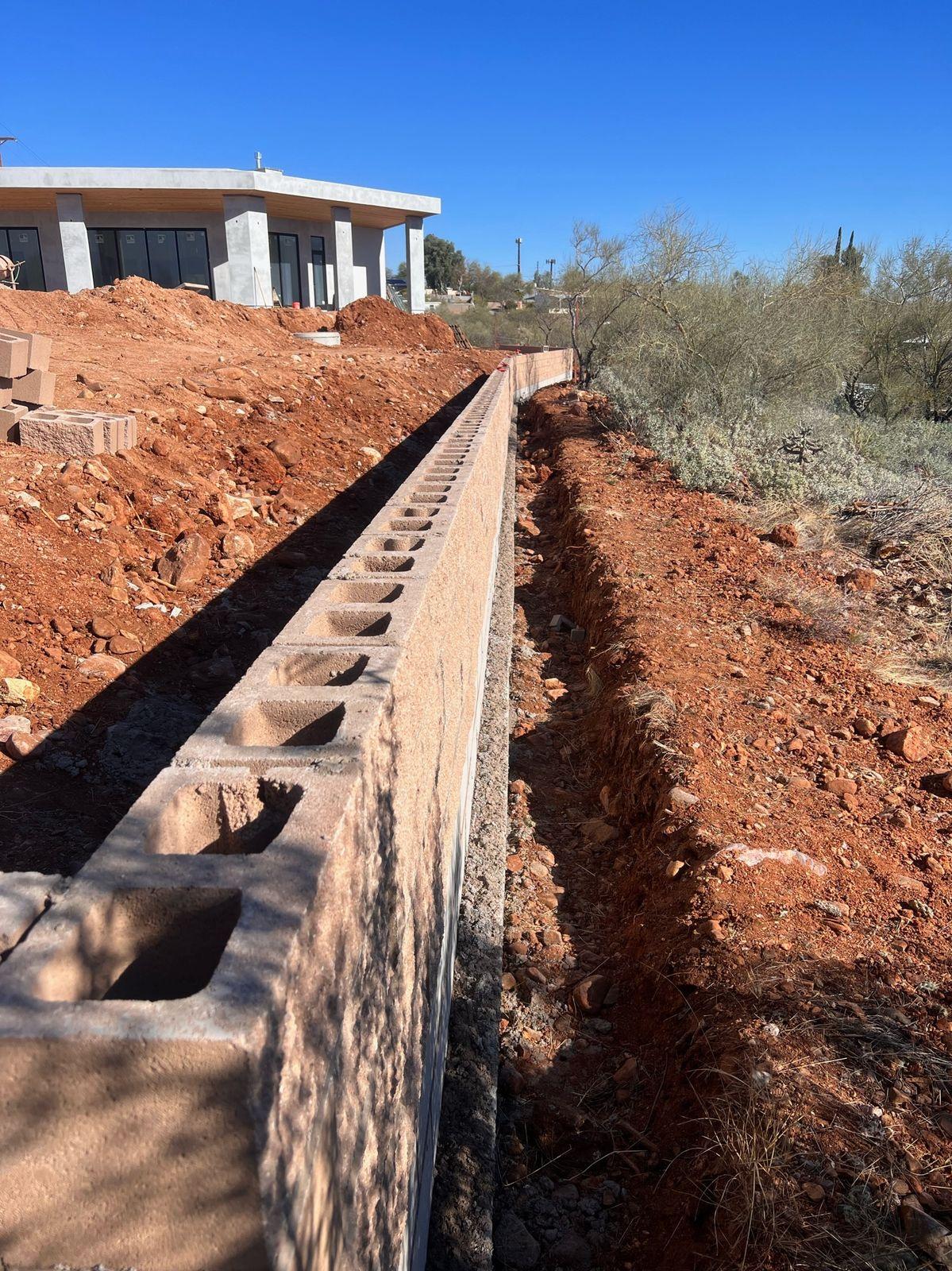

A retaining wall footing.

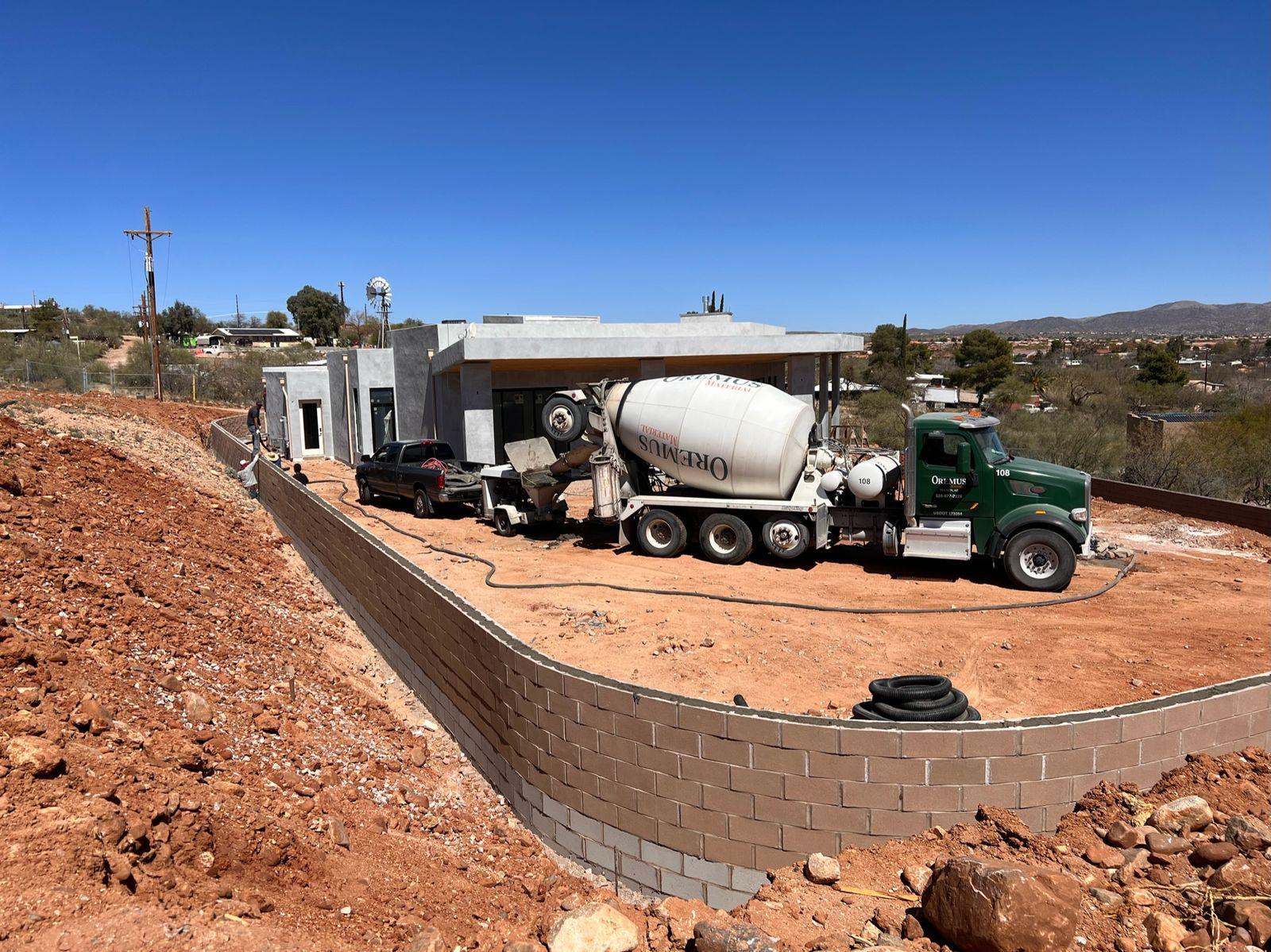

Pouring the retaining wall.

Phase 08

Health Systems

The systems that make it a healthy home: filtered and structured water, air handling, hot water, and clean power.

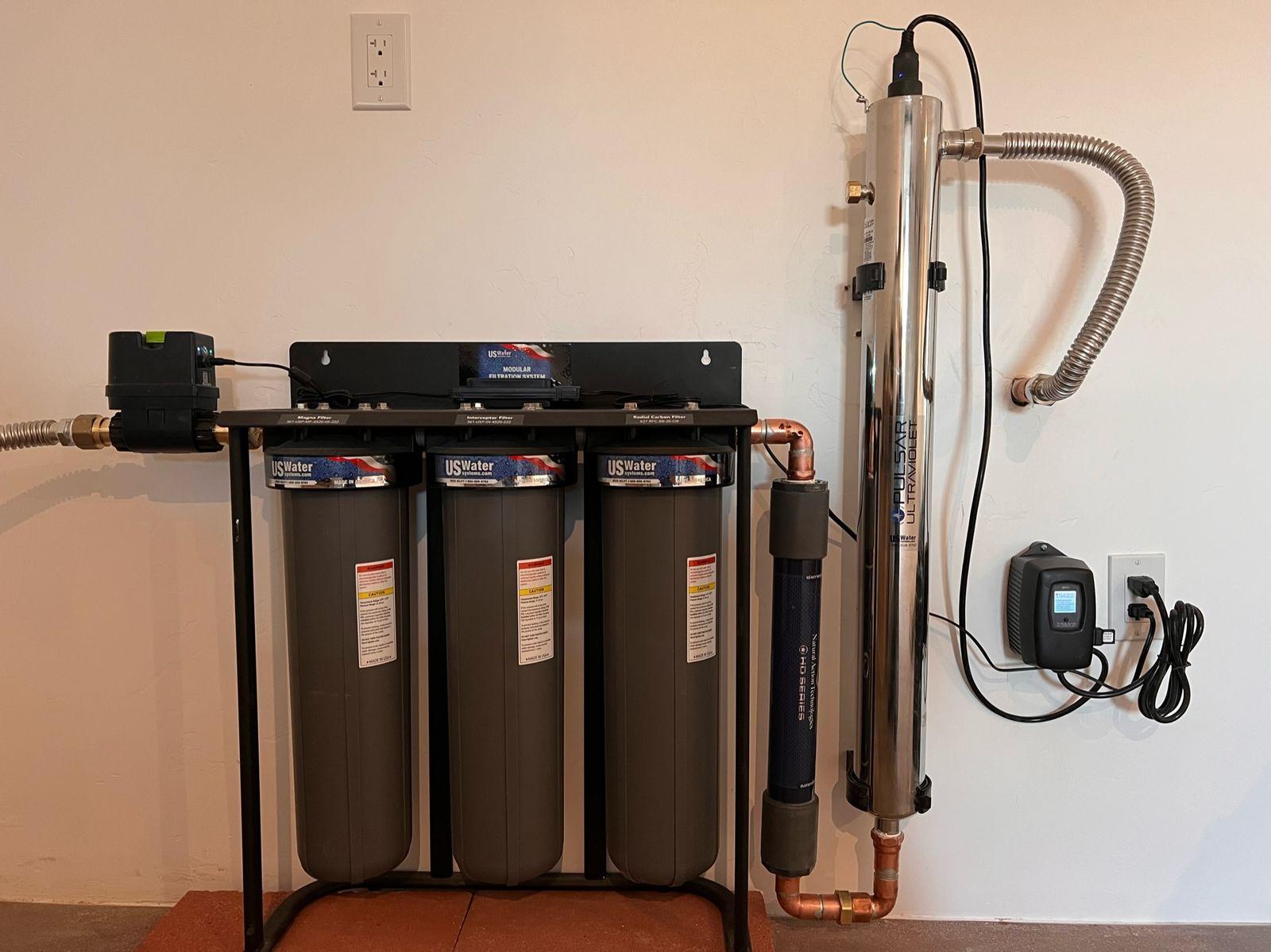

Whole-home filtration with UV treatment.

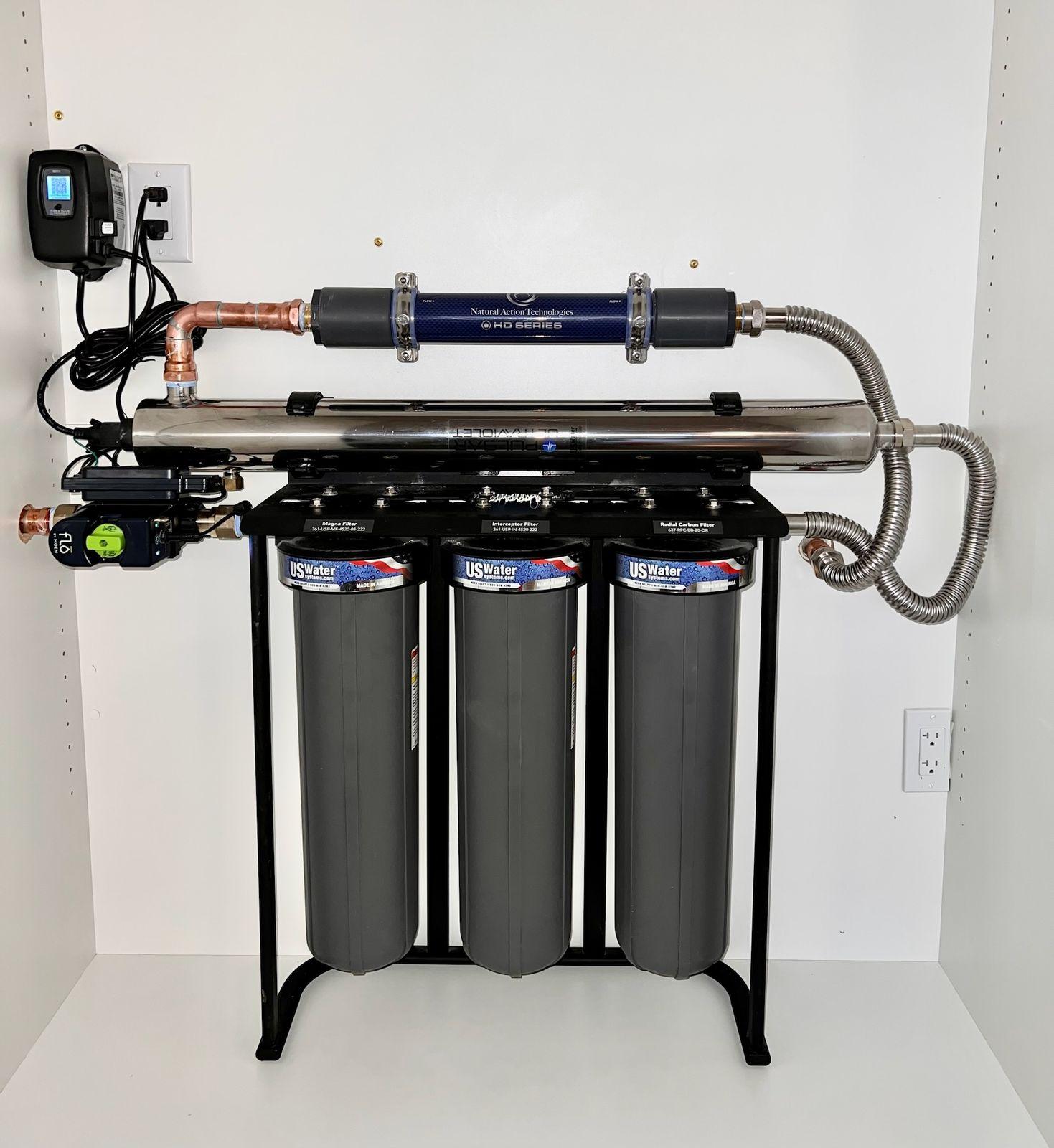

The structured water filtration assembly.
Natural Action Technologies structured water units.
Structured water units on the supply line.

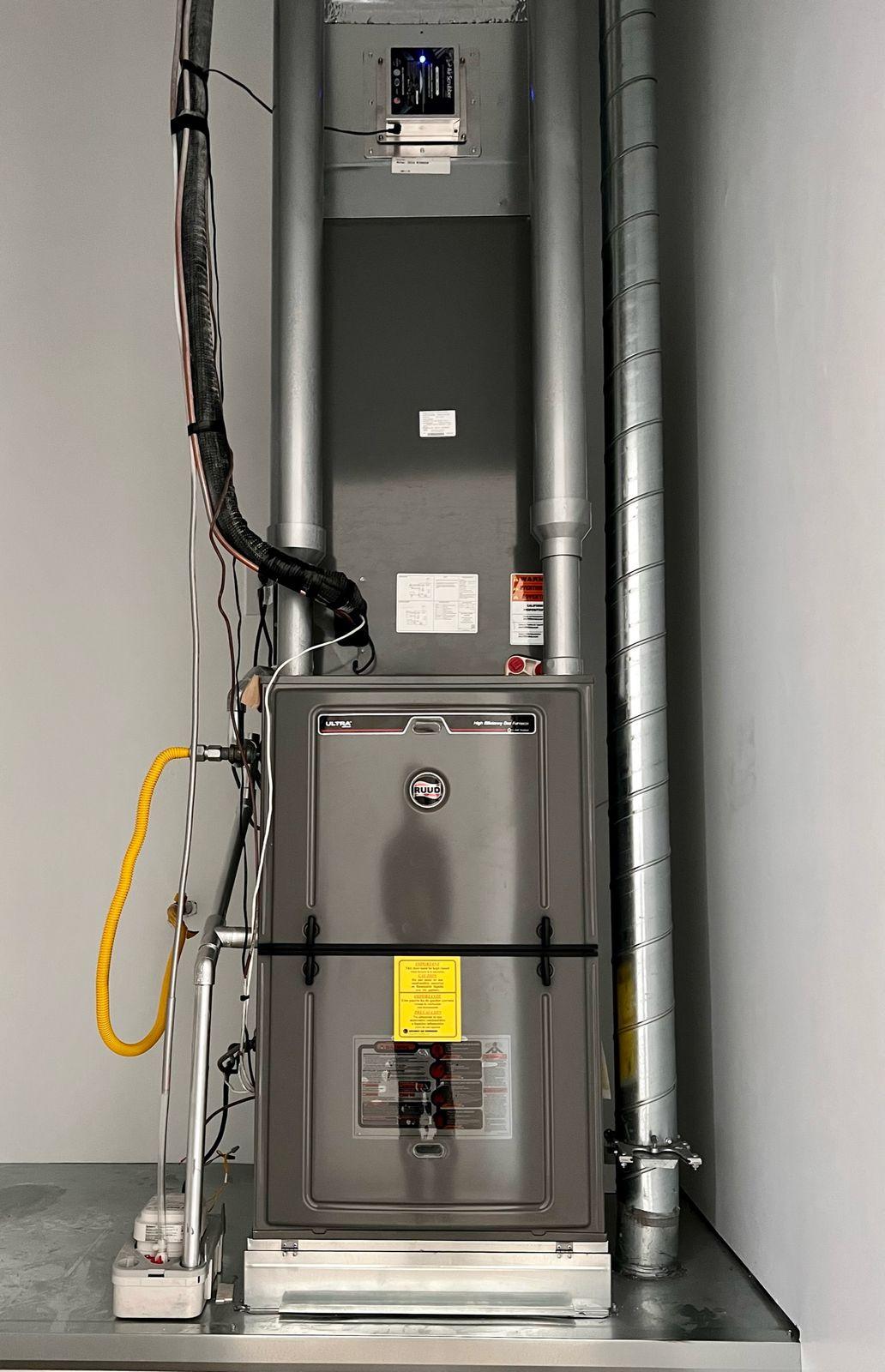

The air handler.

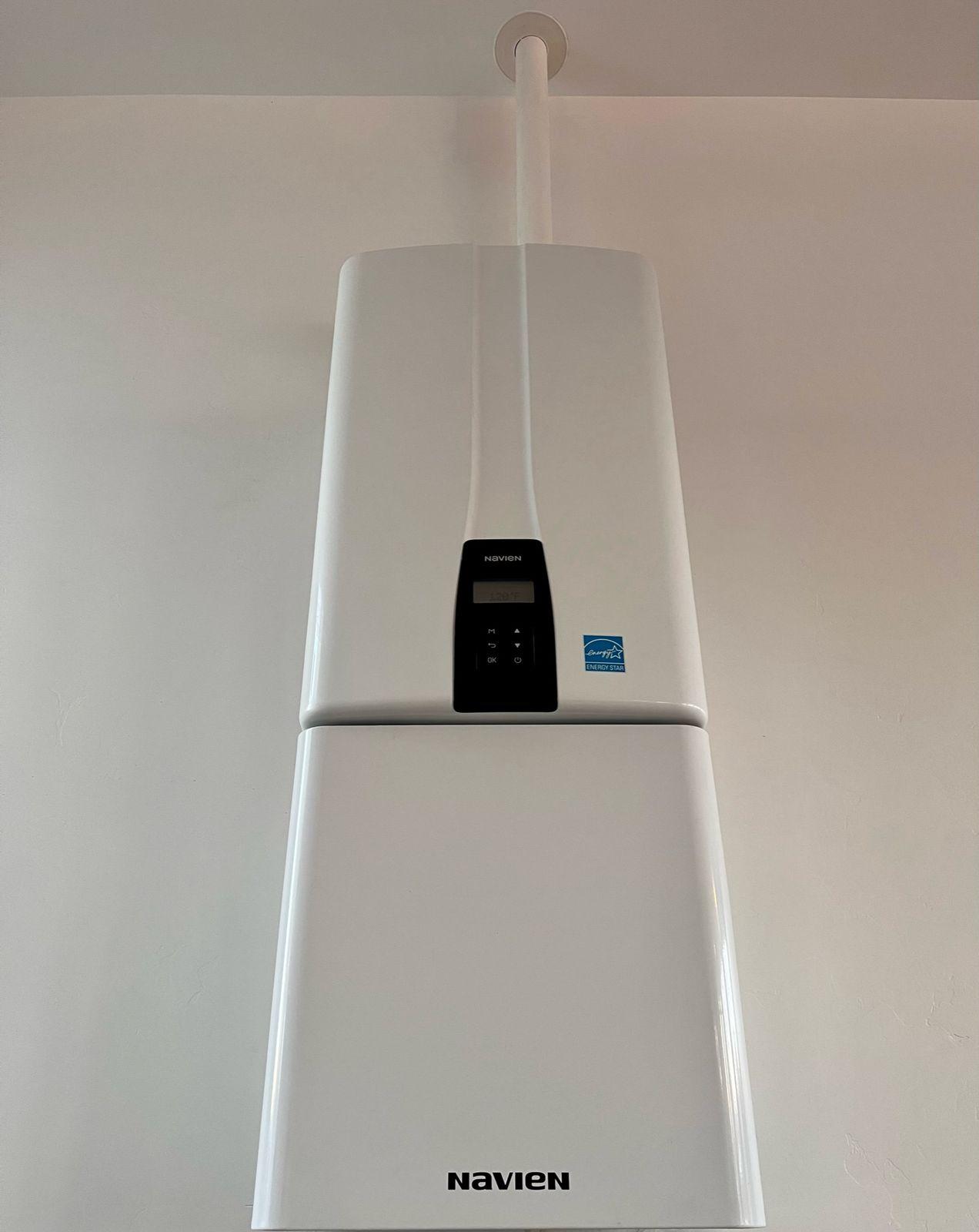

The tankless water heater.

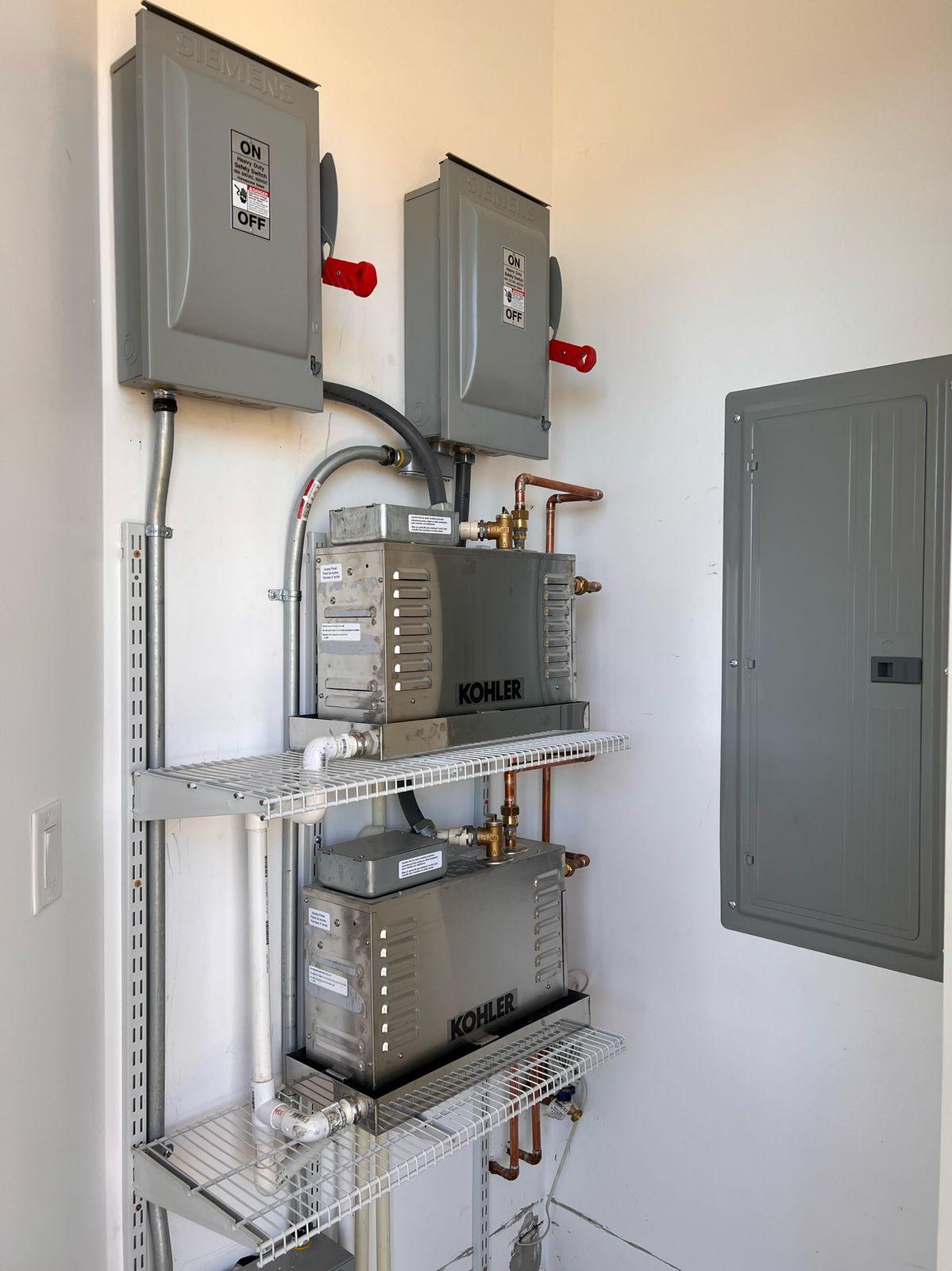

The electrical service.

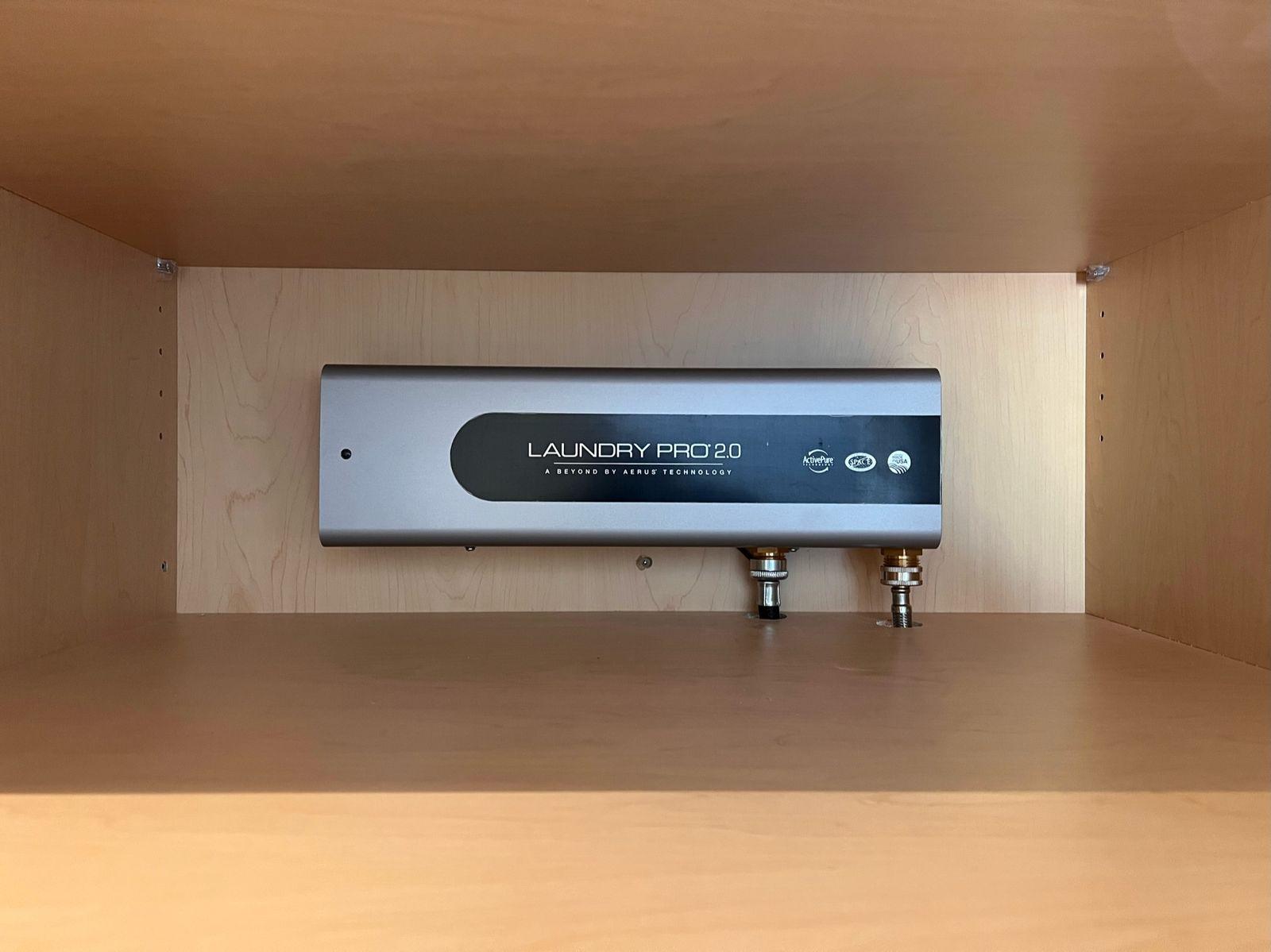

Laundry Pro 2.0, for laundry without detergent chemicals.

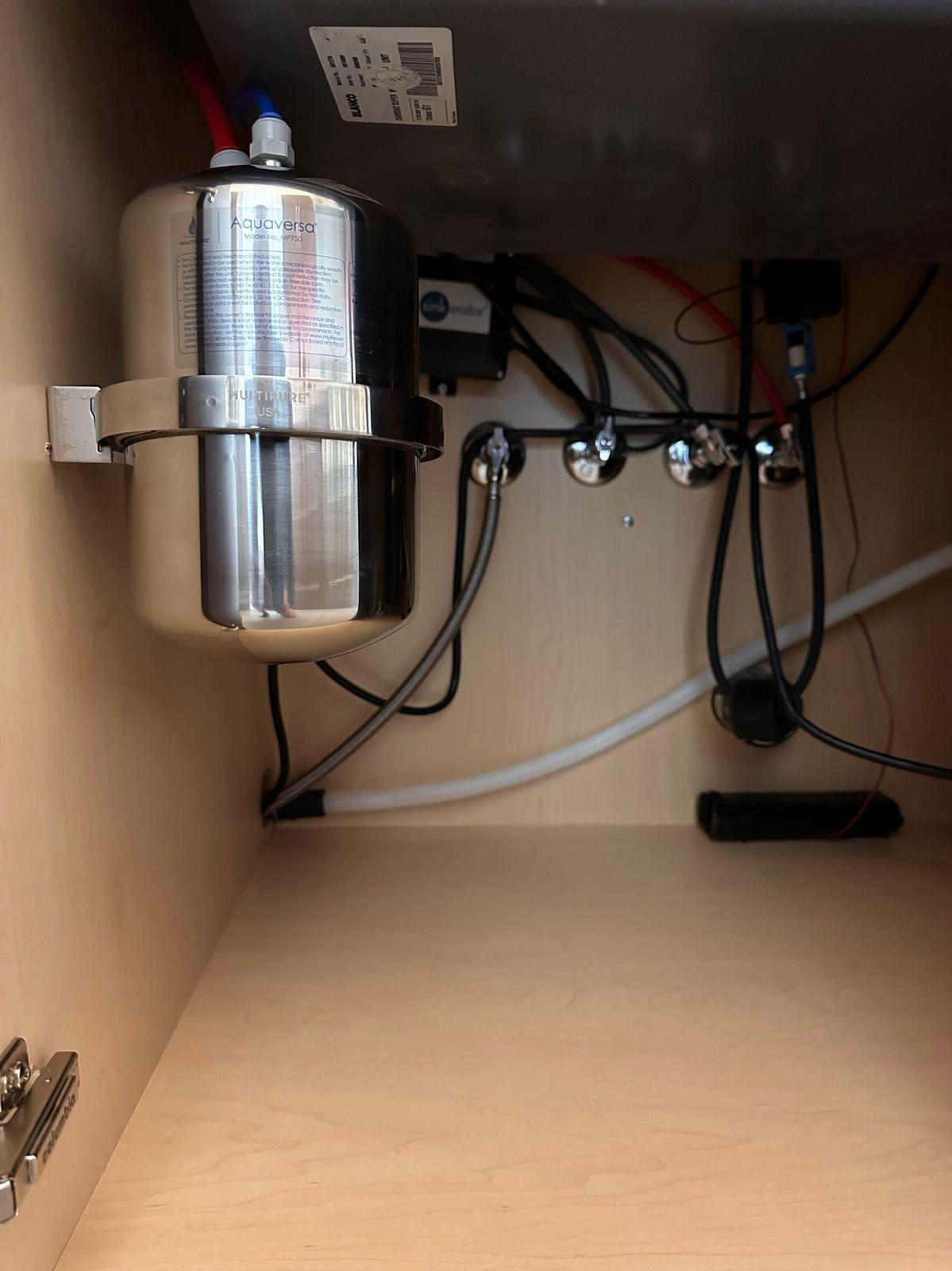

A point-of-use filter under the sink.
Brian Johnson in the mechanical room with the whole-home water system.

Brian Johnson at the structured water vessel in its cabinet.

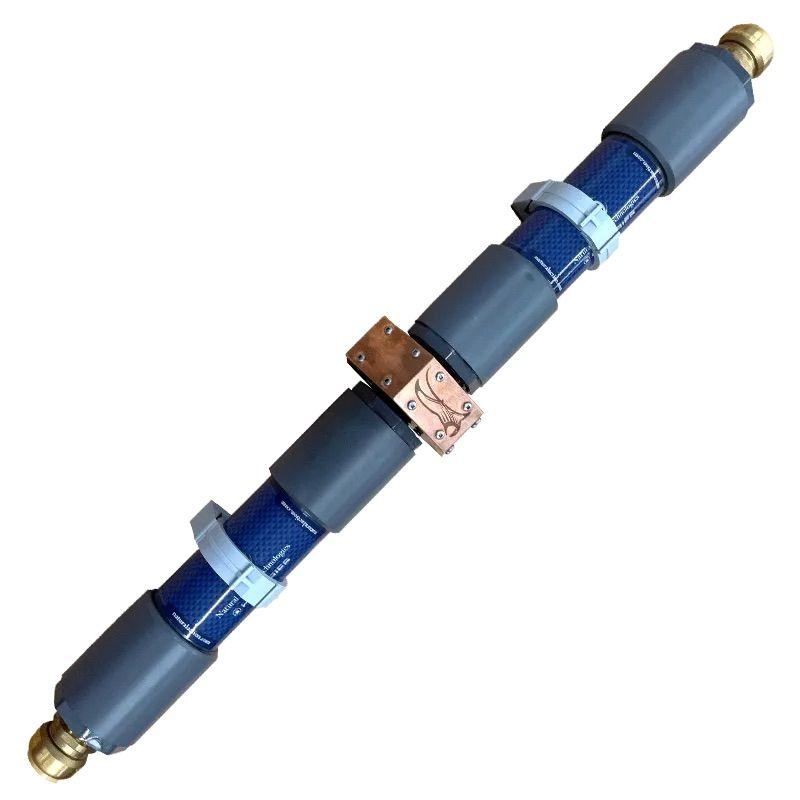

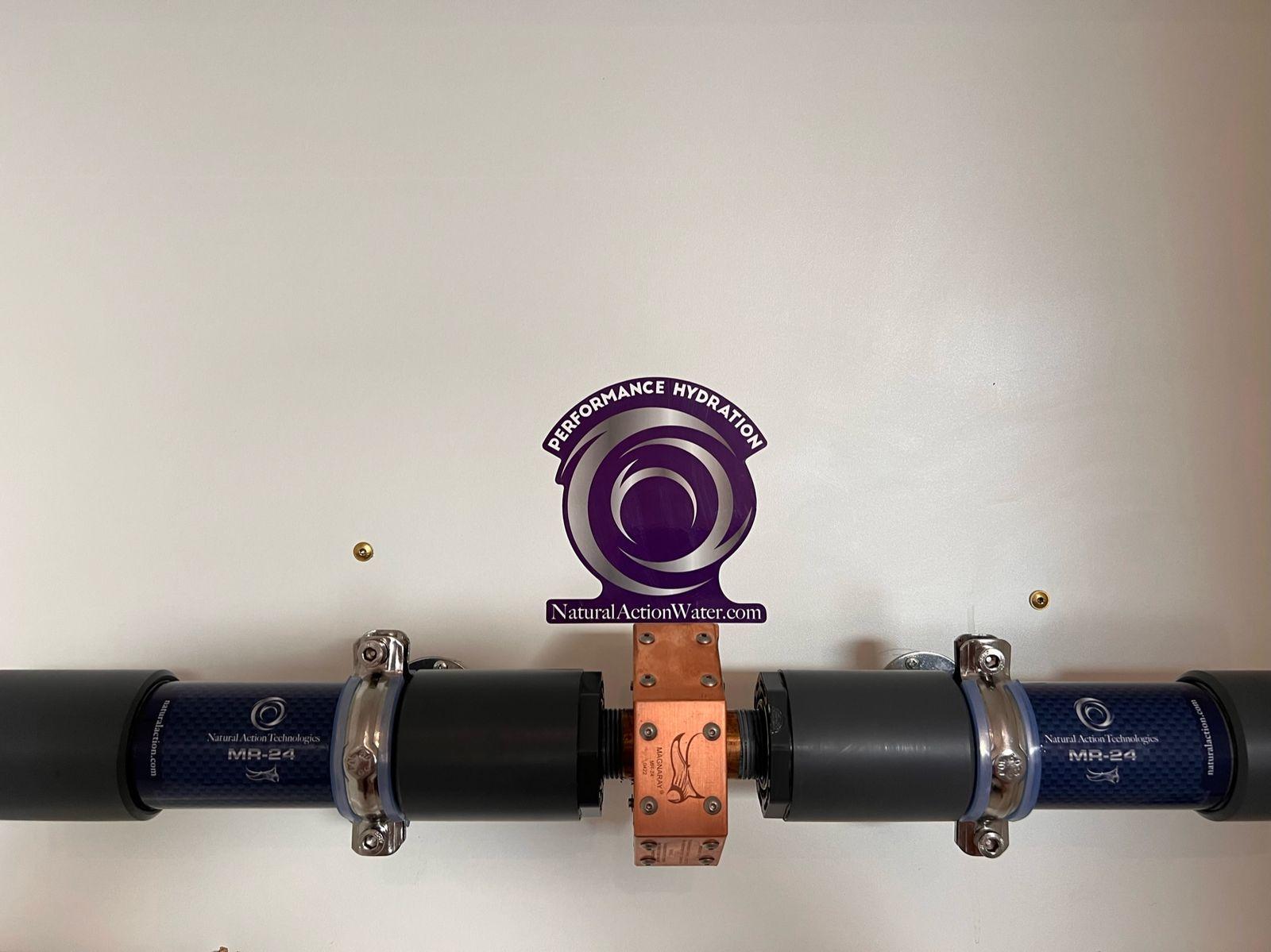

A Natural Action inline structured water unit.

Phase 09

The Finished Home

Stone, wood, glass, and the light of the Catalinas.

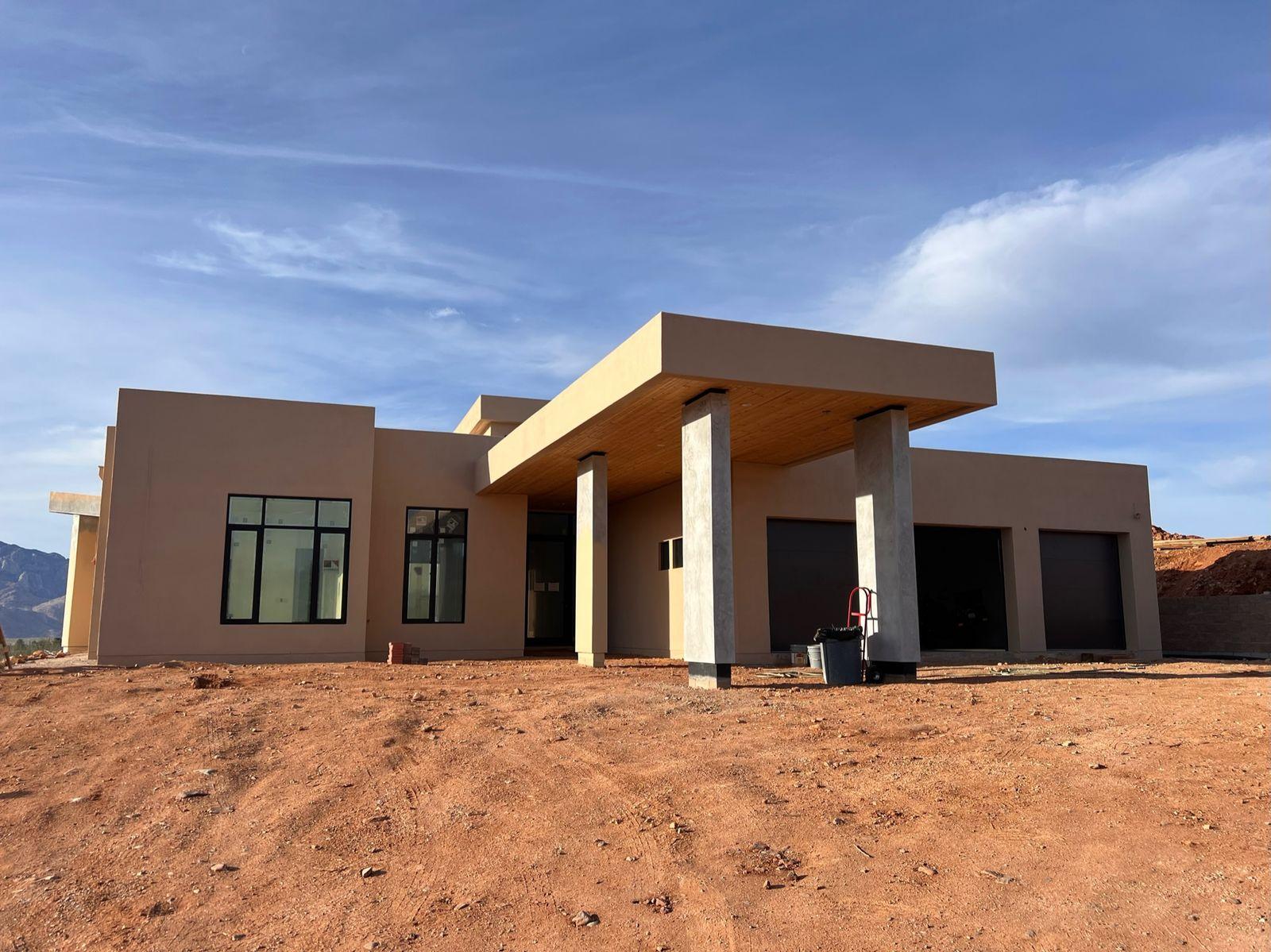

The finished house.
The entry canopy.

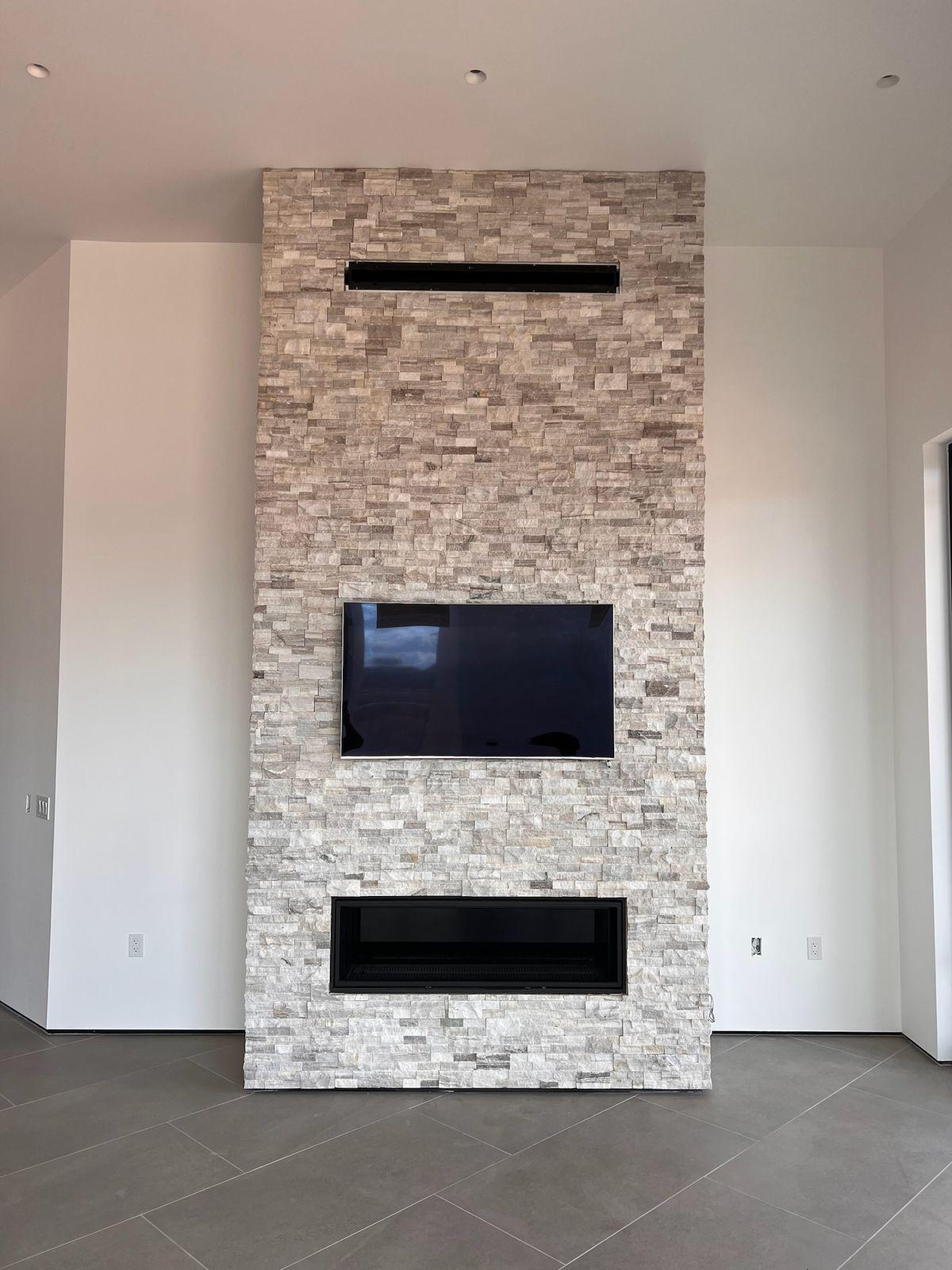

The stacked-stone fireplace wall.
The kitchen.

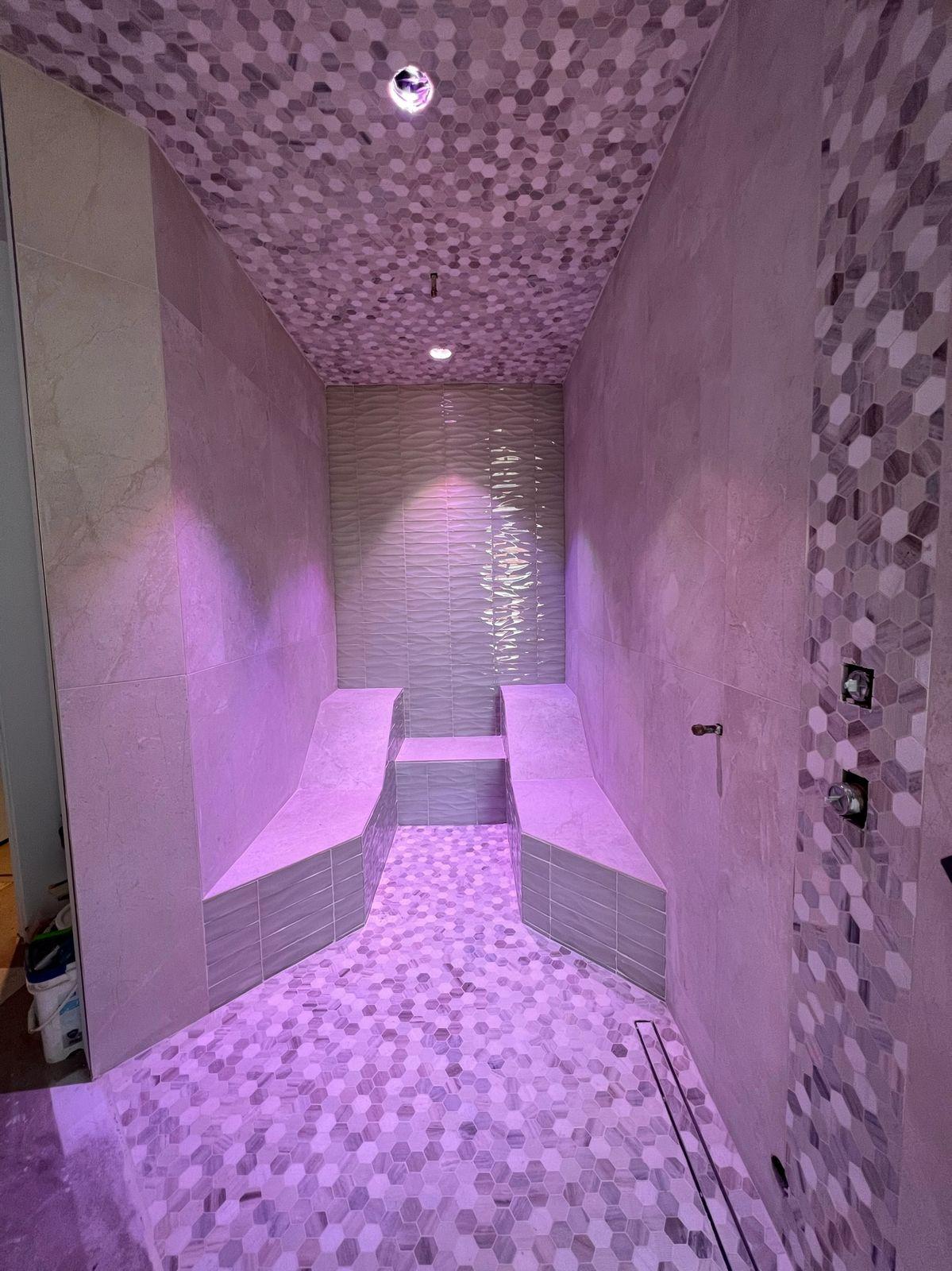

The steam room.
The primary bath.

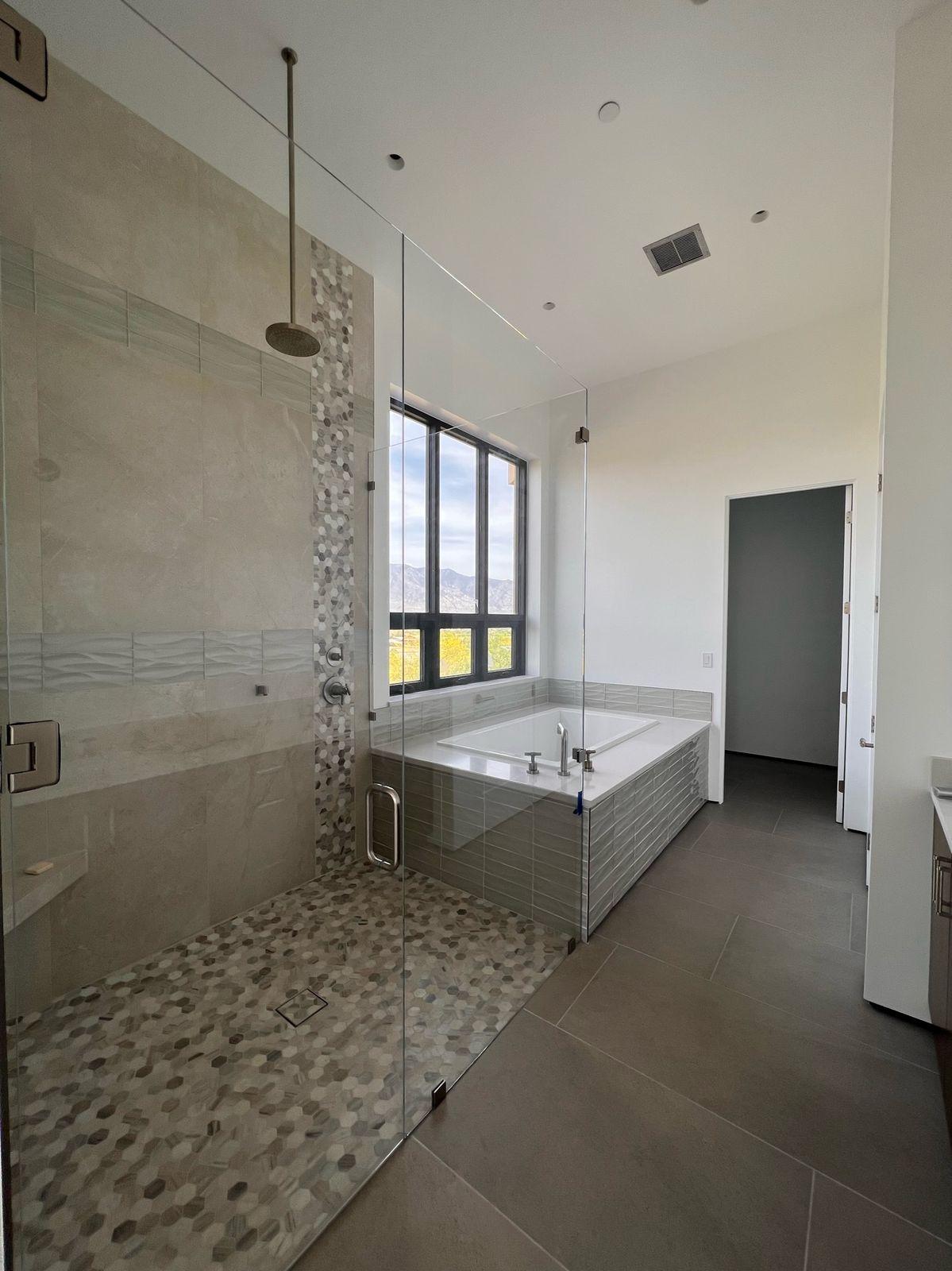

The walk-in shower.
The hallway.

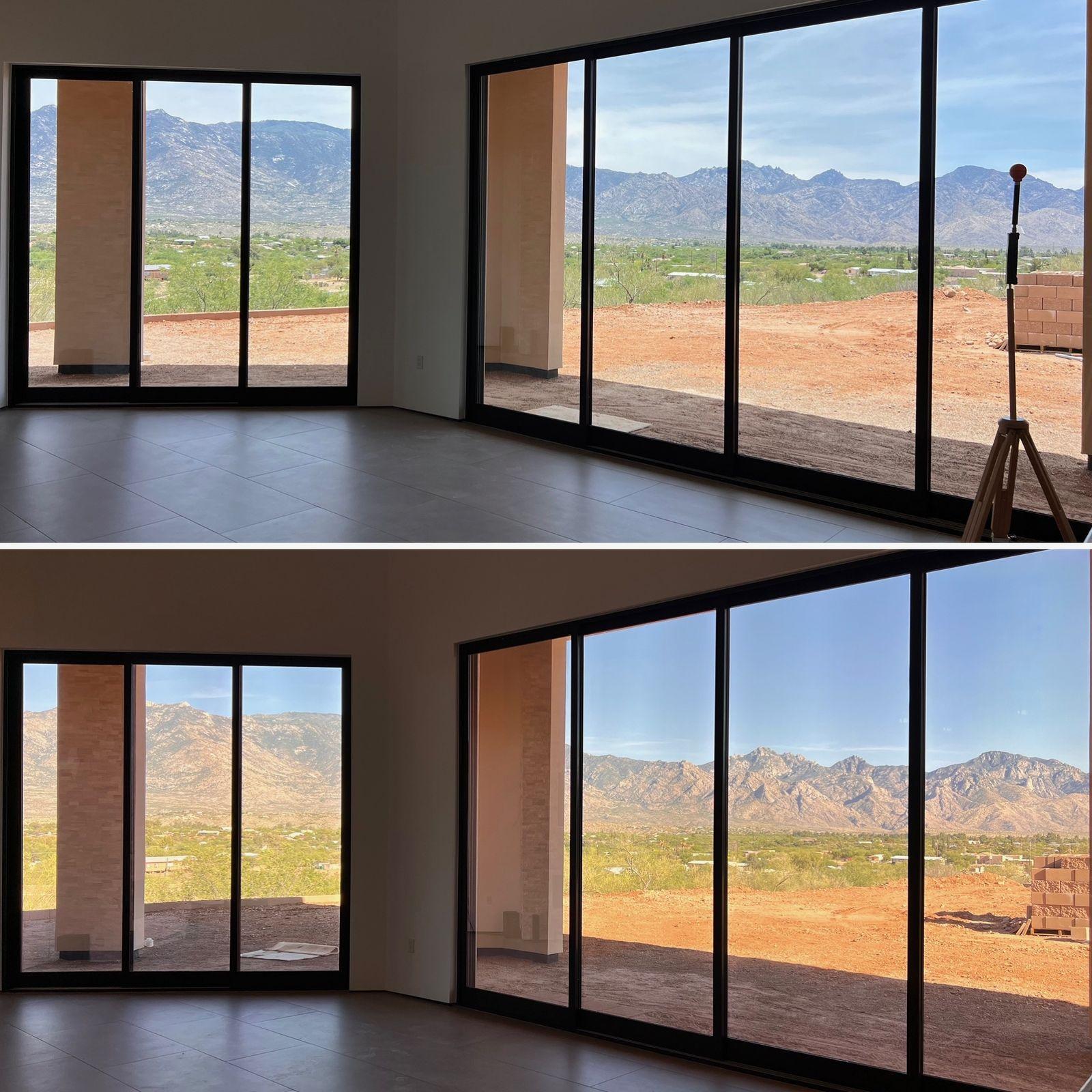

Glass facing the mountains.
A rainbow over the finished house.
The house at night.
The steam shower.
The steam shower bench.
The steam shower with its color lighting on.
The laundry room.

Phase 10

Testing and Verification

Before move-in, the house is tested: air tightness, electric and radio frequency fields, light, air, and water.

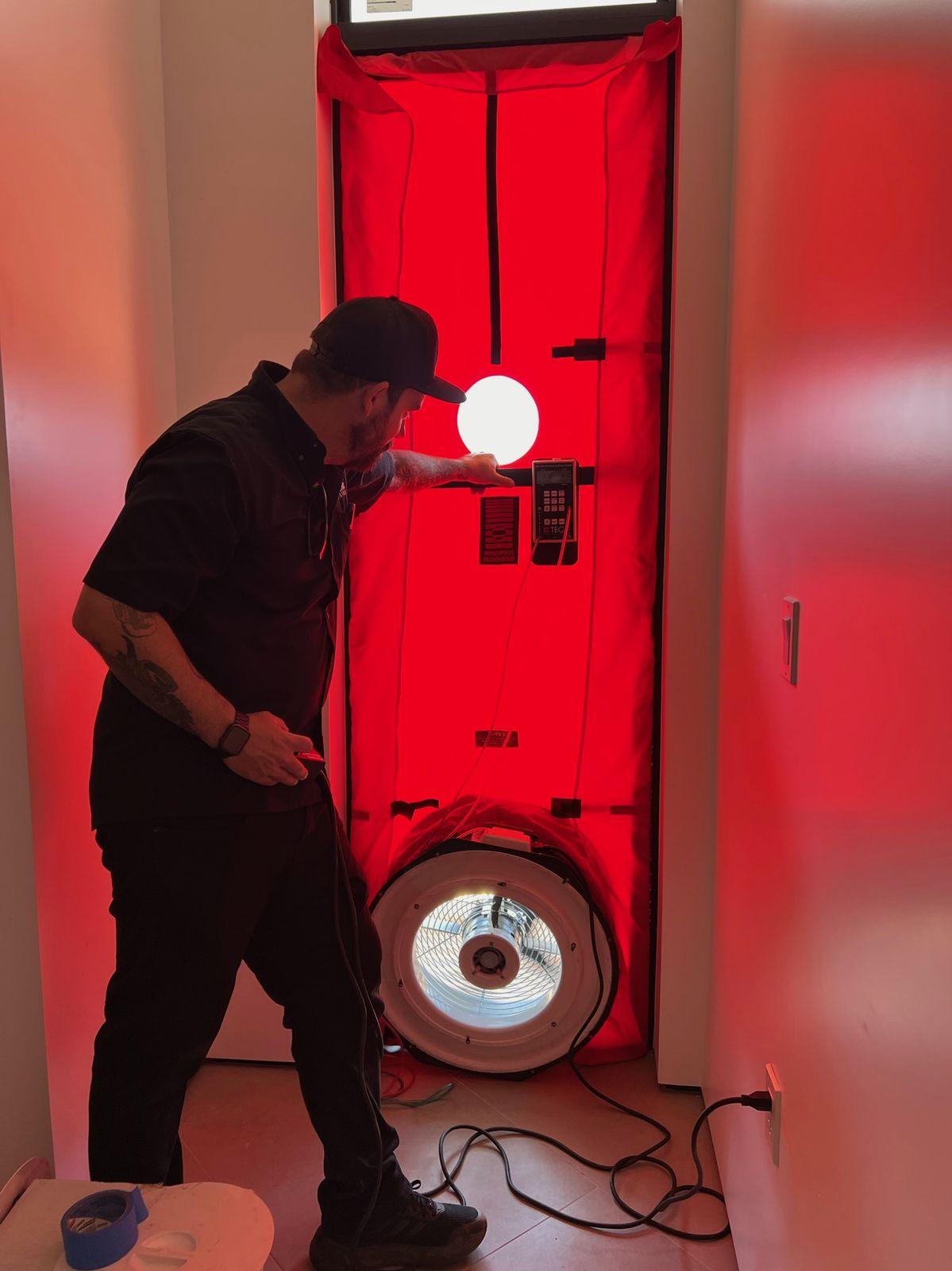

A blower door test measures air tightness.

Checking outlets for electric fields.

Measuring radio frequency levels.

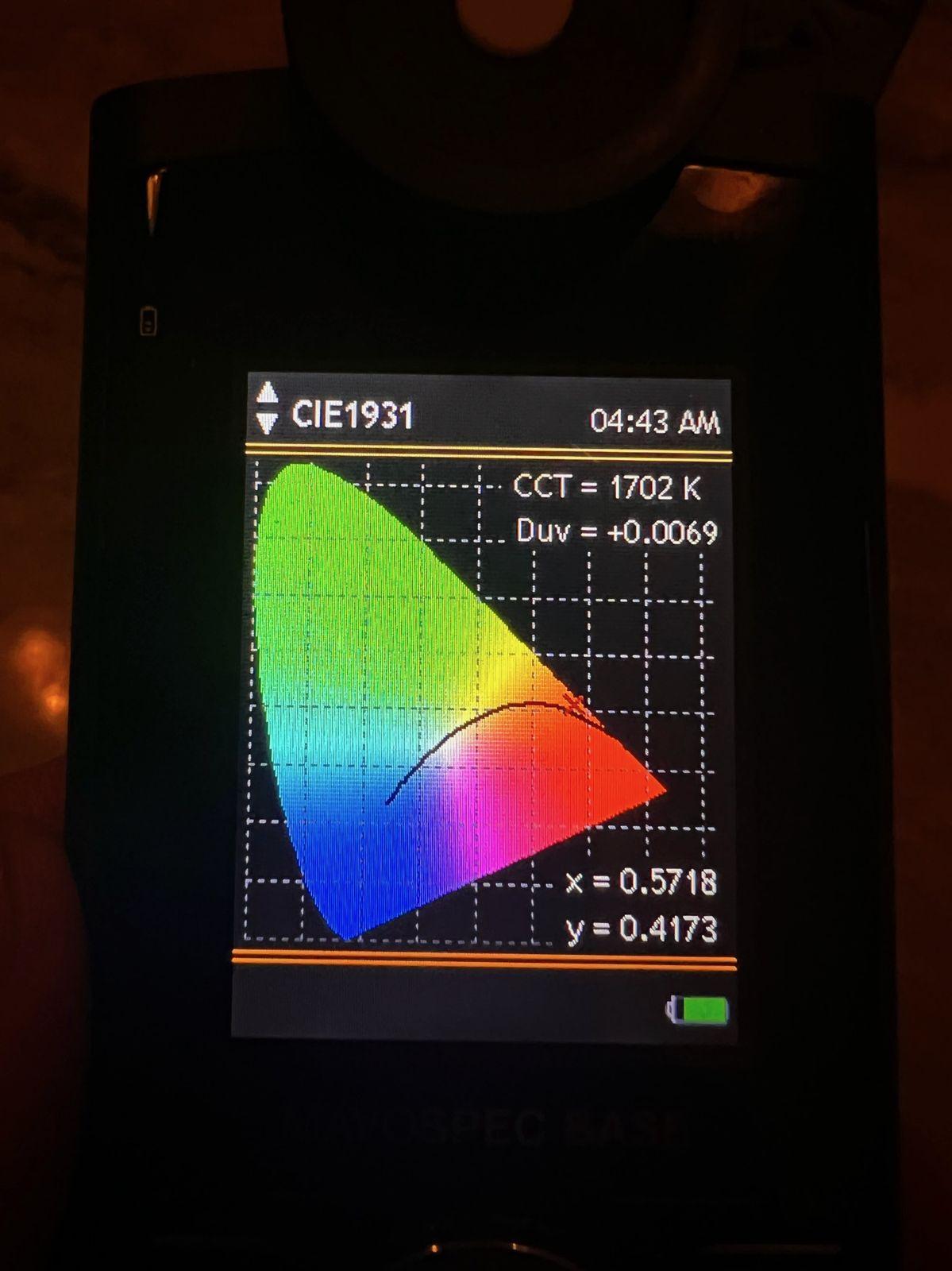

Light spectrum: 1702 K, a warm evening color temperature.
Brian testing the living spaces.
Testing in the kitchen.

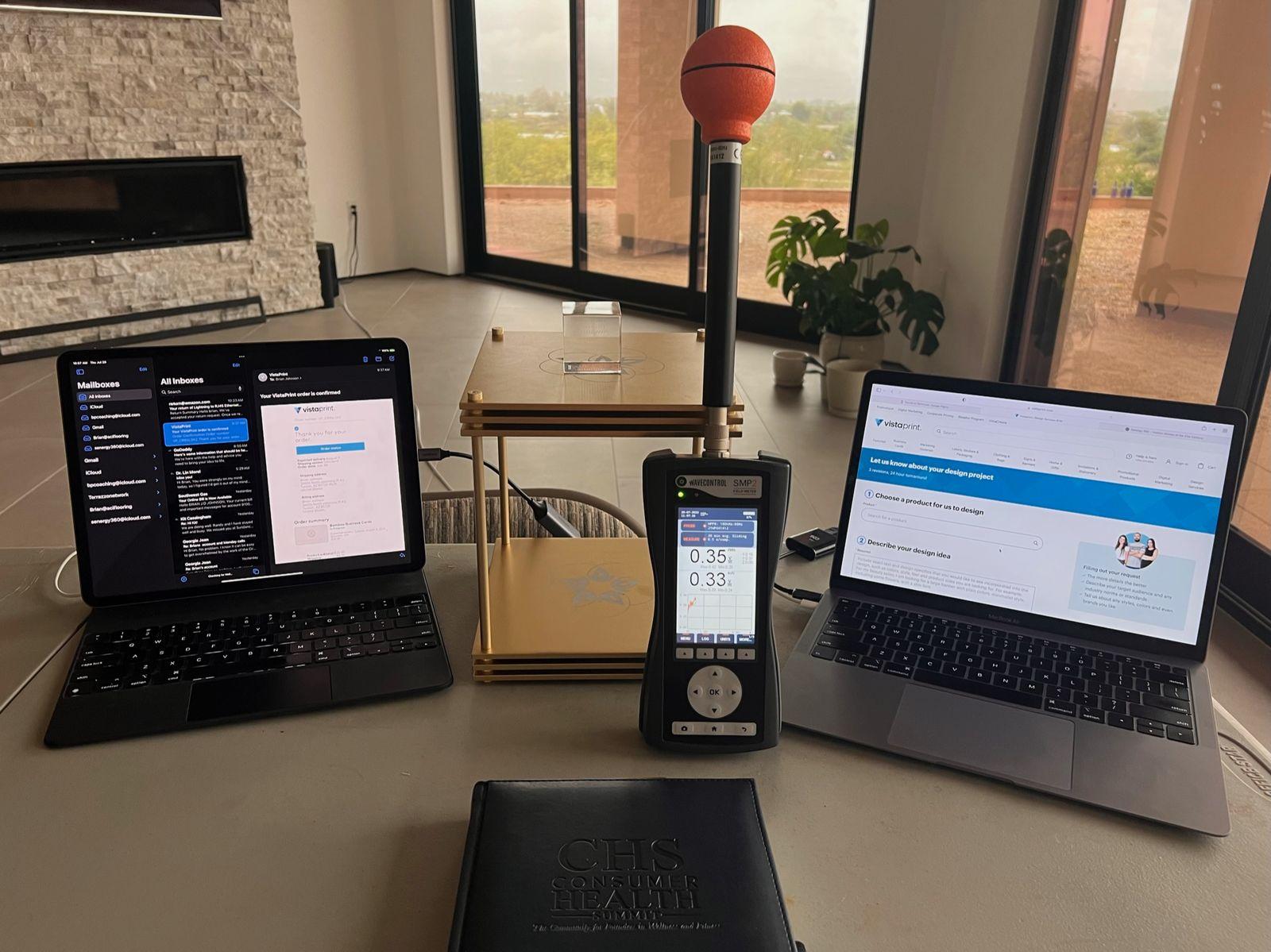

The testing setup.

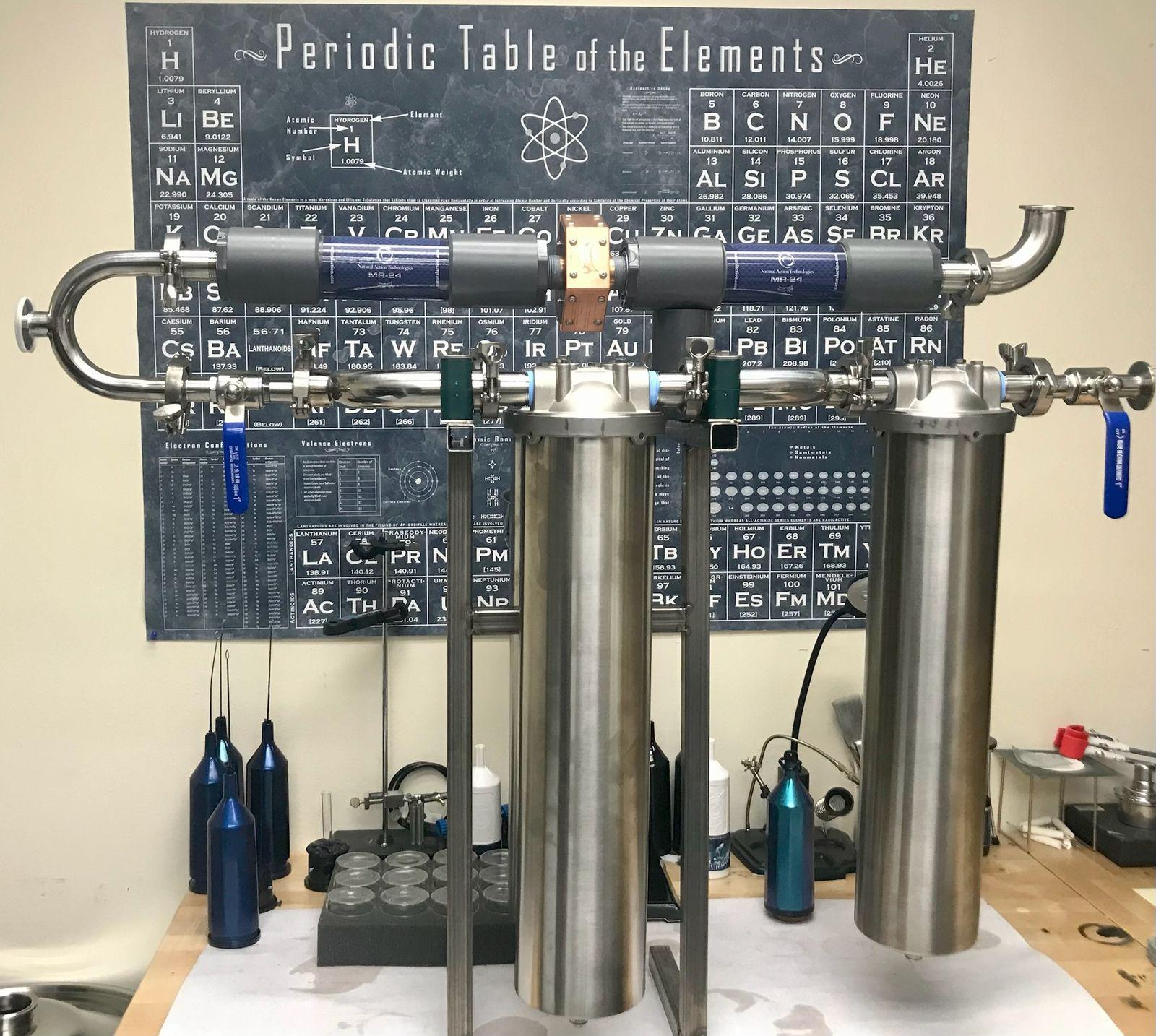

The finished water system.
The meters used to verify the home.
The view the house was built for.
Testing the water: strips, a TDS meter, and sample vials.
